Larkspur
Click on photos to enlarge:
-

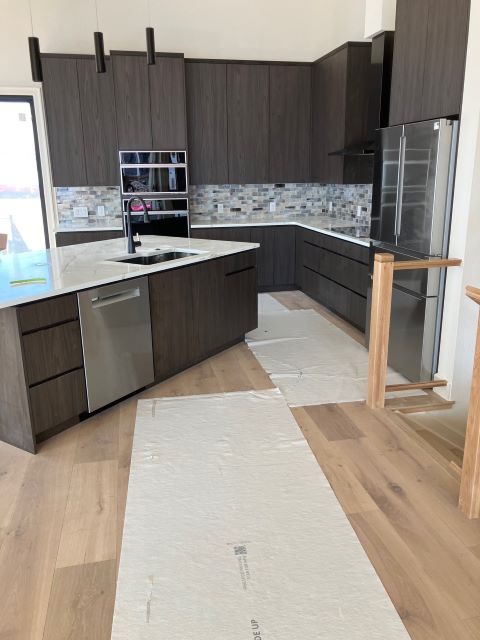

Completed kitchen
-

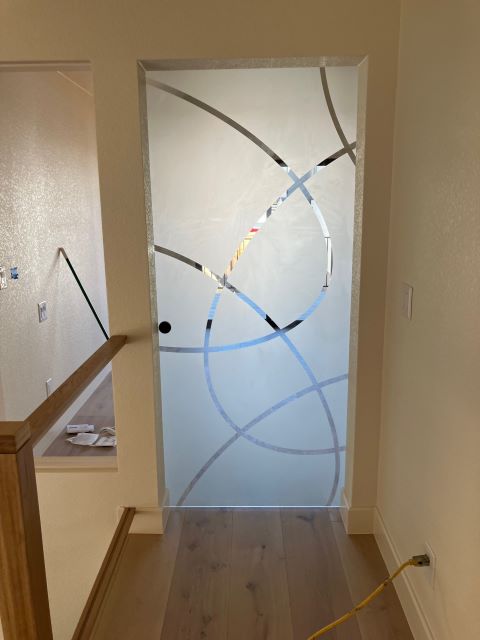

Barn door completed
-

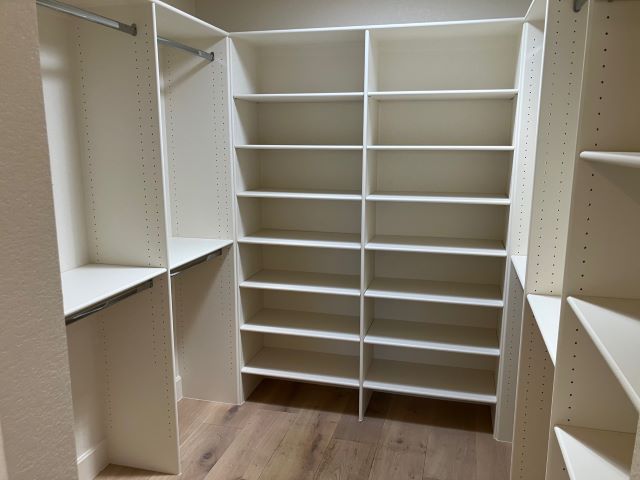

Custom closet completed
-

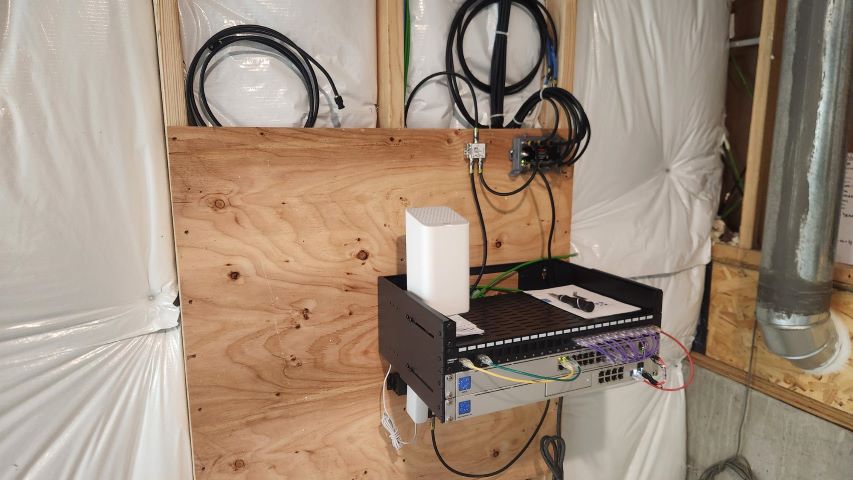

Low voltage center
-

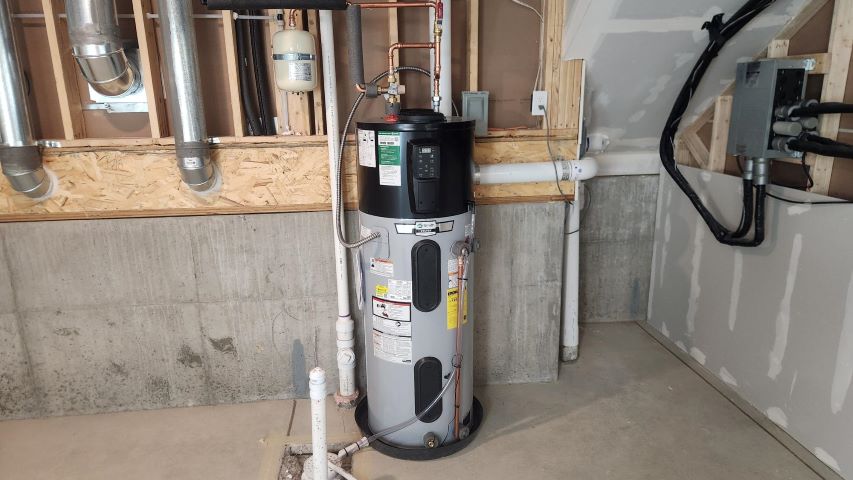

Hot water heater
-

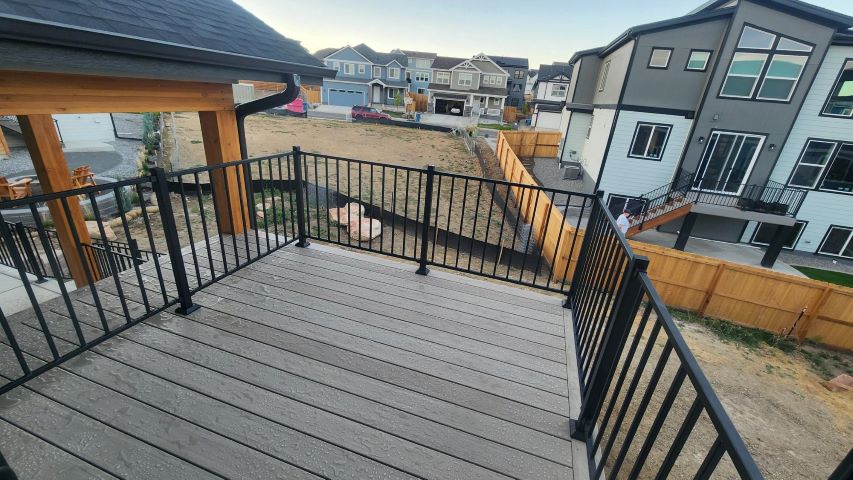

Deck and railing completed
-

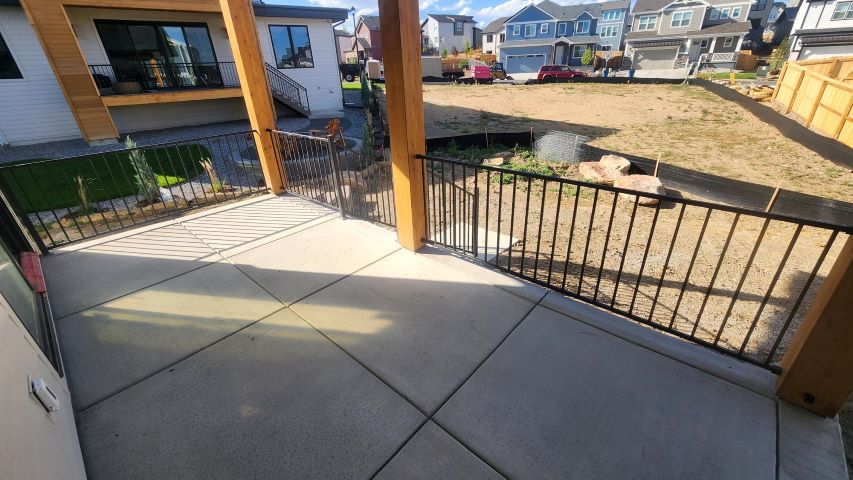

Rear porch railingsÂ
-

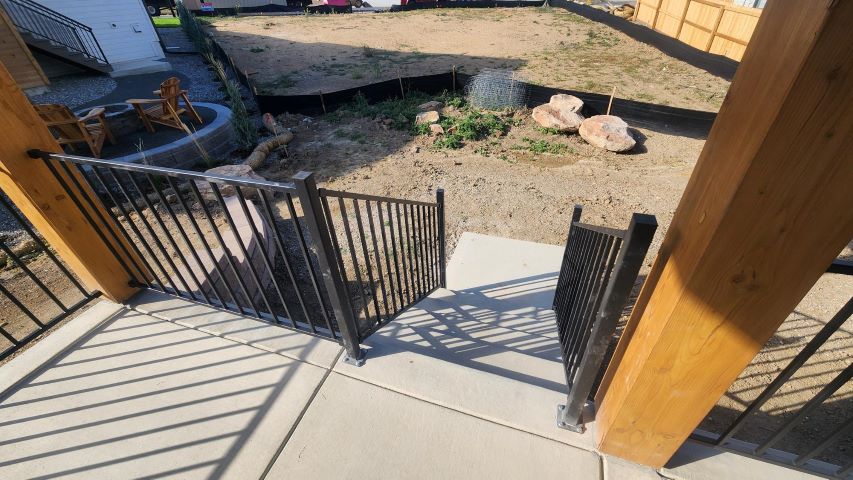

Stair railings on rear covered porch
-

Downspout modification for better drainage control
-

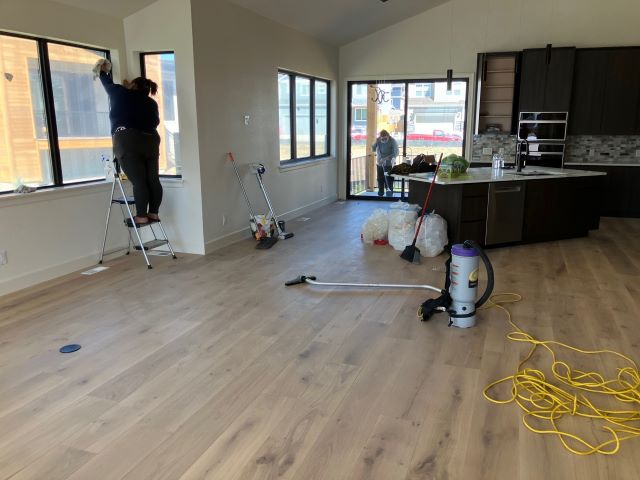

Crew handling final cleaning details
-

Jim adjusting barn door
-

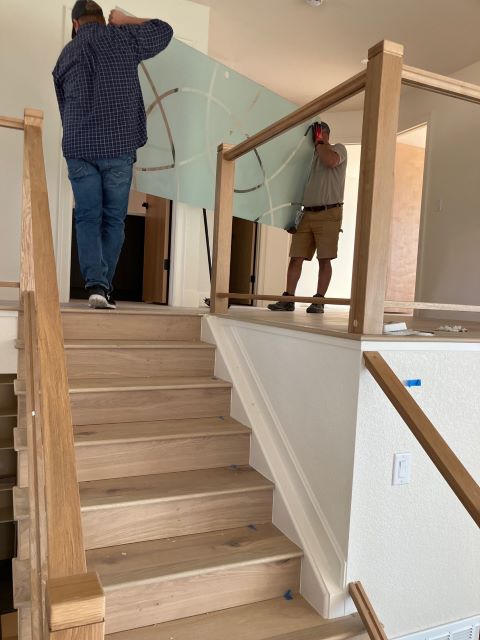

Wade and Jim bringing in glass barn door
-

Wade installing door hardware
-

Wade installing shelves in custom closet
-

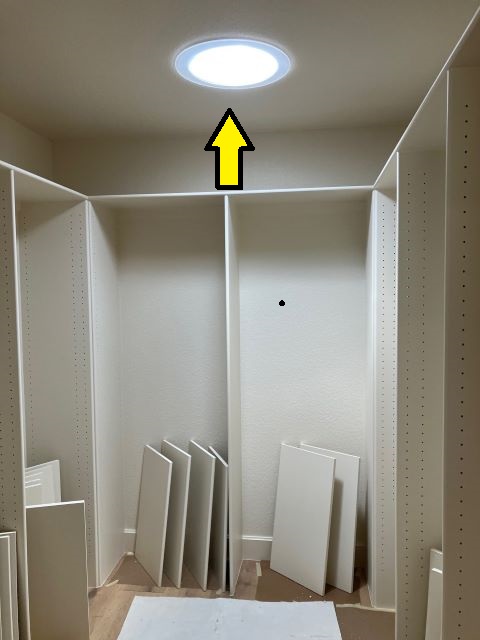

Velux sun tube brings in lots of natural light in primary custom closet
-

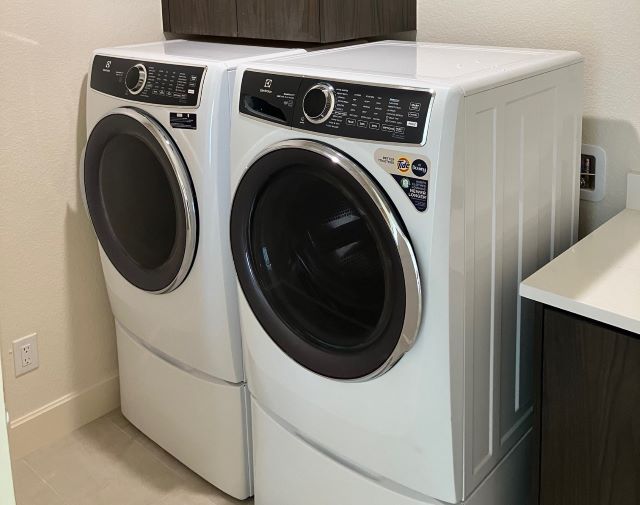

New washer and dryer installed
-

Range hood being installed
-

Kitchen cabinet protection has been removedÂ
-

NRG Logic's final inspection
-

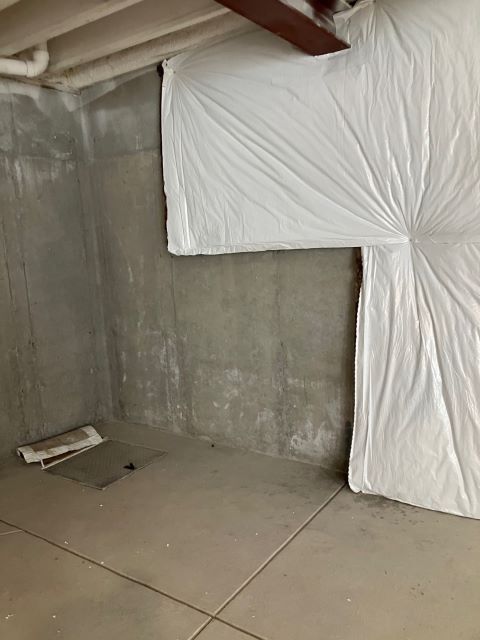

Insulation being installed over concrete walls in unfinished lower level
-

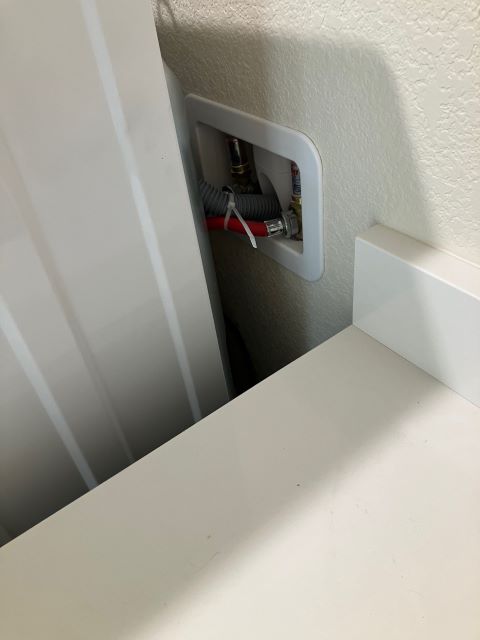

Special washer box adapter to drain attic HVAC equipment
-

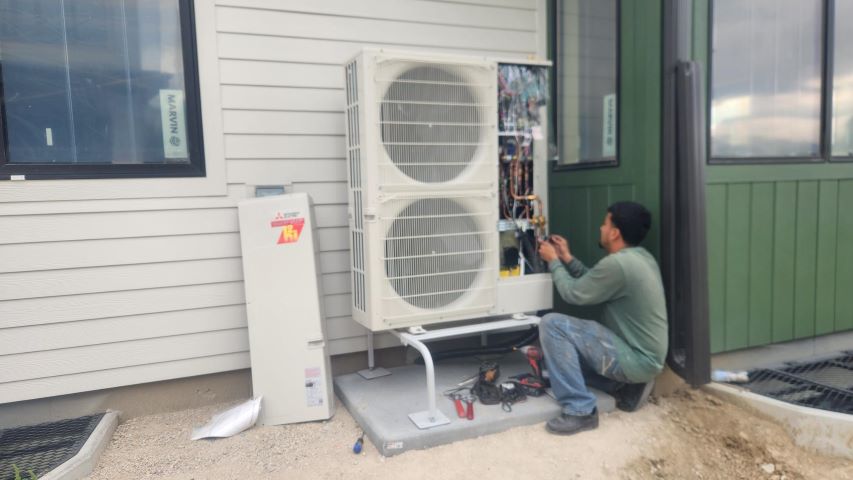

Heat pump equipment finalizedÂ
-

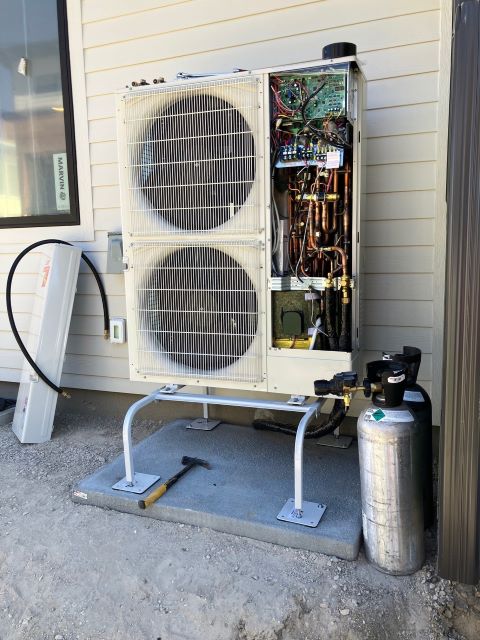

Extreme temperature heat pump
-

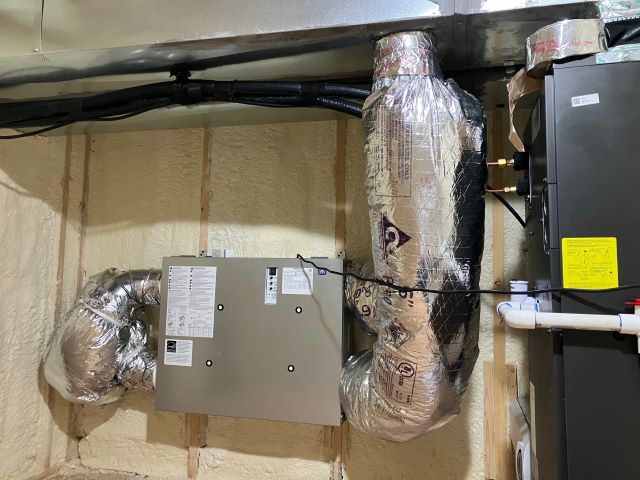

ERV in the insulated mechanical room in the attic
-

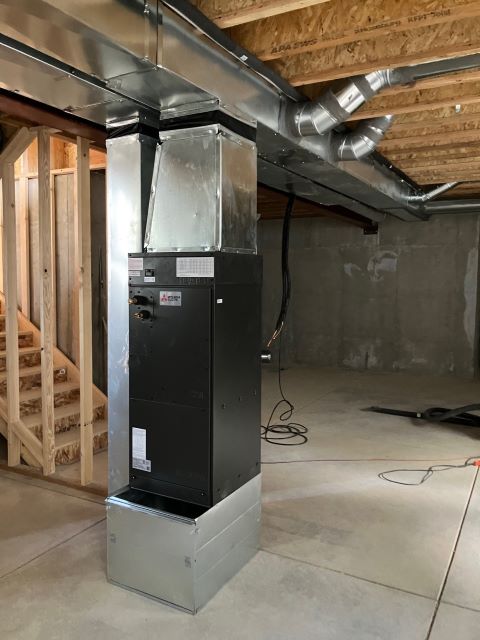

Air handler in the insulated mechanical room in the attic
-

Shieko's wave light
-

Kitchen pendant lights over islandÂ
-

Ceiling fan in spare bedroom
-

Kitchen faucet
-

Primary vanity countertops with plumbing fixtures & lighting
-

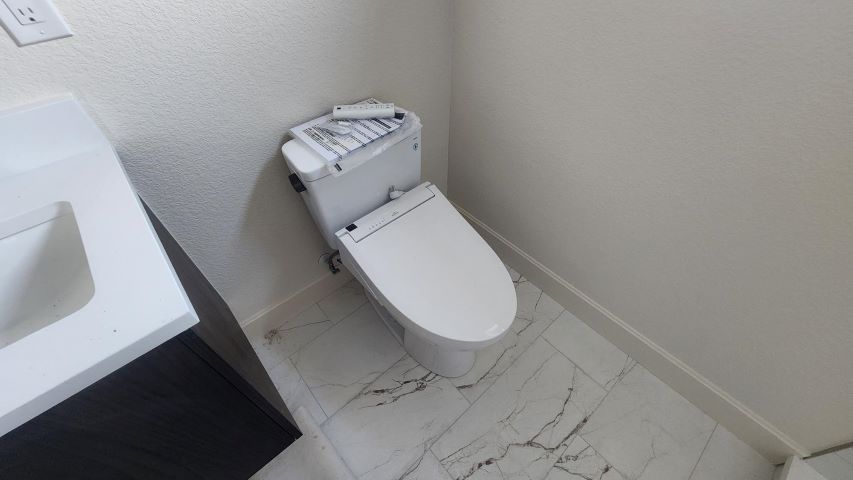

Primary toilet
-

Primary shower valvesÂ
-

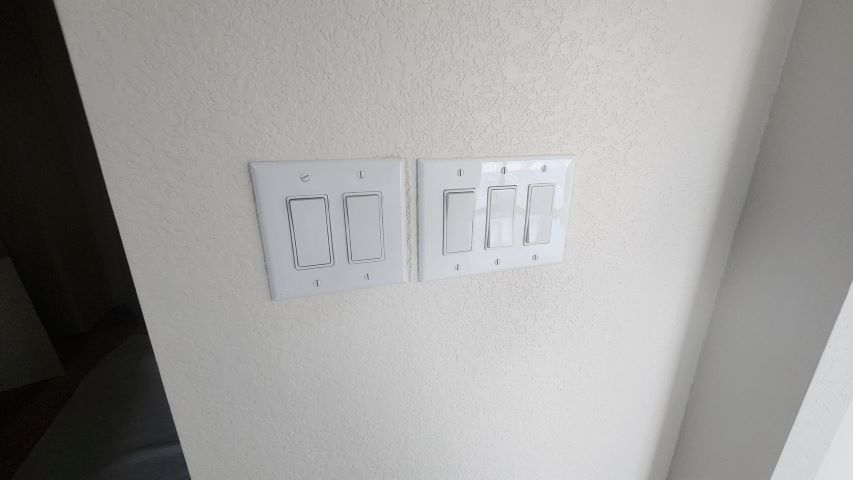

Electric switches are trimmed
-

Electricians installing switches after house was painted
-

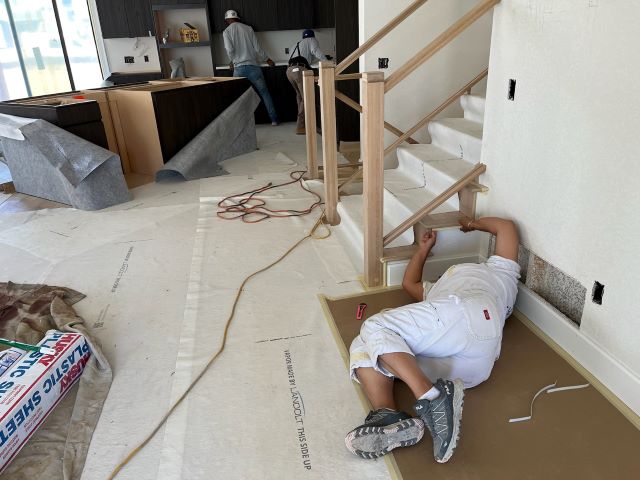

Painter, Maria, getting to the hard spots
-

Plumbing fixtures installed - tub is complete
-

IPE is responsibly harvested to provide a truly renewable resource
-

IPE is naturally resistant to rot & decay. Guaranteed for 20 years without preservatives
-

IPE, an exotic hardwood, tub deck installation in progress
-

Cabinets protection still in place
-

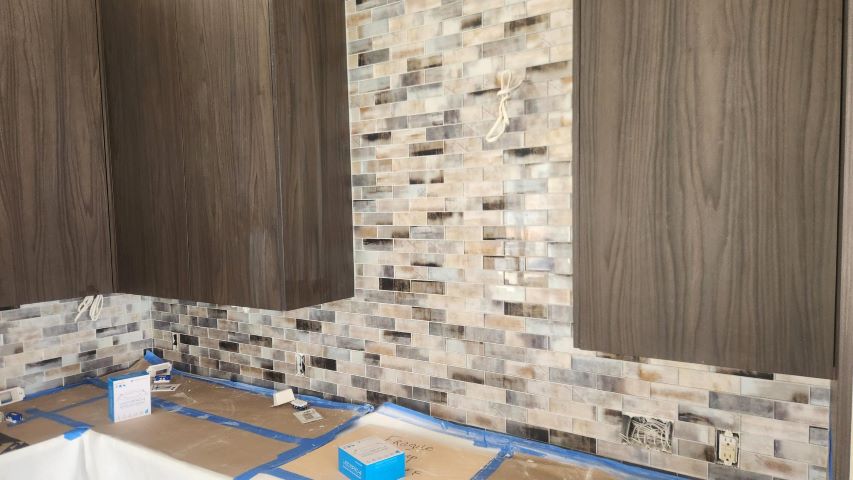

Kitchen tile backsplash
-

Accent tile behind soaking tub
-

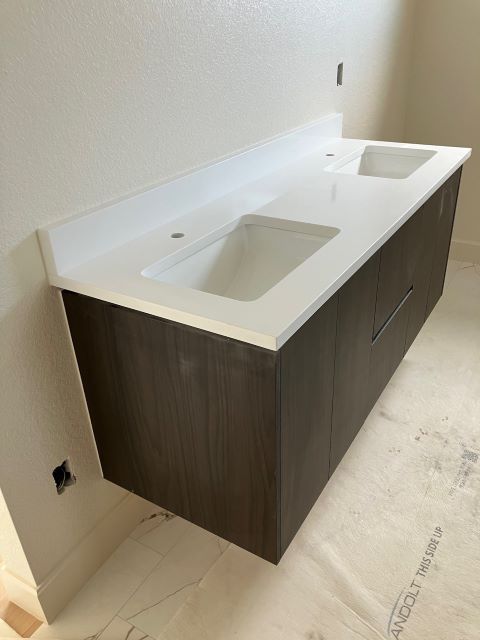

Primary bath vanity & top installed
-

Primary shower baseÂ
-

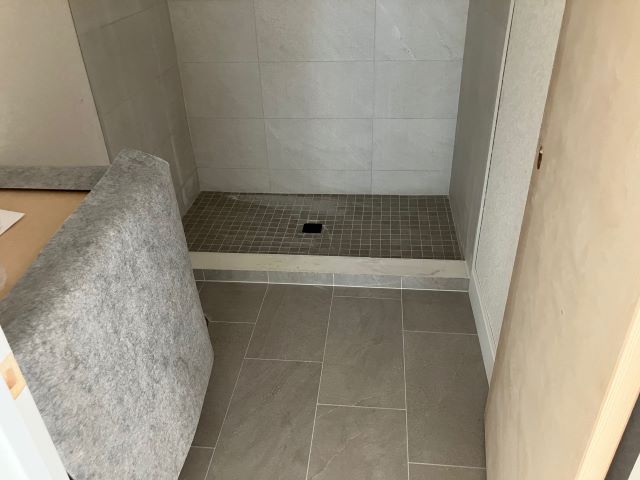

Bath #2 grouted & cabinet protection in place
-

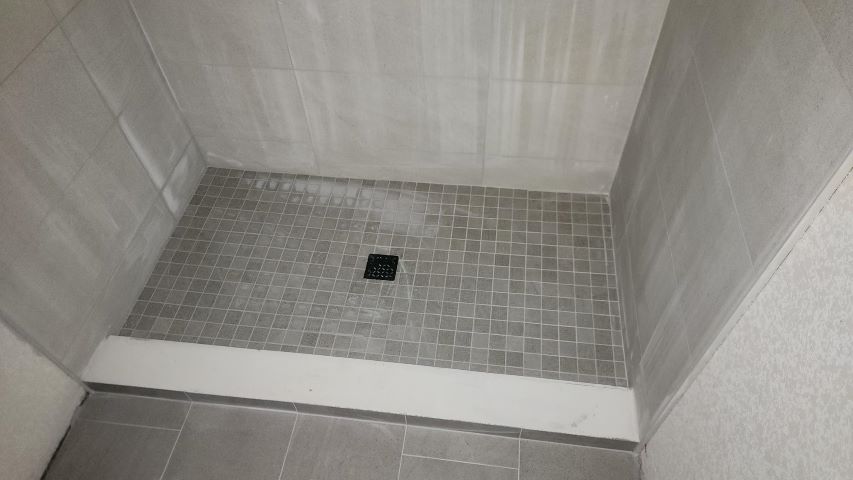

Guest shower base
-

Laundry tile floor grouted
-

Solarium tile grouted
-

Kitchen shelves being installed
-

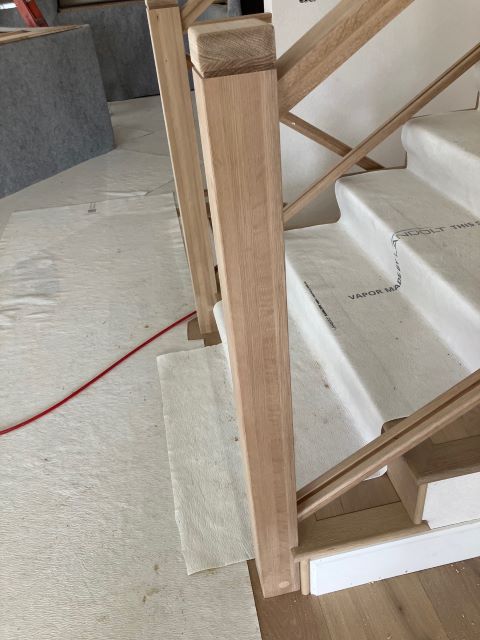

Details of handrail
-

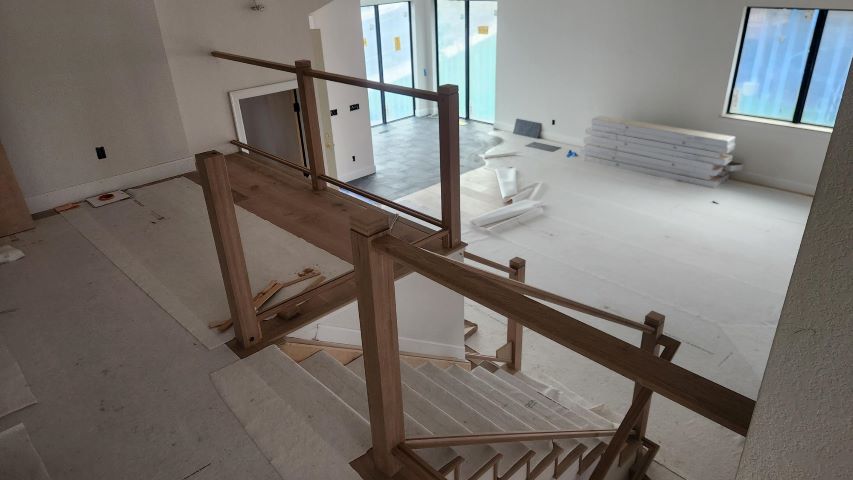

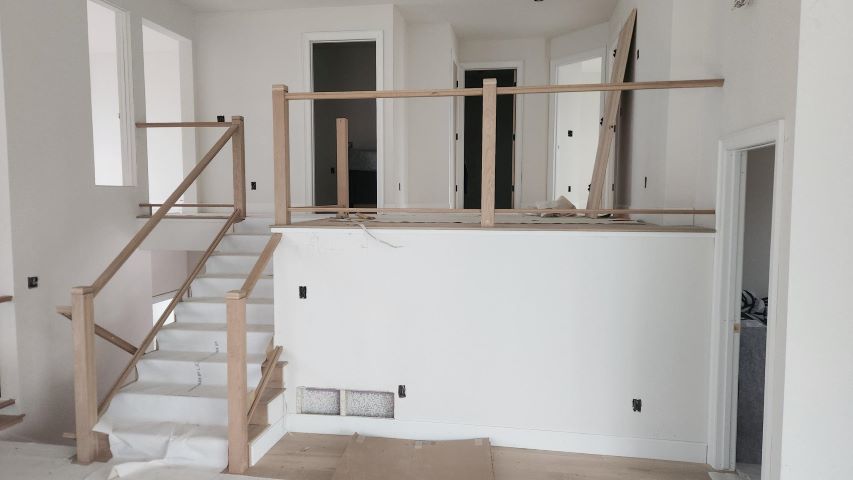

Interior railing in progress
-

Interior railing work in progressÂ
-

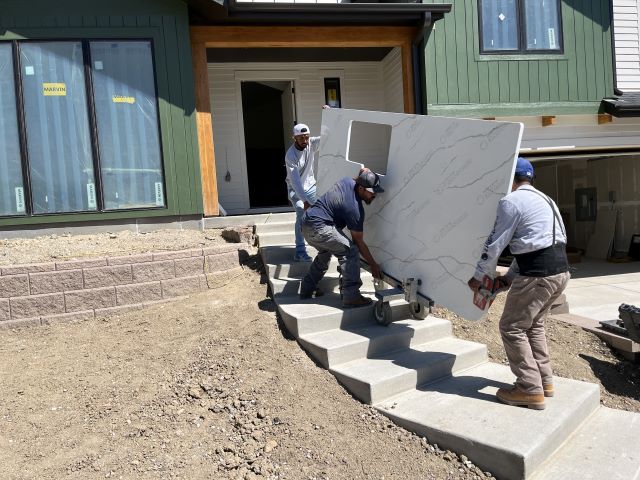

Almost to the top
-

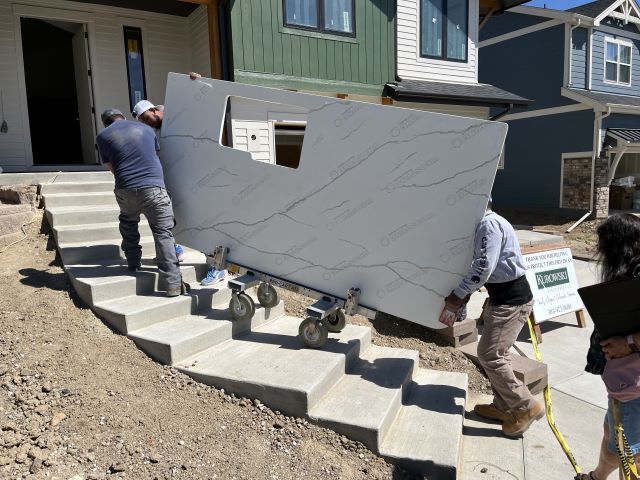

Thank goodness for wheels
-

Easy as it goes
-

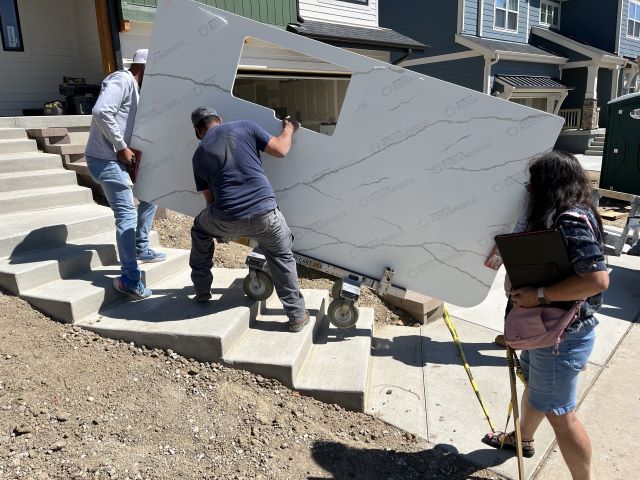

Shieko helping out the crew
-

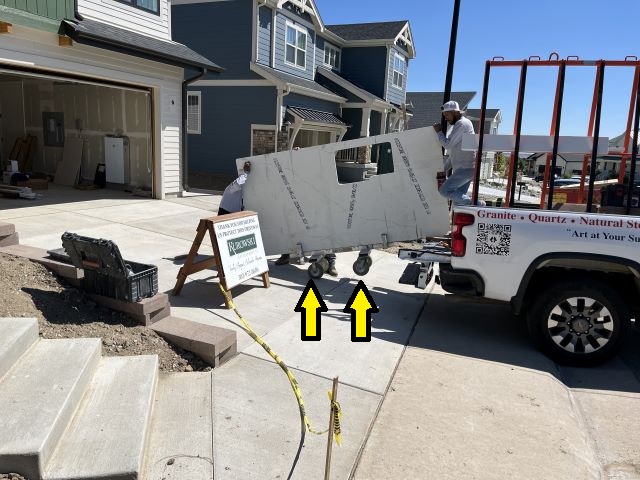

Placing on rolling wheels
-

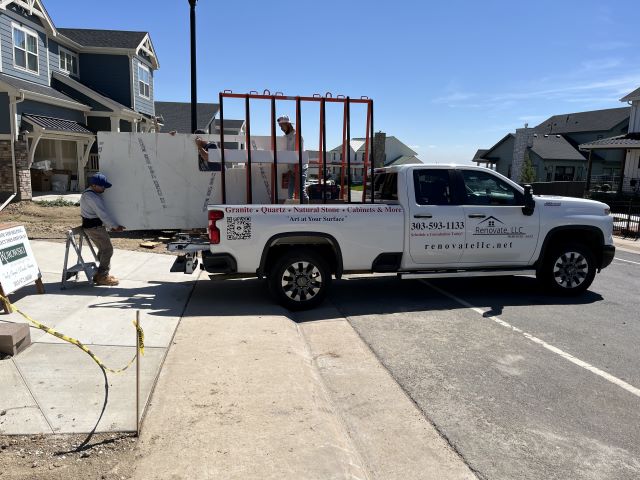

Very heavy - be careful
-

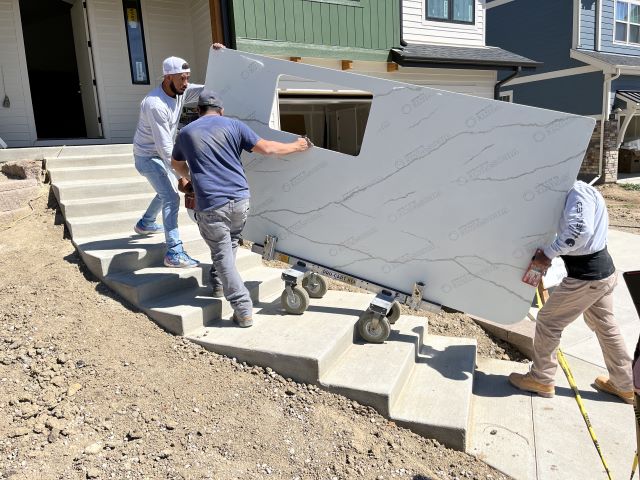

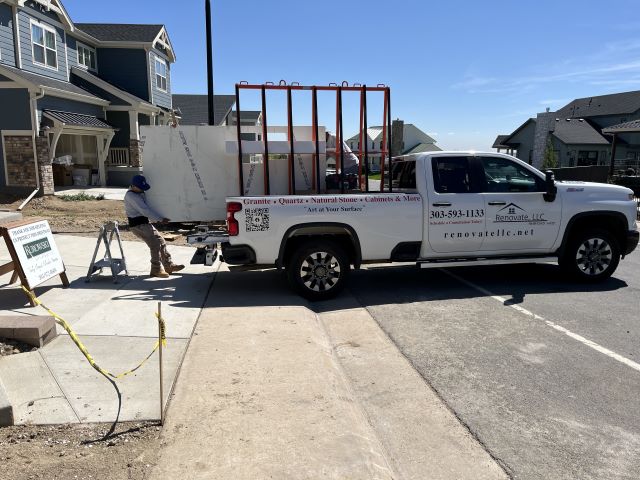

Unloading kitchen countertop
-

Shieko is happy the island countertop is here
-

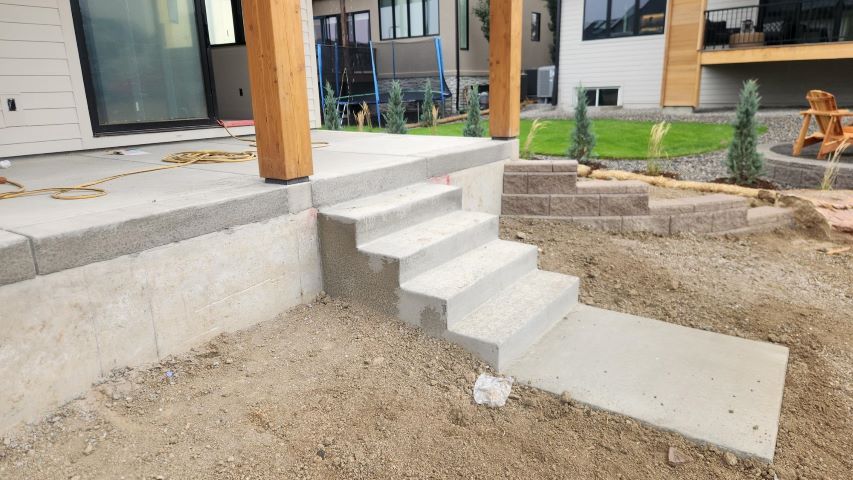

Upper patio steps & landing
-

Rear patio for study
-

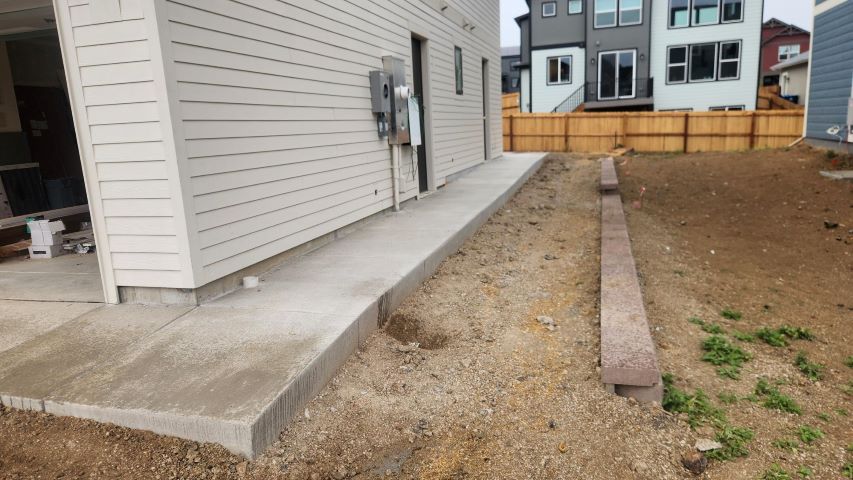

East sidewalk
-

Driveway with protection sign
-

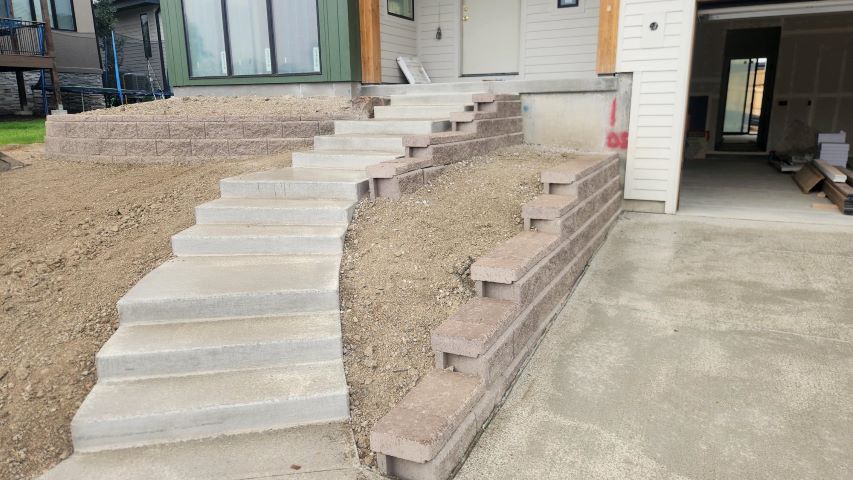

Entry stairs & landing
-

The finishing touch
-

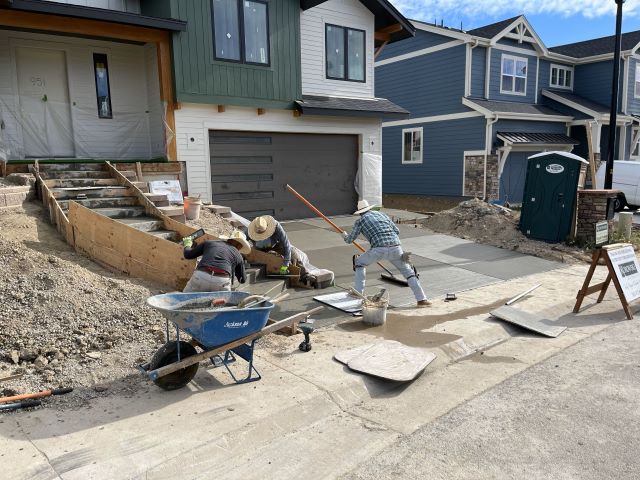

Applying light broom finish
-

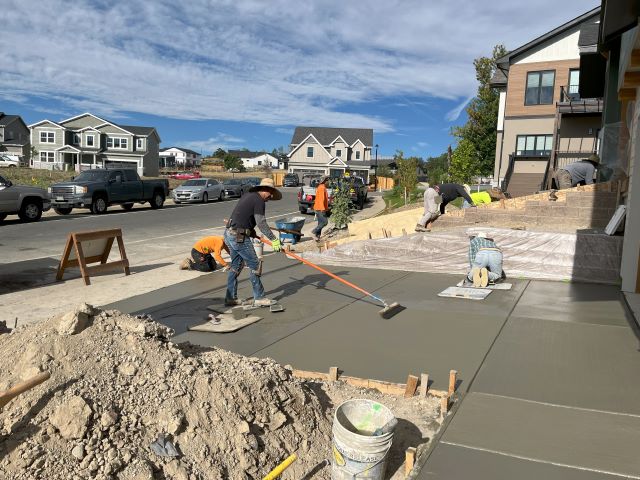

Doing the broom finish
-

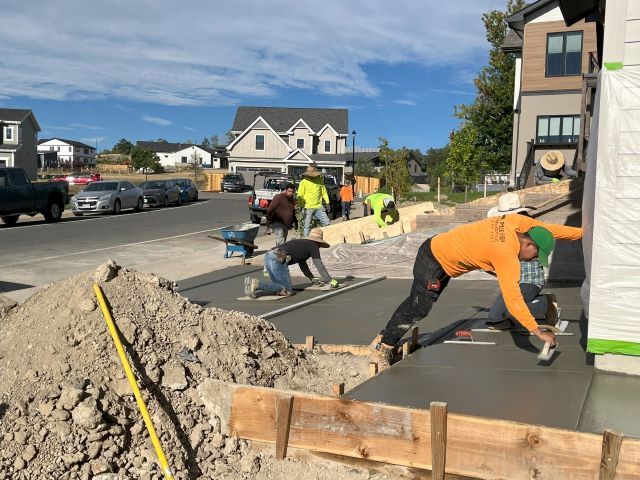

We got three beating the heat
-

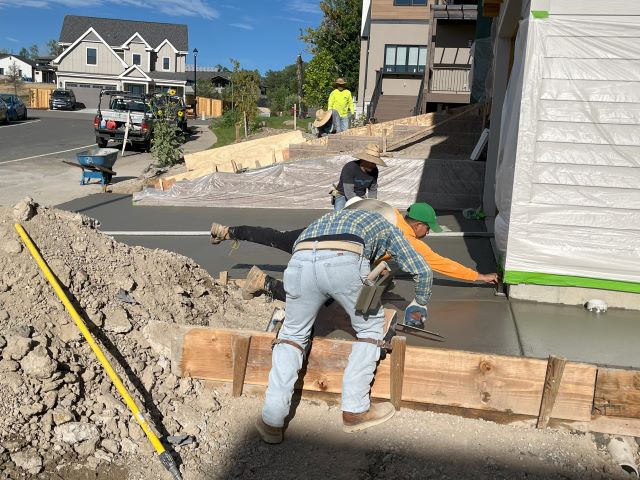

How about this stretch balancing act
-

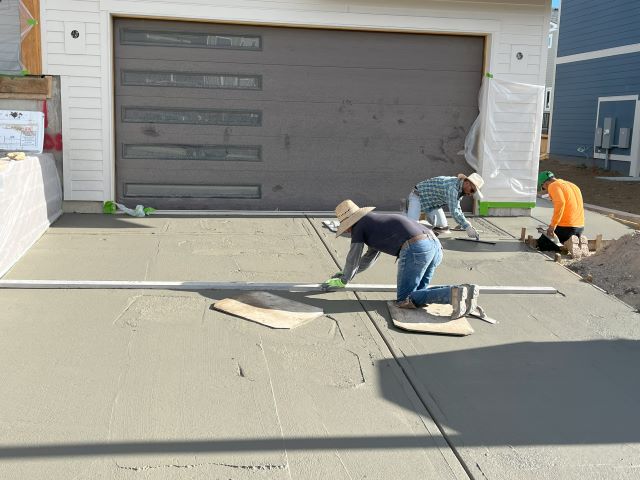

Creating the expansion joints
-

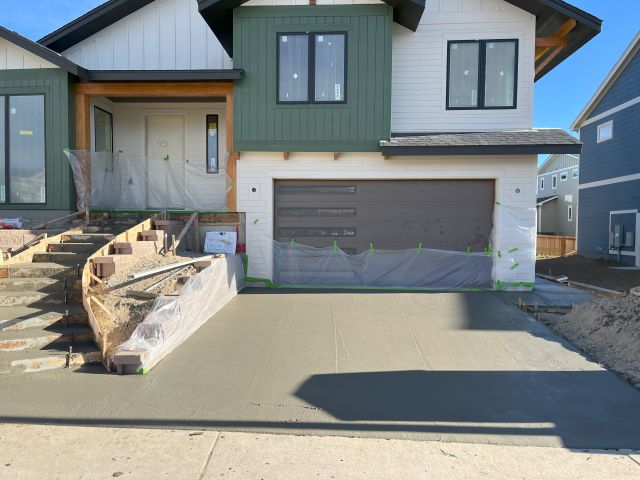

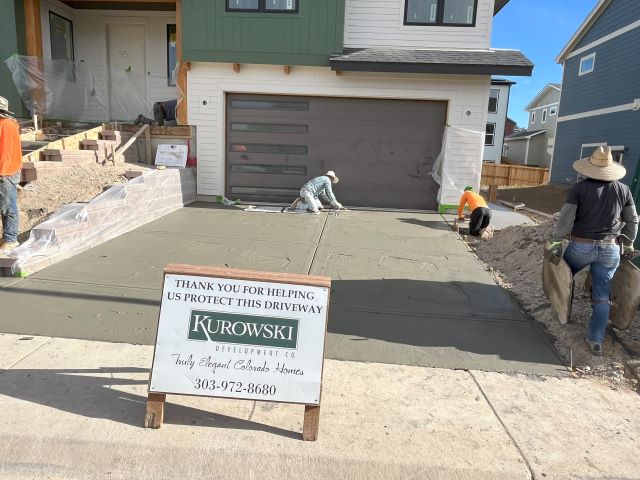

Starting the driveway finishing
-

Concrete waiting for finish work
-

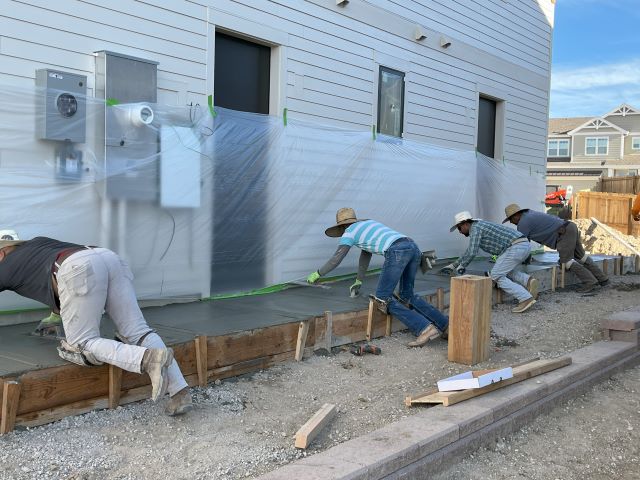

Now that is team work
-

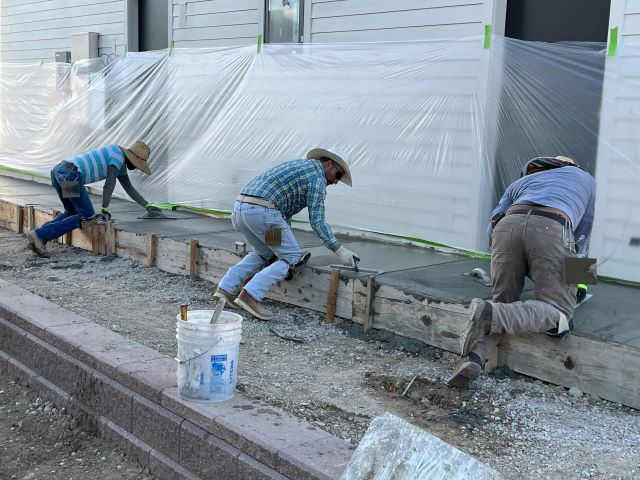

Three men of a 12-man team finishing the east sidewalk
-

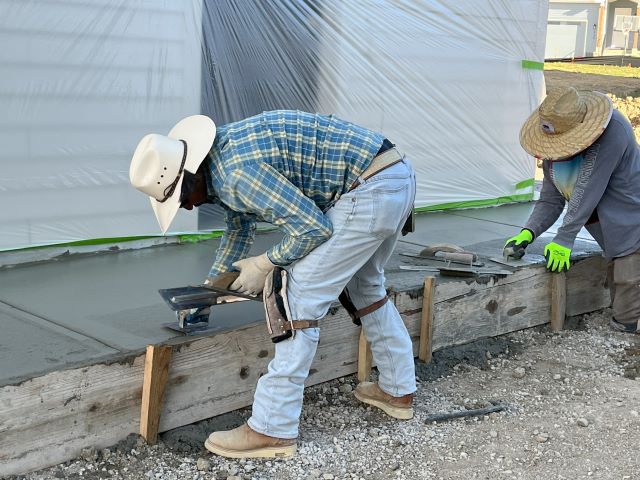

Trowels in action
-

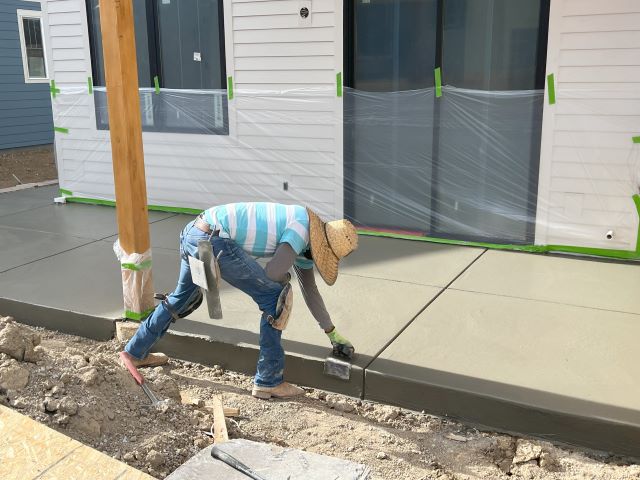

Finishing the edge
-

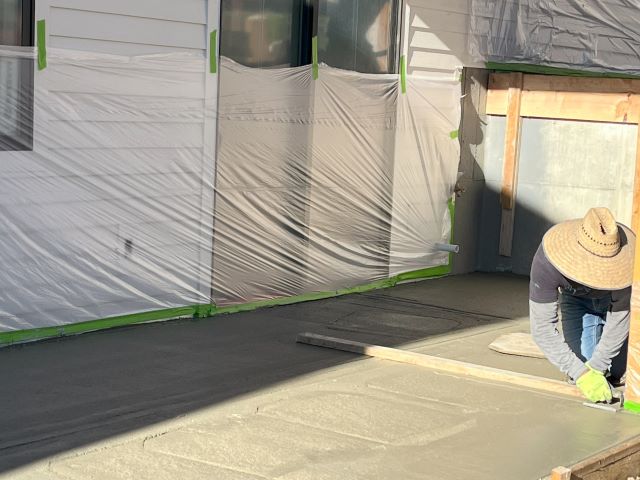

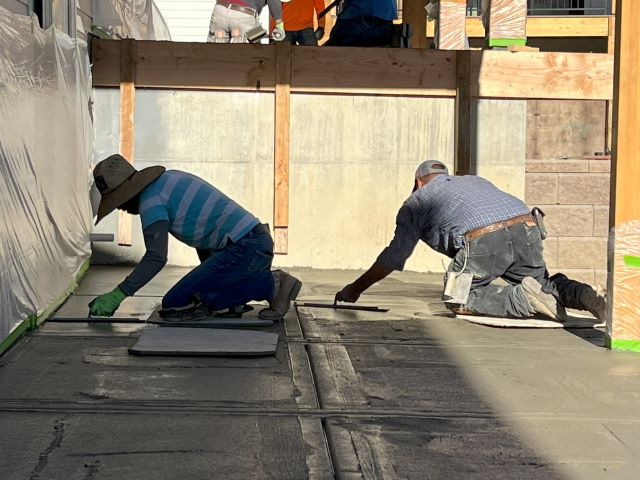

Finishing the lower patio
-

Finishing the lower patio
-

Finishing the steps
-

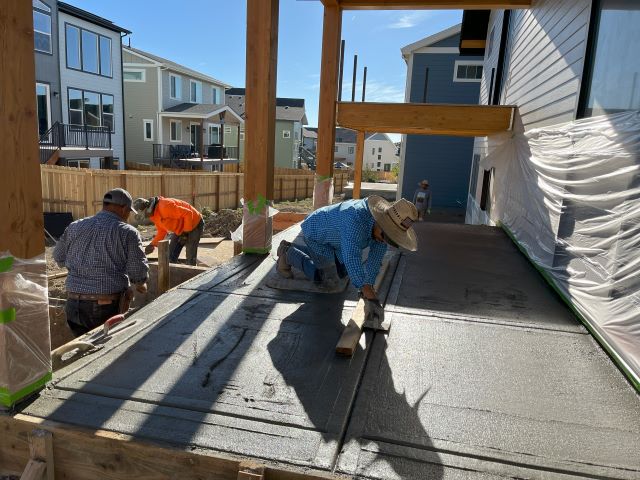

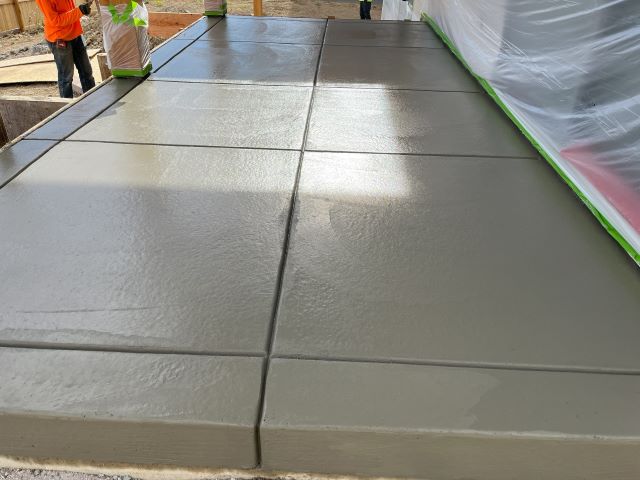

Upper patio finish
-

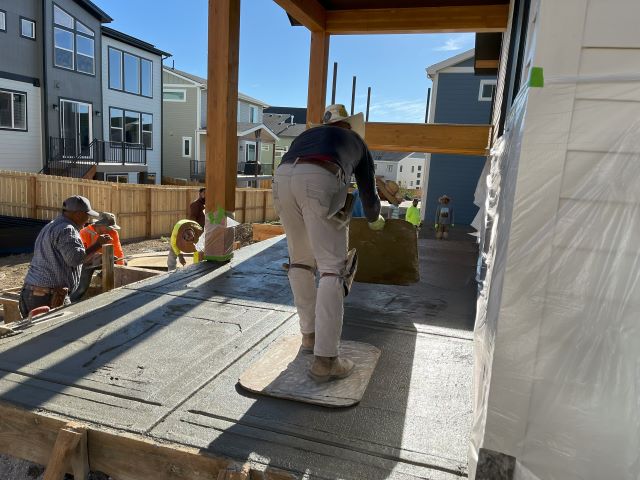

Upper patio finishing work in progress
-

Upper patio details
-

Finish work upper patio steps & landing
-

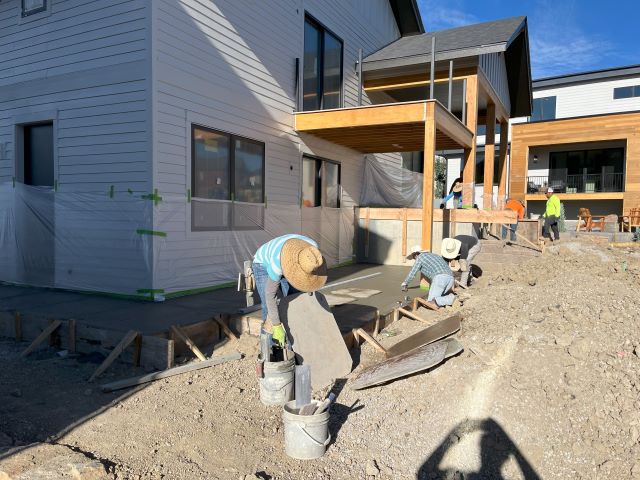

Finishing upper and lower patios
-

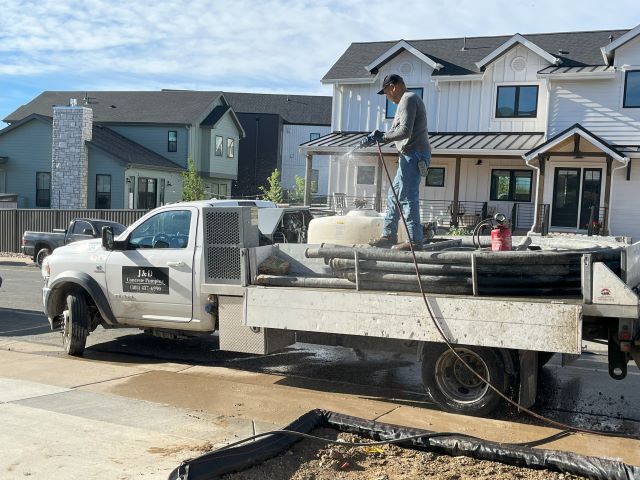

Cleaning the line pump truck
-

Tirzo - Owner, manager and a really good guy
-

An excellent trade partner
-

Deck railing posts are installed
-

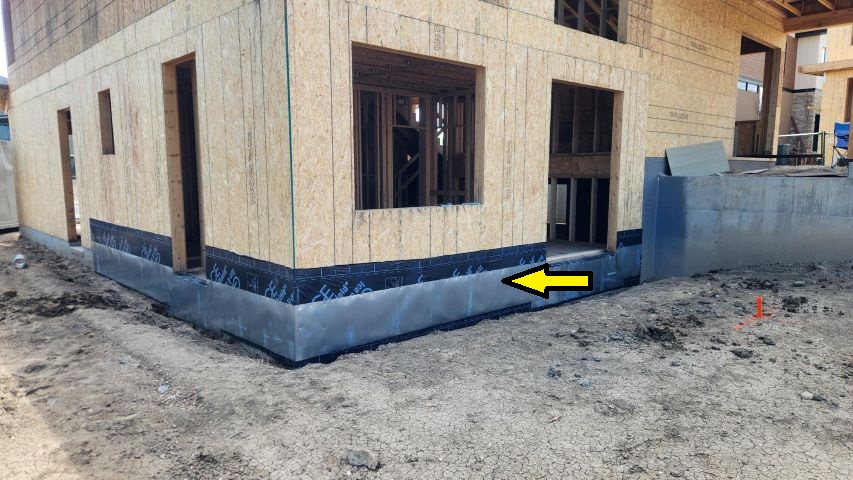

Deck is wrapped with Vycor flashing for moisture protection & longer durability
-

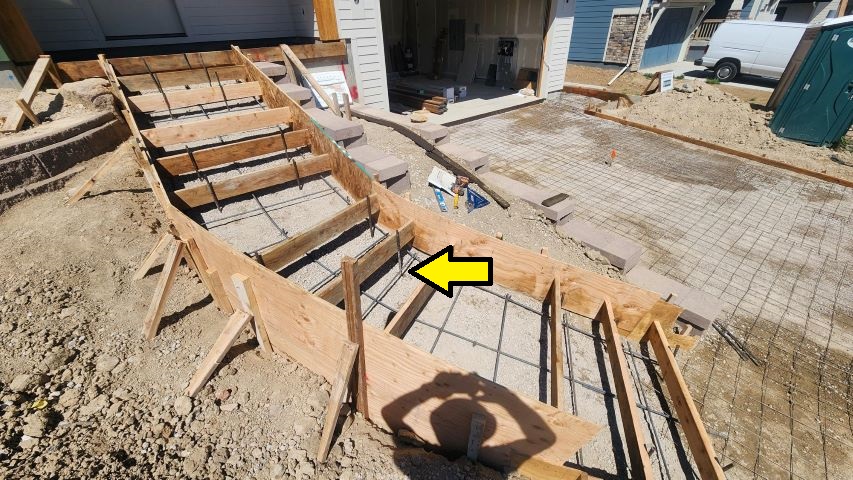

Stairs to front porch with steel rebar are formed
-

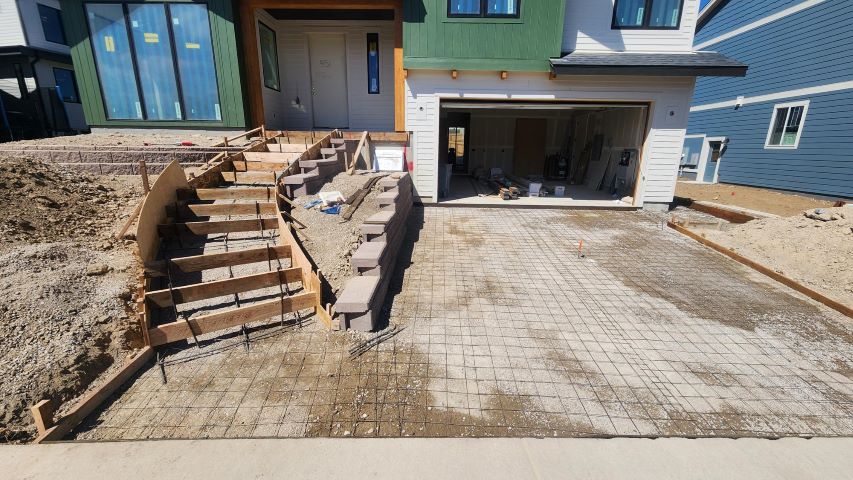

Stairs to front porch are formed
-

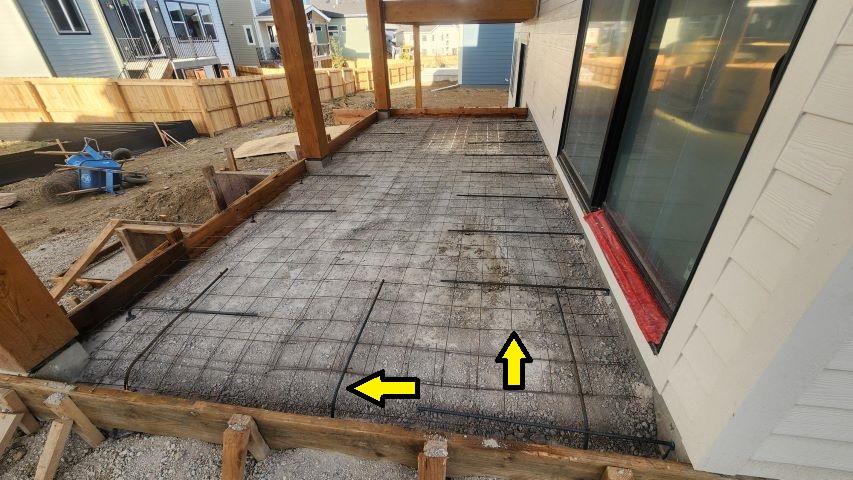

Steel mesh & rebar in back upper patio
-

Steel rebar & mesh in rear studio patioÂ
-

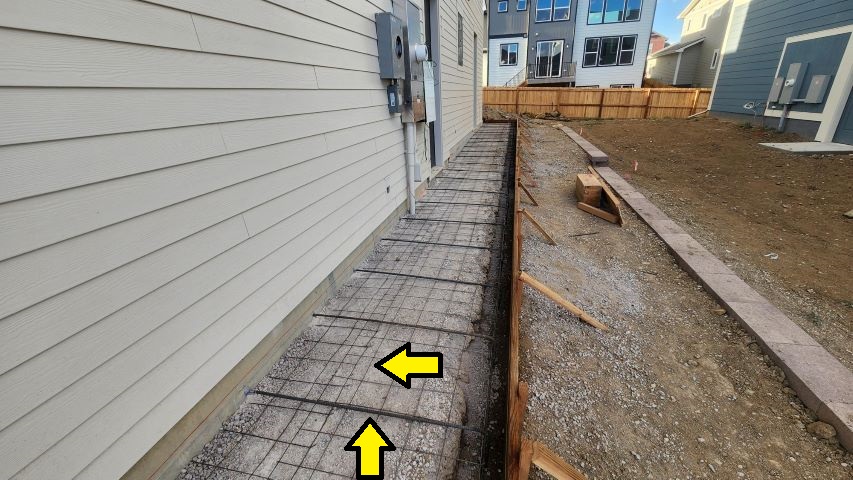

Steel rebar & mesh in east sidewalk
-

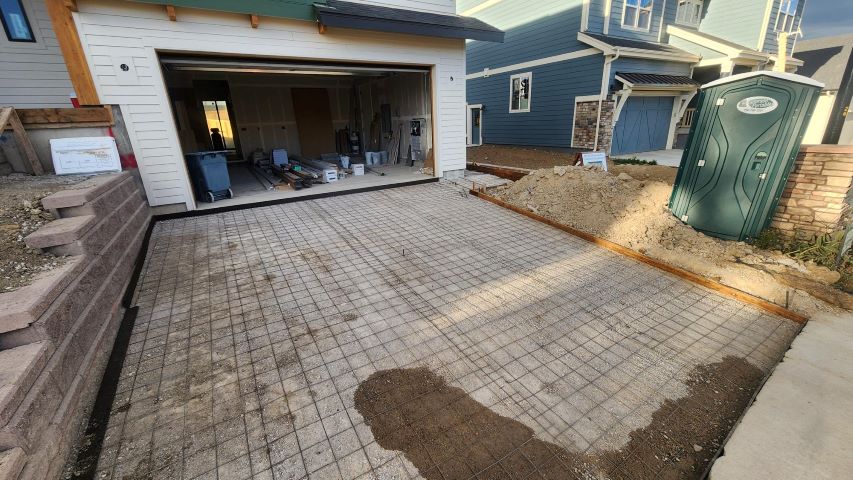

Steel mesh in drivewayÂ
-

Back stairs are formed
-

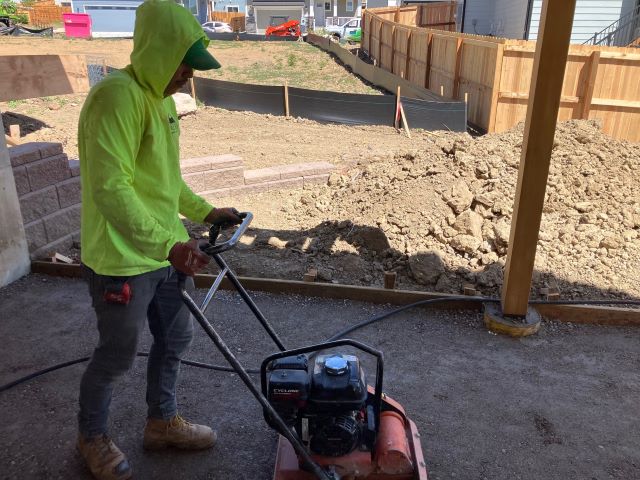

Wetting & compacting road base at rear lower patio
-

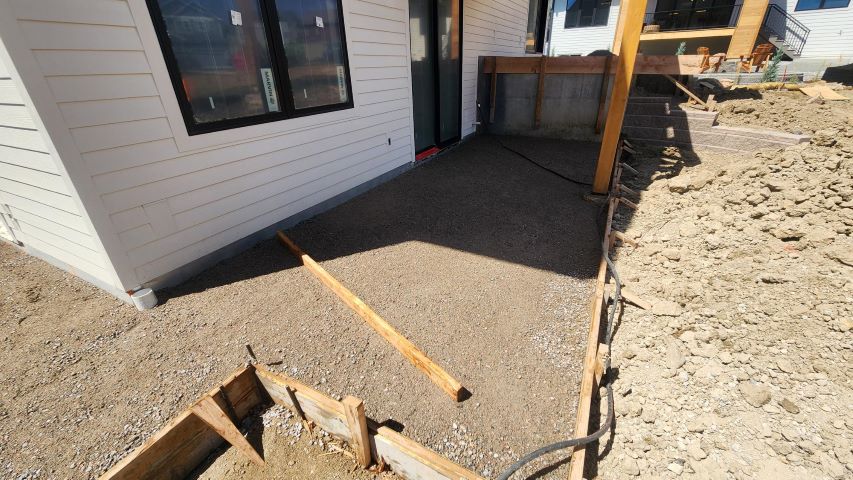

Road base under rear patio
-

Back stairs being formed
-

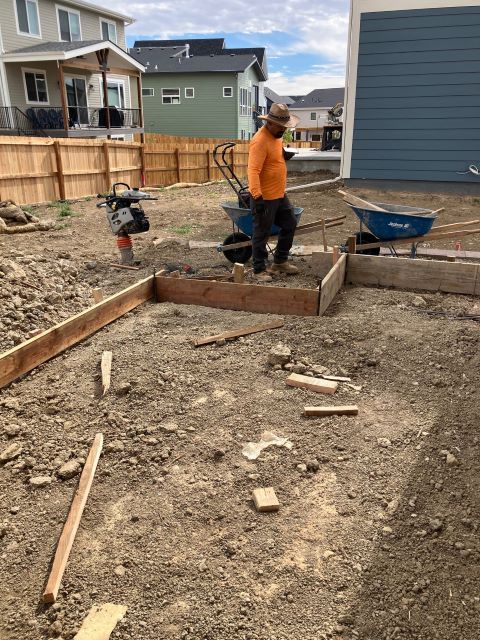

Setting forms
-

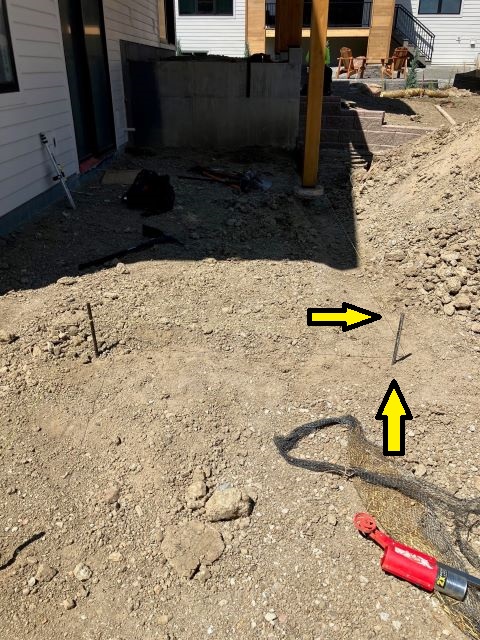

Concrete patio staked and string lined
-

Concrete crew preparing east sidewalk
-

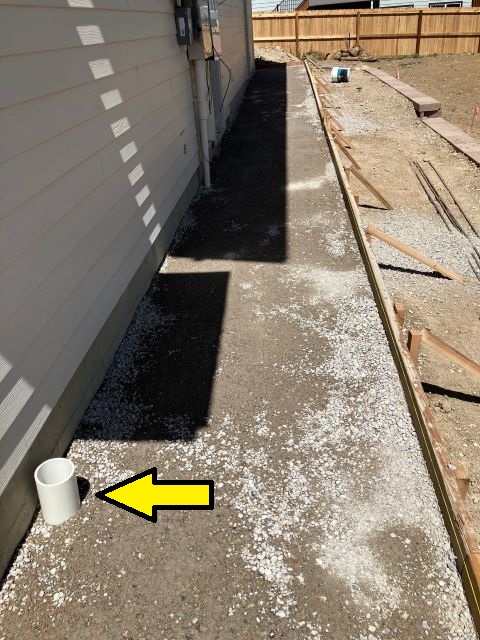

PVC sleeve to take drainage under sidewalk
-

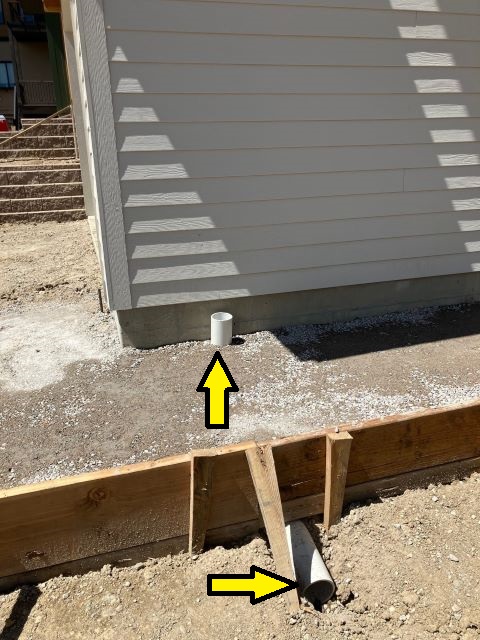

PVC sleeve to take drainage under sidewalk
-

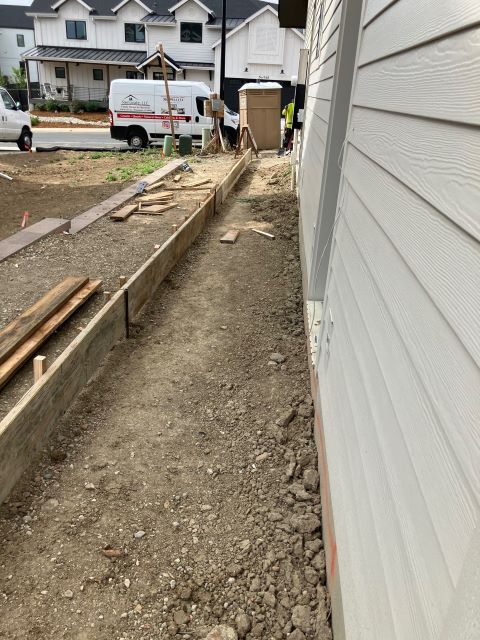

Sidewalk forms set
-

Sleeve location under sidewalk is marked
-

Sleeve location under sidewalk is marked
-

Driveway forms being set
-

Concrete crew preparing drivewayÂ
-

Leveling clips are used for all tile installationÂ
-

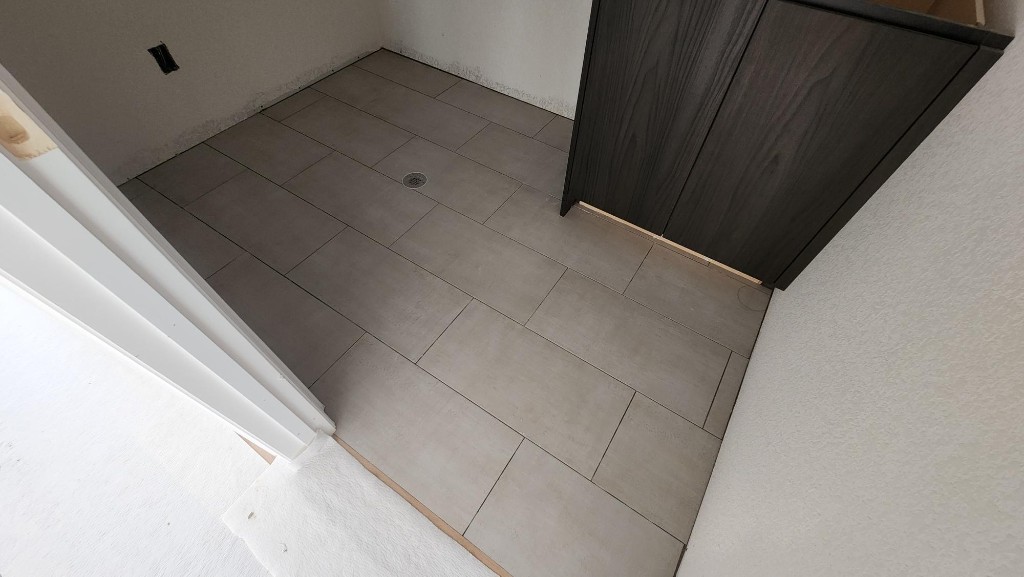

Laundry room floor tiles
-

Primary bath floor tilesÂ
-

Primary bath tile floor
-

Tile shower base and floor
-

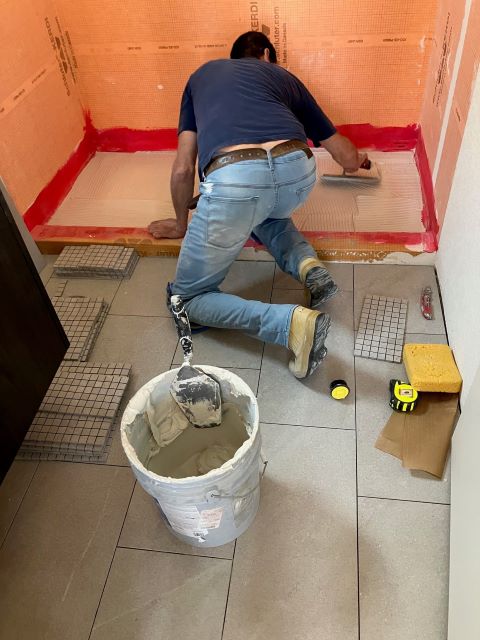

Marcelo applying tile mastic on Schluter shower pan
-

Studio shower niche
-

Pantry shelvesÂ
-

Primary closet adjustable shelvesÂ
-

Jim drilling for adjustable closet shelf pin
-

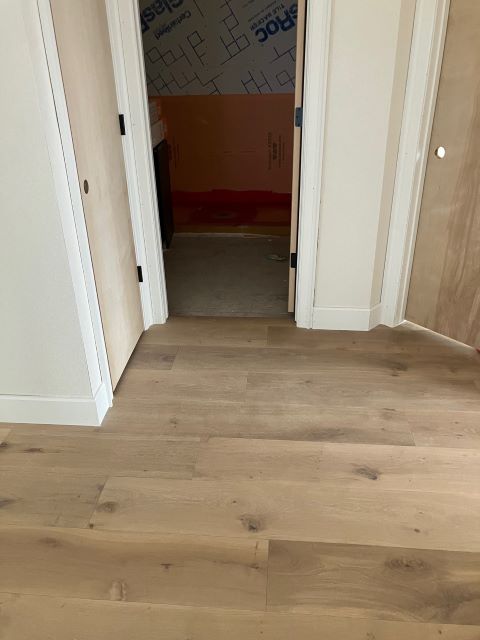

Doors, base, & hardwood flooring installed at upper bath
-

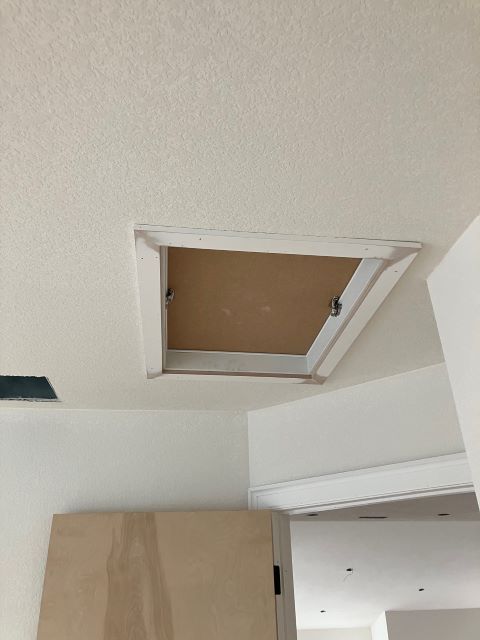

Attic access installed in secondary bedroom
-

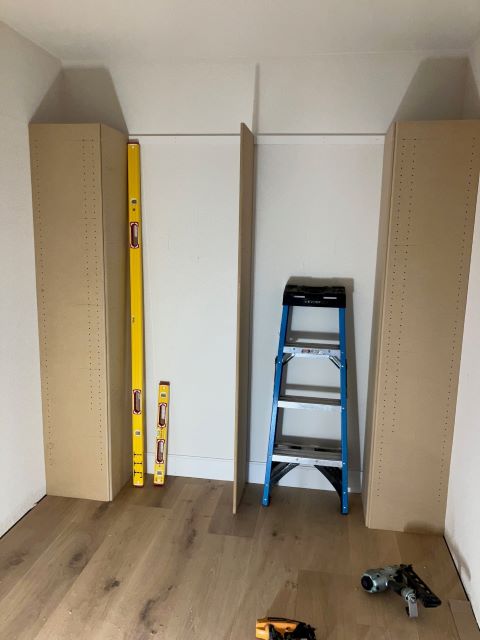

Closet bulkhead installed
-

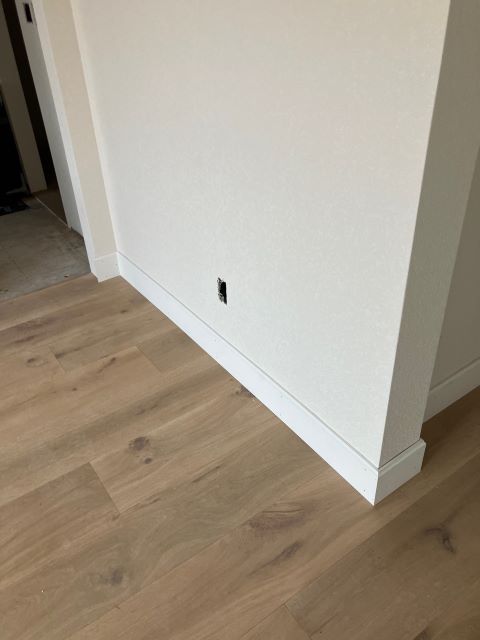

Baseboards on hardwood in primary bedroom
-

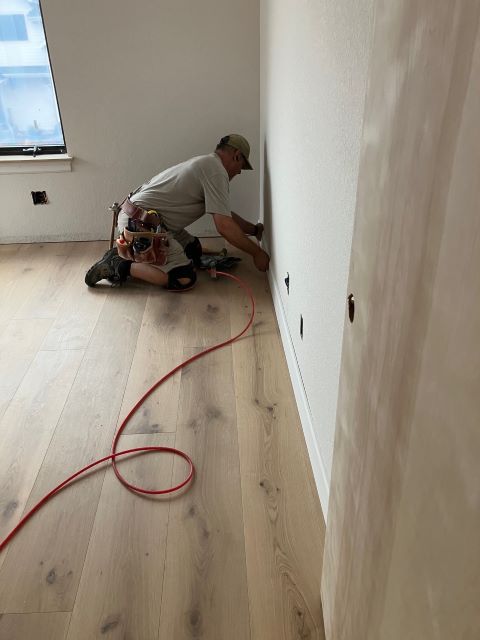

Jim installing baseboards
-

Stairs covered with protective material
-

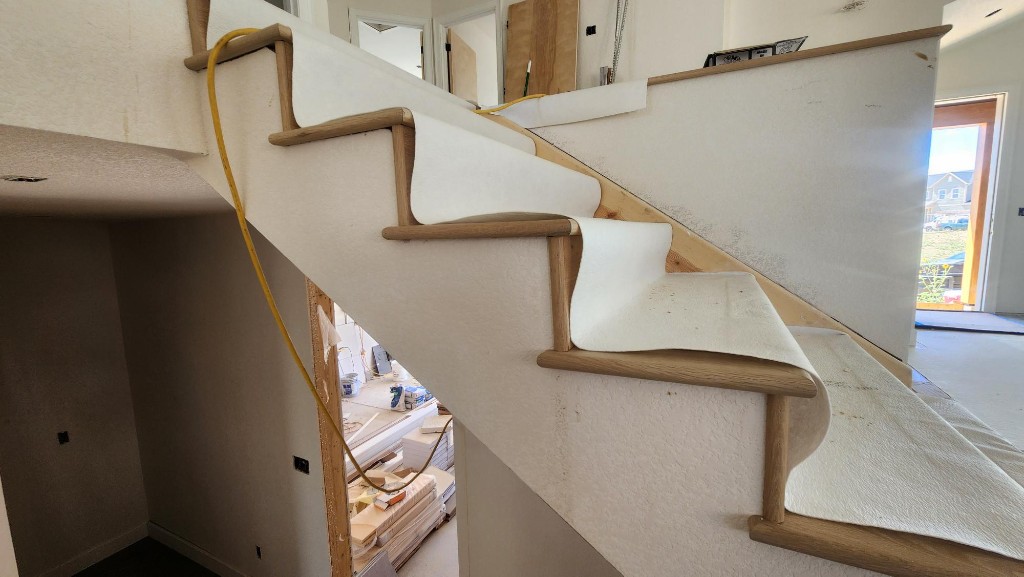

Side of open stringer stairs
-

Hardwood stairs are finished and protectedÂ
-

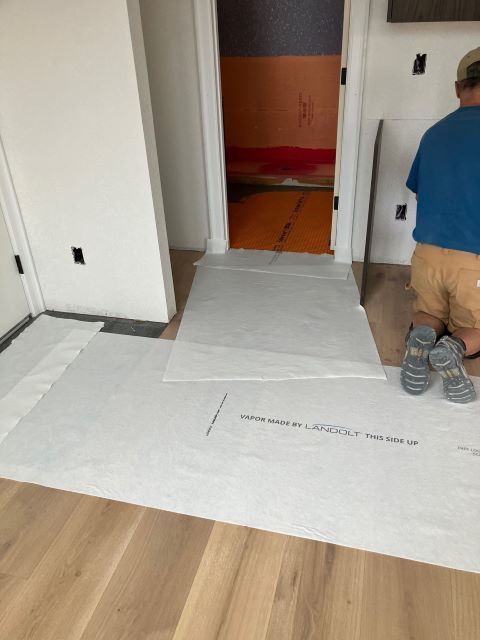

Protective floor covering in place
-

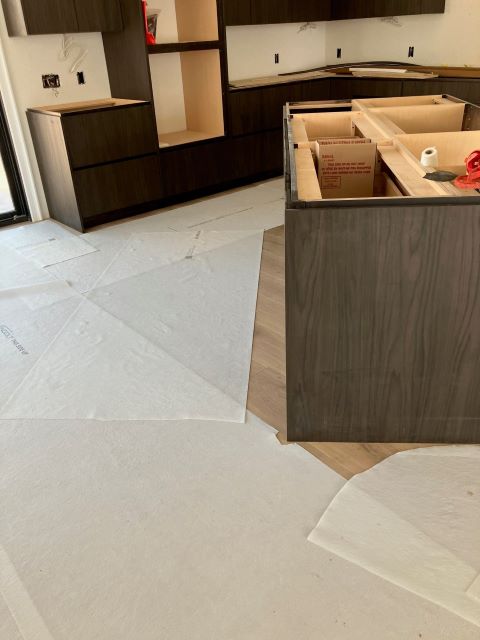

Kitchen floor covered with protective material
-

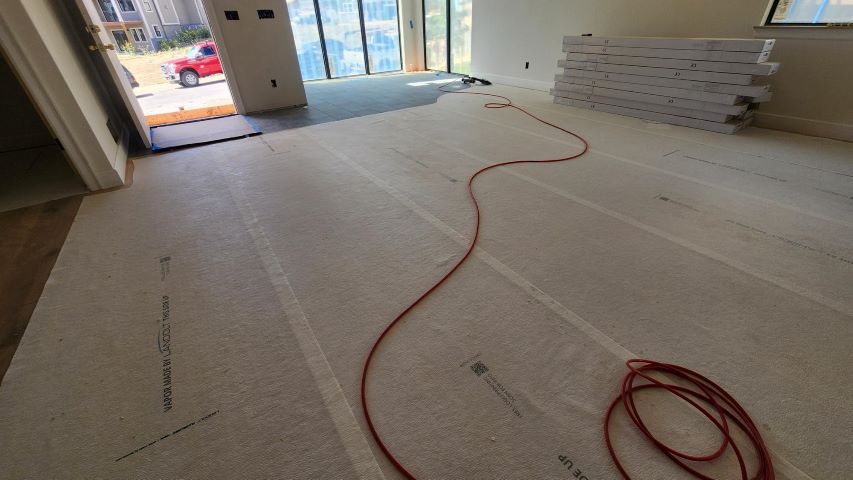

Finished floors are protectedÂ
-

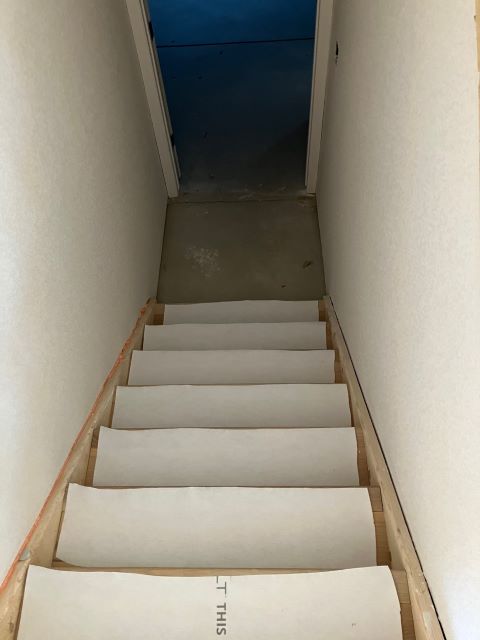

Hardwood flooring will be installed at basement landing
-

Piano top layout between solarium & living room
-

Installing hardwood floor in kitchen
-

Protective cabinet material in place
-

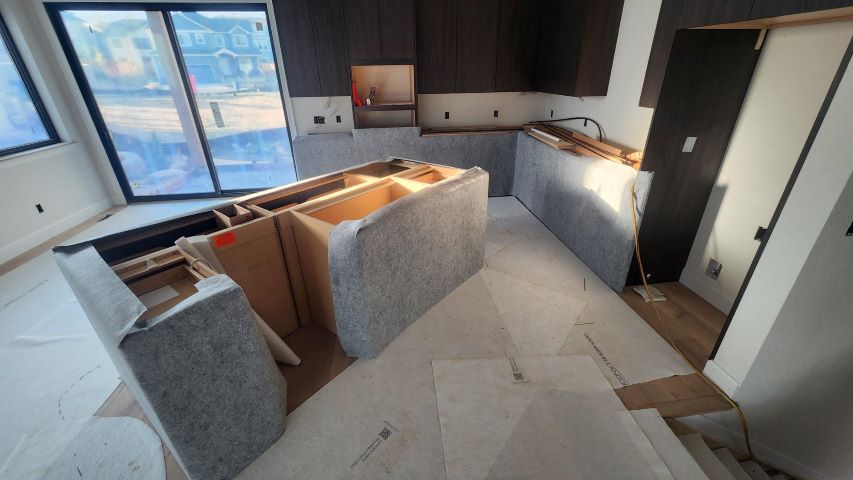

Floor & base cabinets are wrapped with innovative reusable material for protectionÂ
-

Wall color options
-

Window sills in place
-

Beautiful corner miter with clamp
-

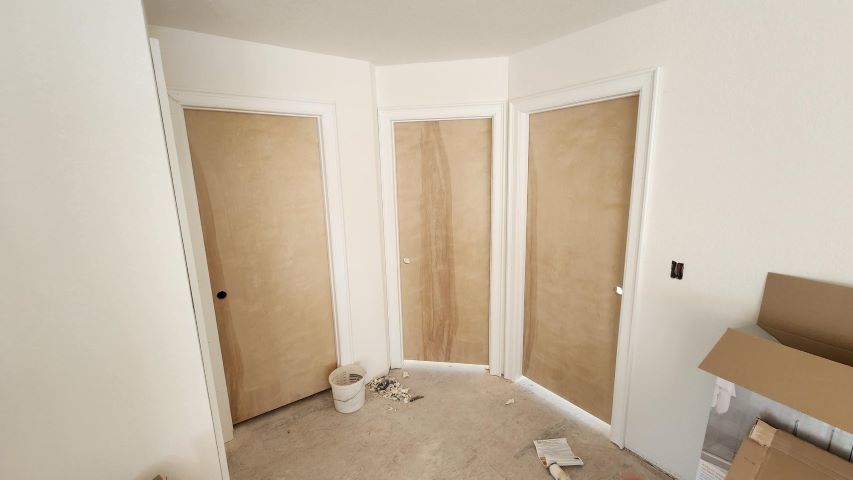

Upper floor doors installedÂ
-

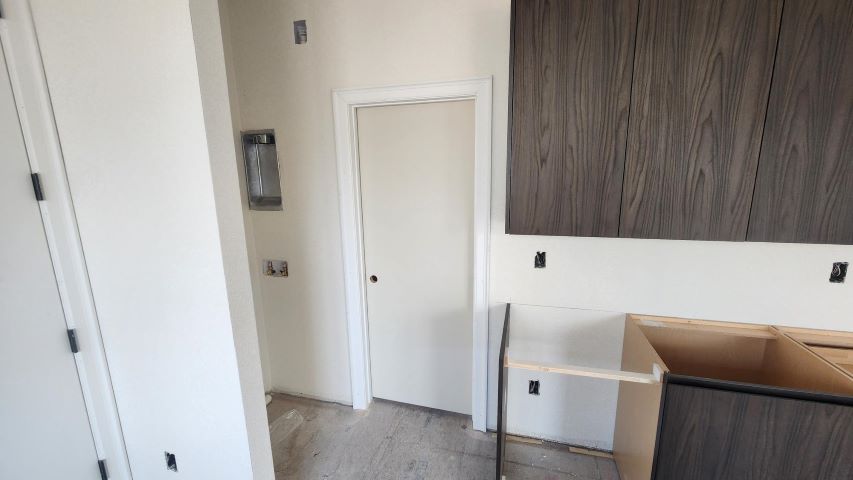

Doors on lower level installedÂ
-

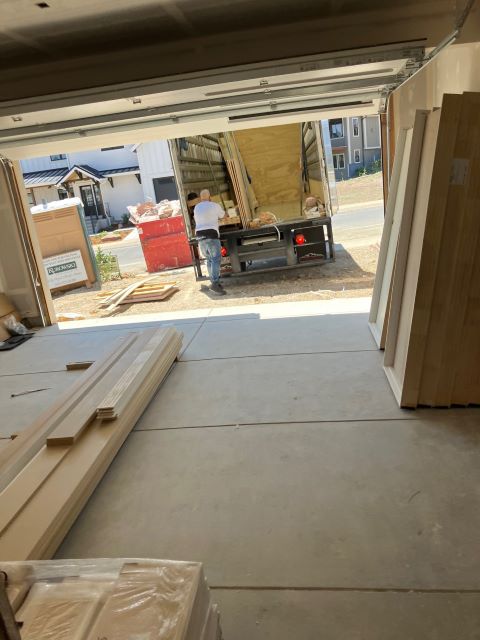

Delivery of doors & interior trim
-

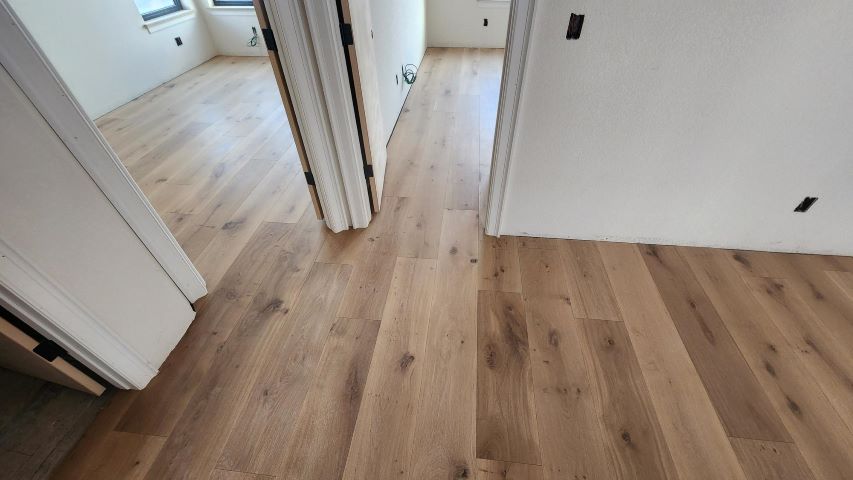

Wood floors installed on upper floor
-

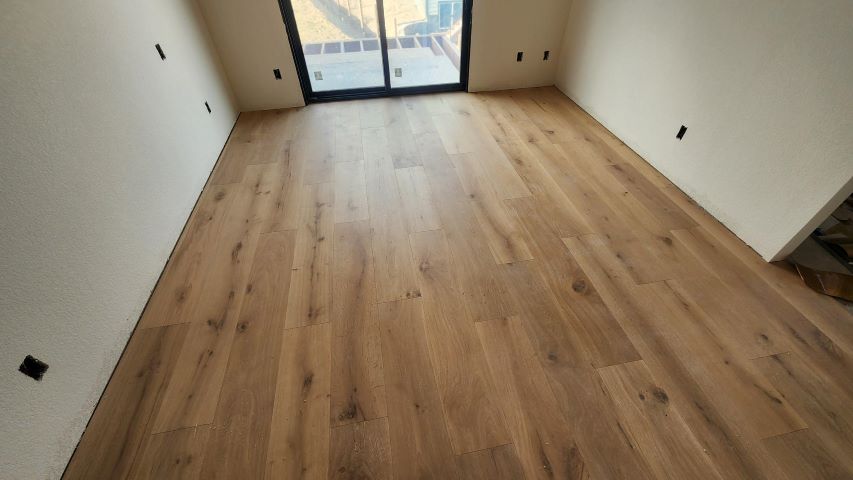

Wood floor in master bedroomÂ
-

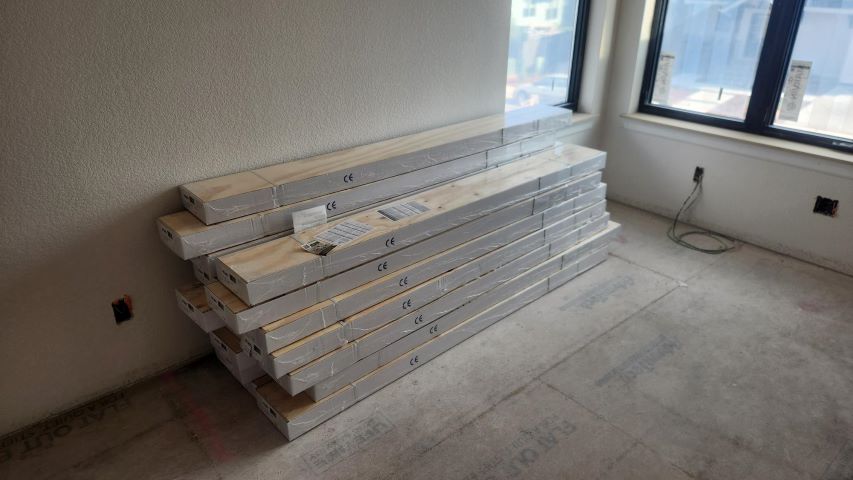

Wood flooring acclimating to temperature & humidityÂ
-

Front of house painted
-

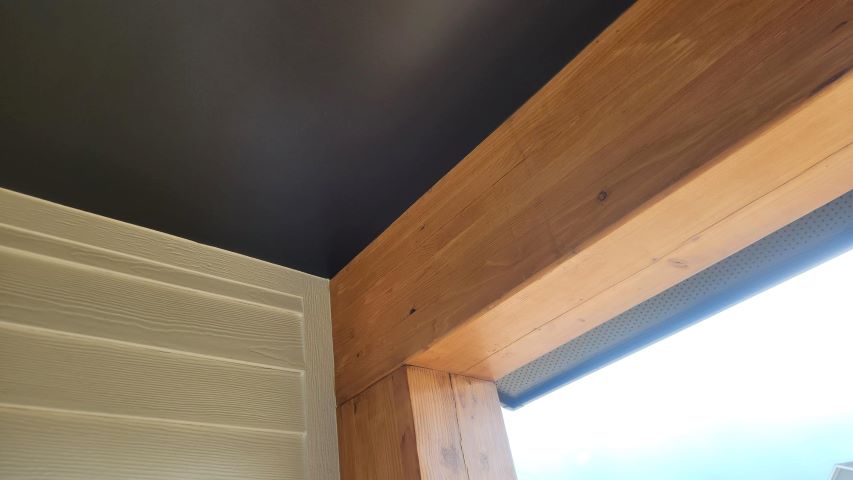

Finished front porch beams and soffit
-

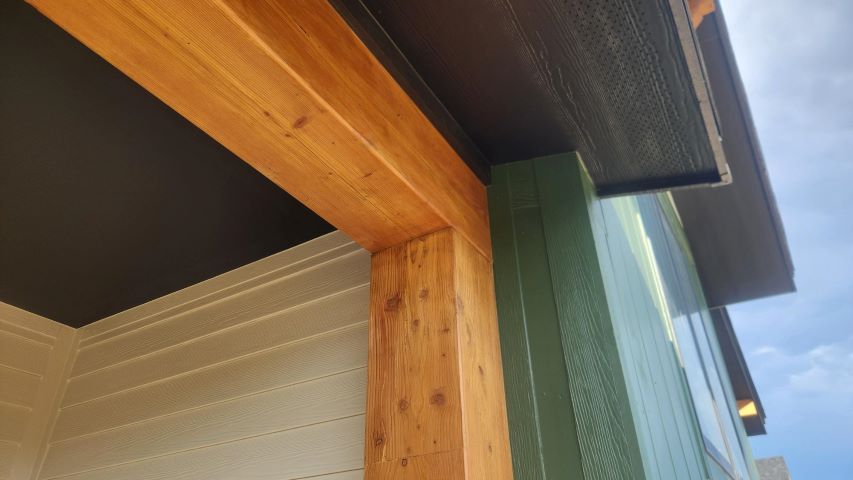

Front porch beams finished
-

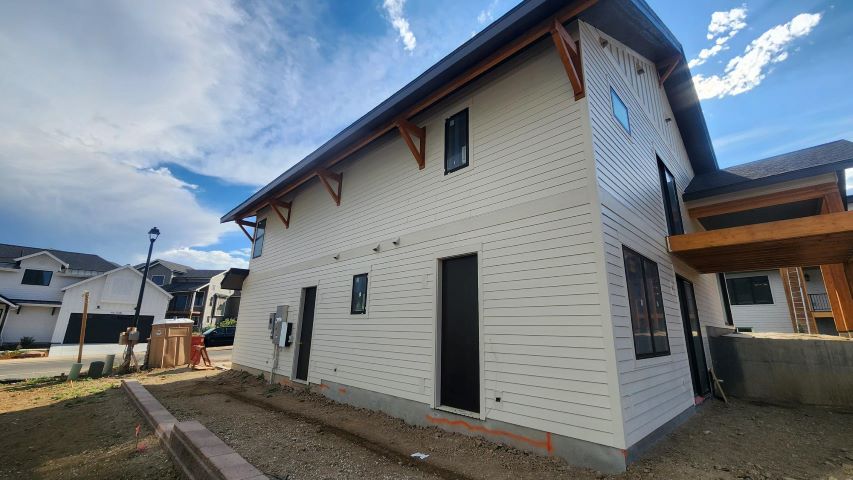

Exterior paint finished on east side
-

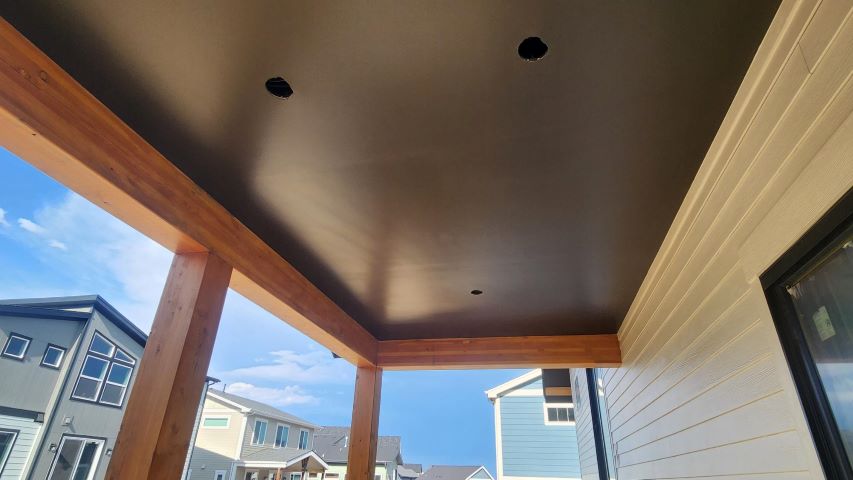

Patio soffit painted
-

Rear of the house painted
-

West side of the house painted
-

Soffits & fascia are painted
-

Prefinished gutter & downspout metal is selected
-

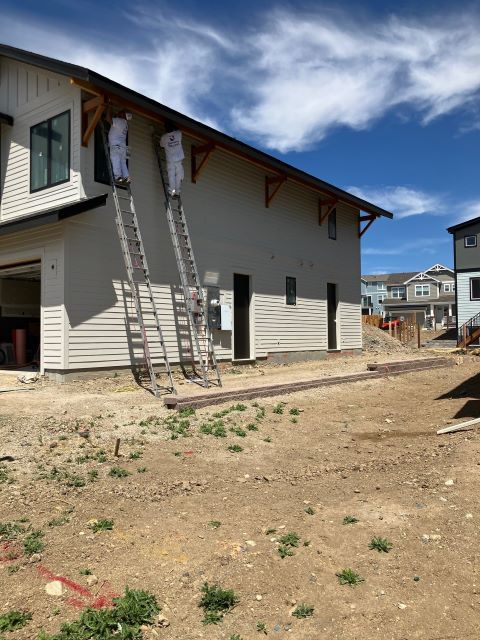

East side beams & brackets being clear sealed
-

Priming exterior siding & trim
-

Caulking & priming
-

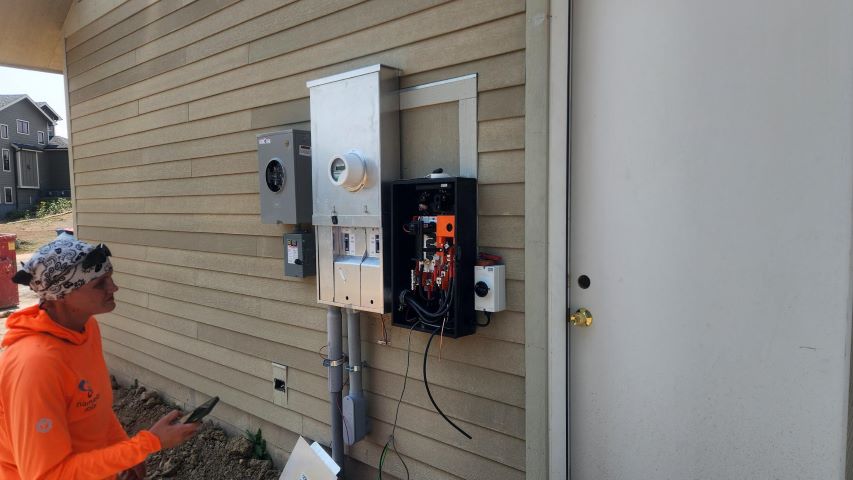

Tesla battery controllerÂ
-

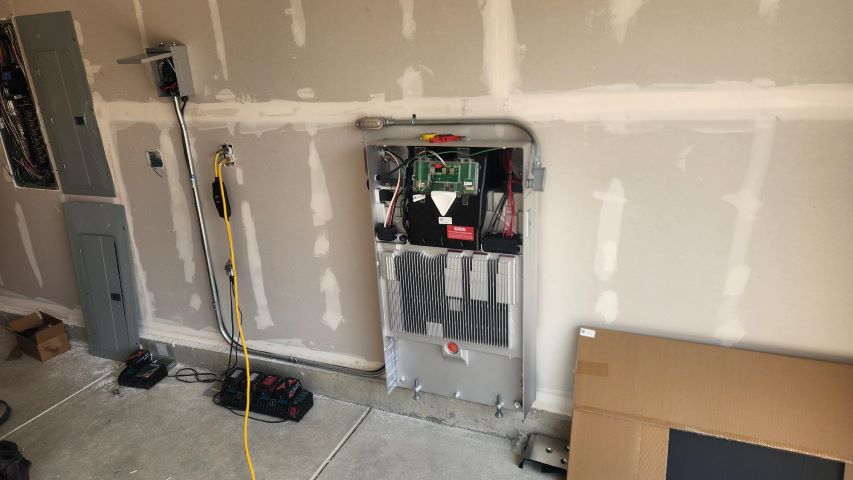

Tesla battery in the garageÂ
-

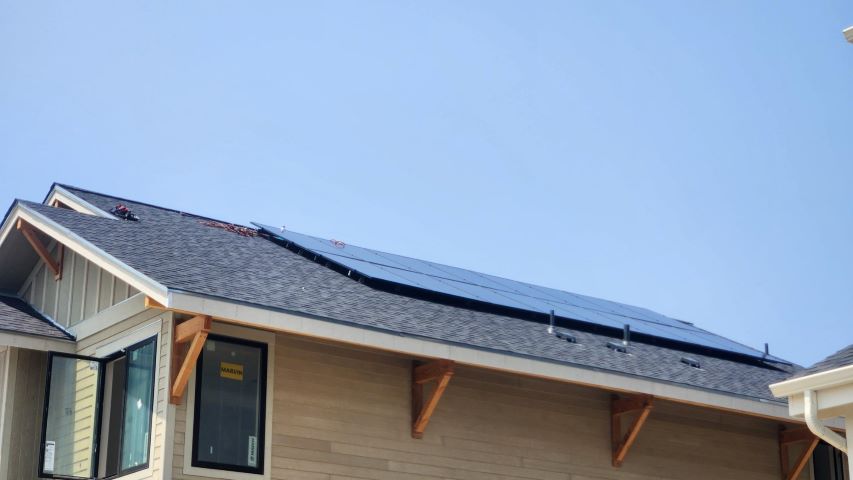

Solar panels installed
-

Solarium tiles are installedÂ
-

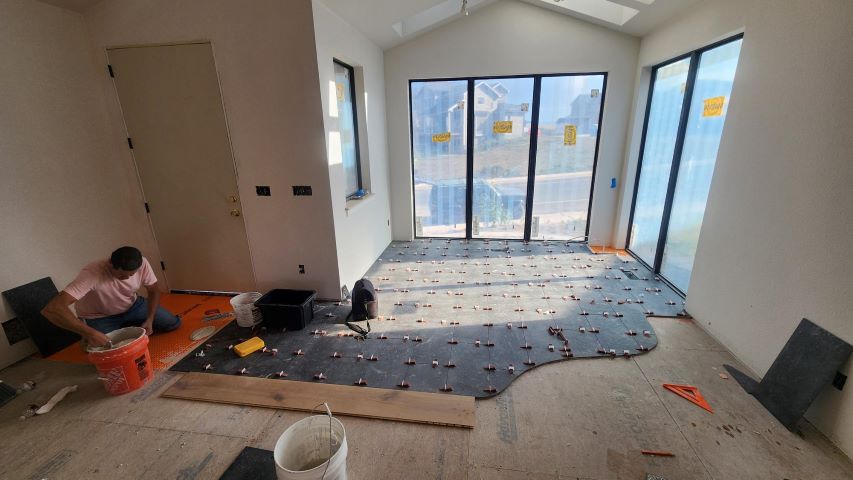

Tiles in solarium being installedÂ
-

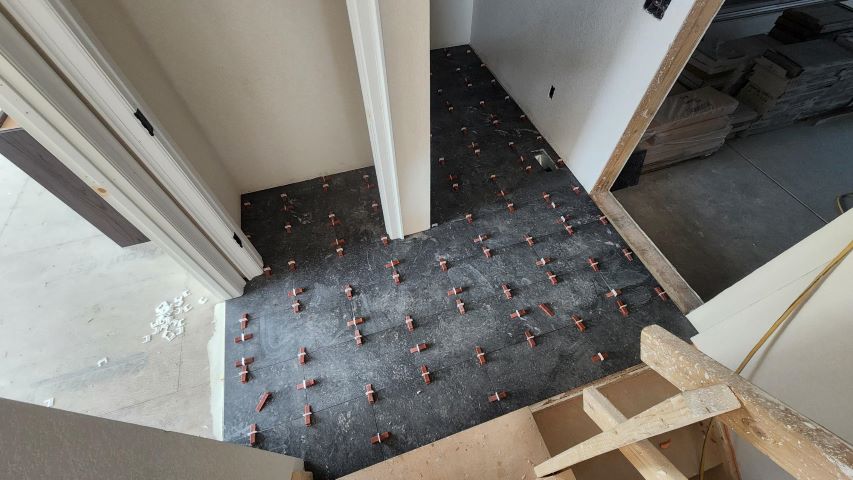

Hallway tiles installed with leveling clips
-

Schulter Ditra mat system in progress-Note the piano shaped radius
-

Installing Schulter Ditra mat in solarium & entry
-

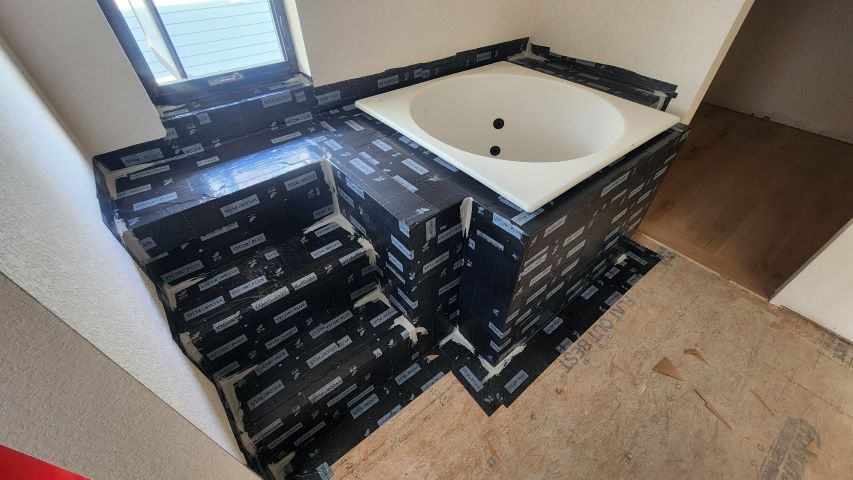

Tub deck waterproofed
-

Tub deck protected with Vycor flashingÂ
-

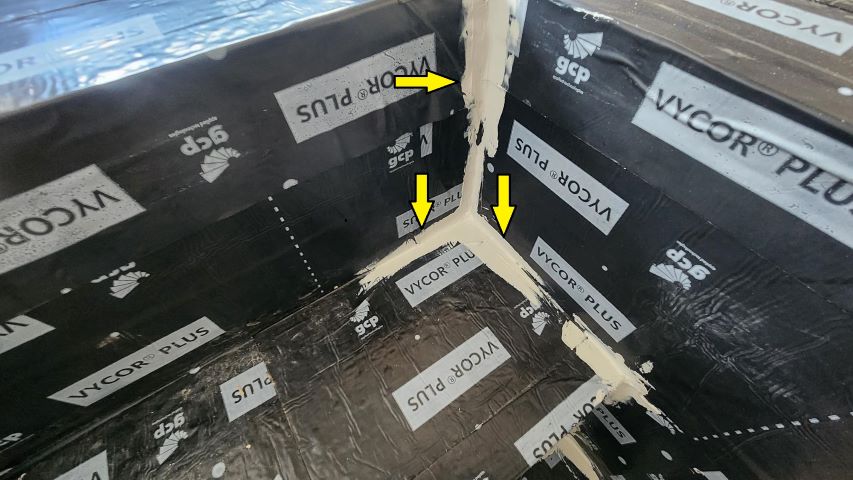

Vycor on tub deck and corners sealedÂ
-
_thumb.jpg)

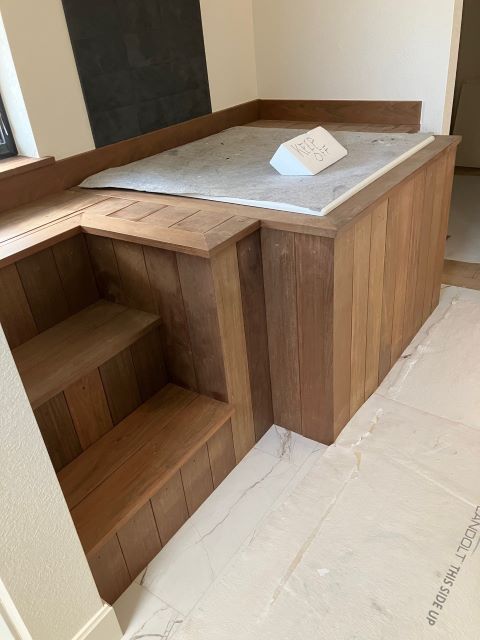

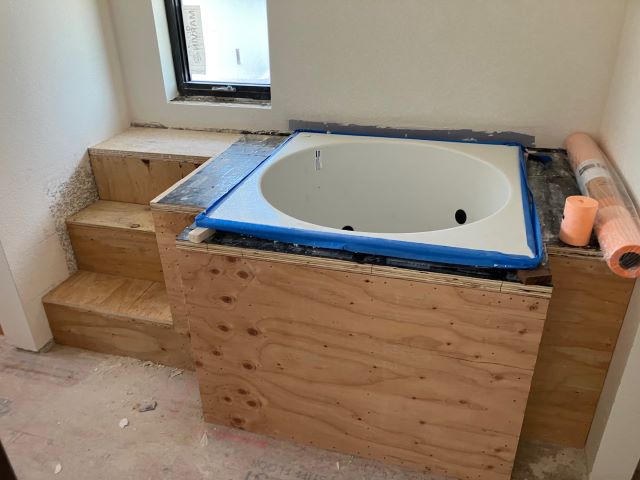

Soaking tub prepped for IPE (iron wood decking)
-

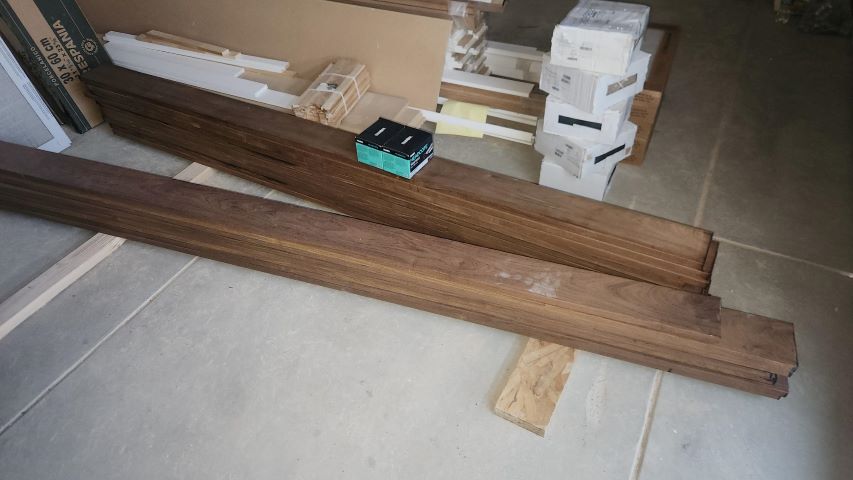

IPE wood for tub deck delivered
-

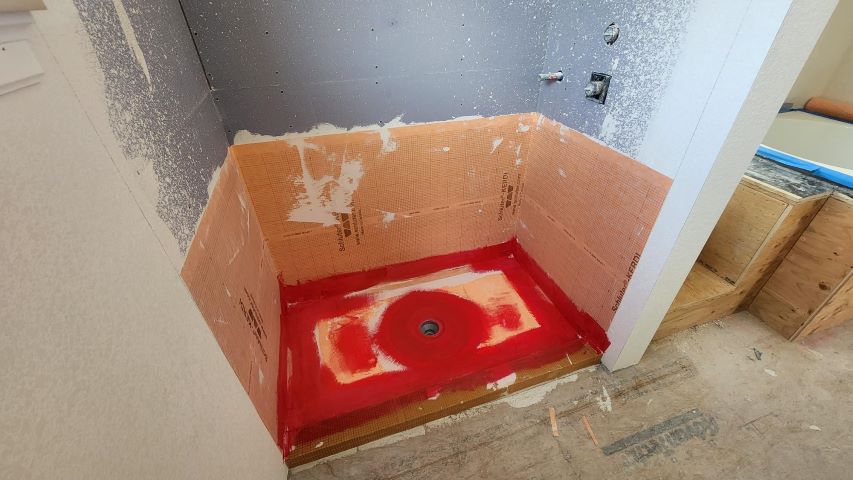

Shower Schluter system waterproofingÂ
-

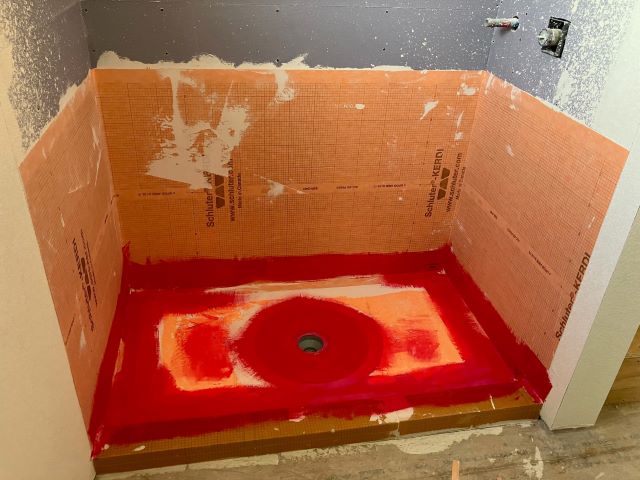

Shower pan & waterproofing system
-

Tiles delivered
-

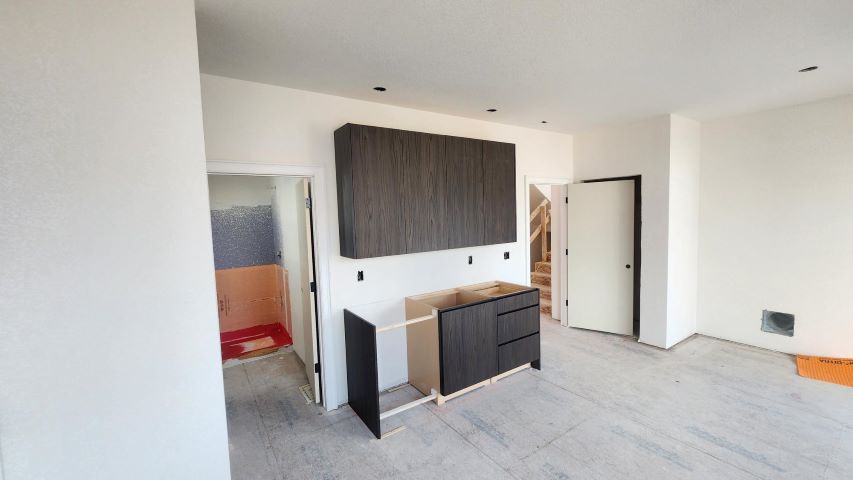

Cabinets in studioÂ
-

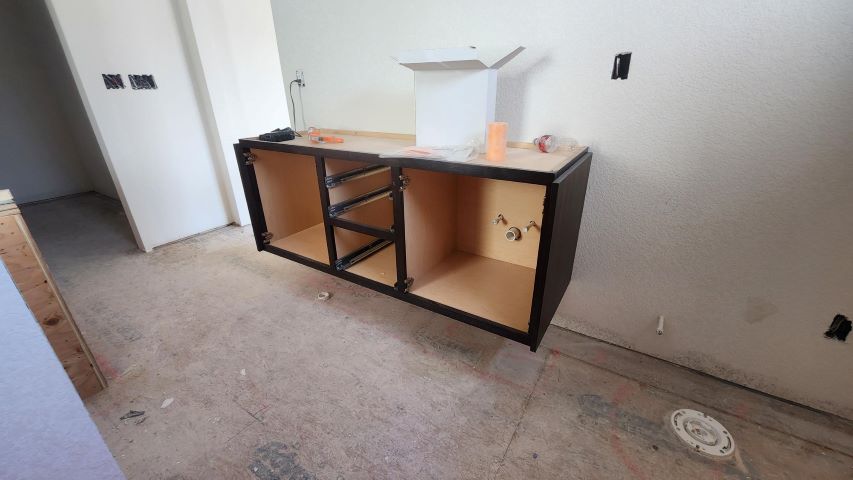

Bathroom floating cabinets installation in progress
-

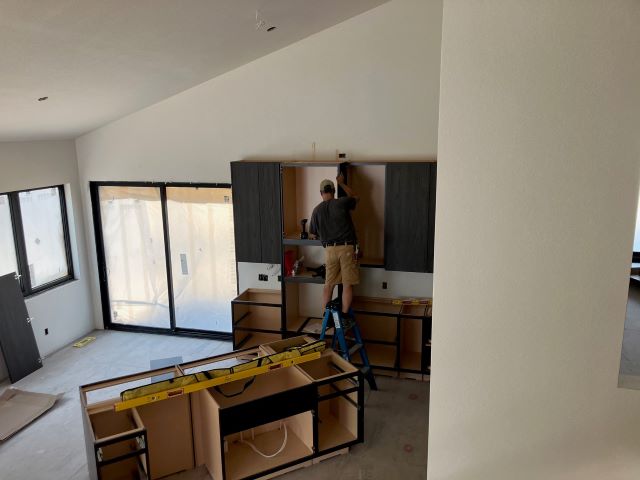

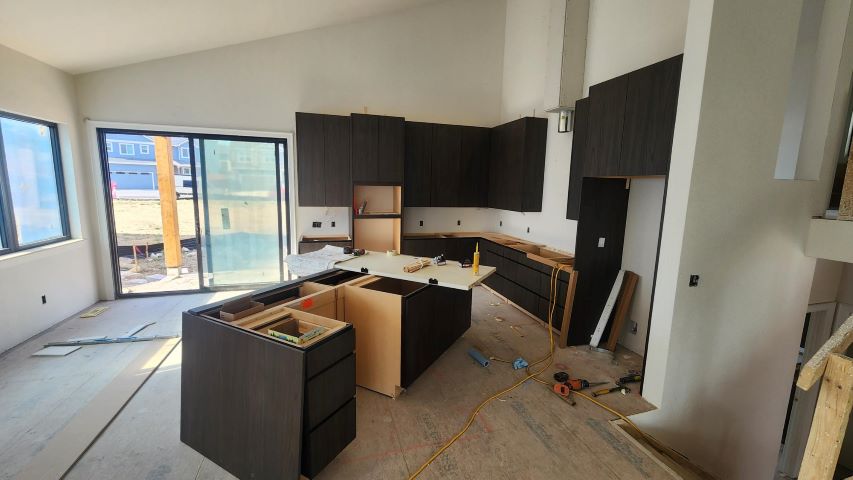

Kitchen cabinets installation in progress
-

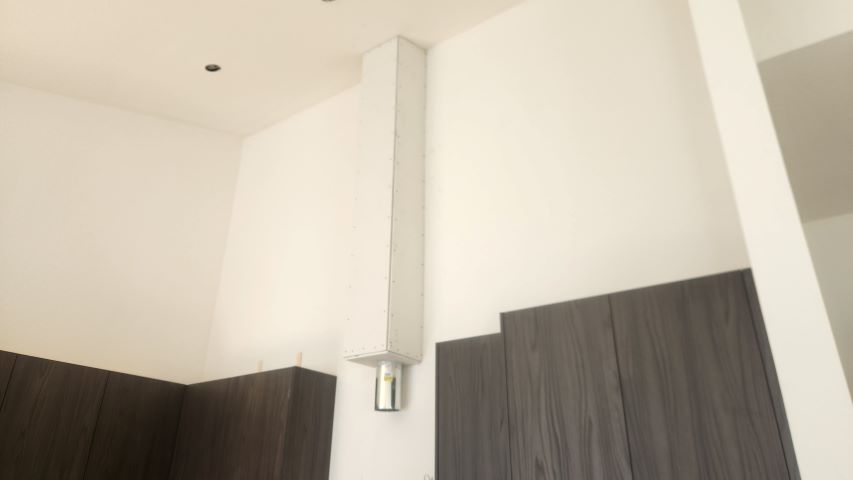

Range hood chase installed on tall kitchen wall
-

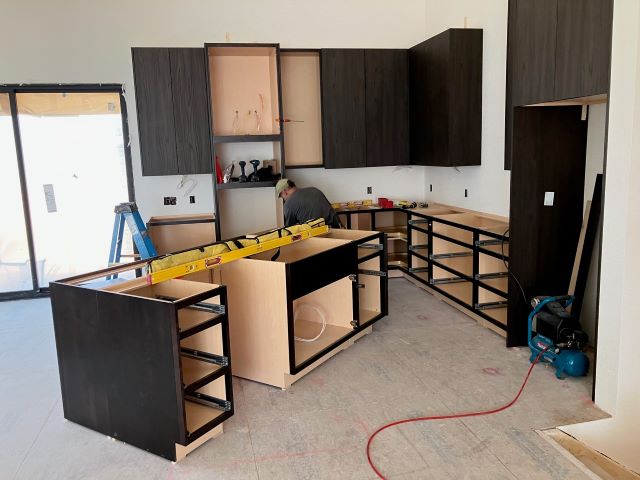

Kitchen cabinets being installed
-

Kitchen cabinets being installed
-

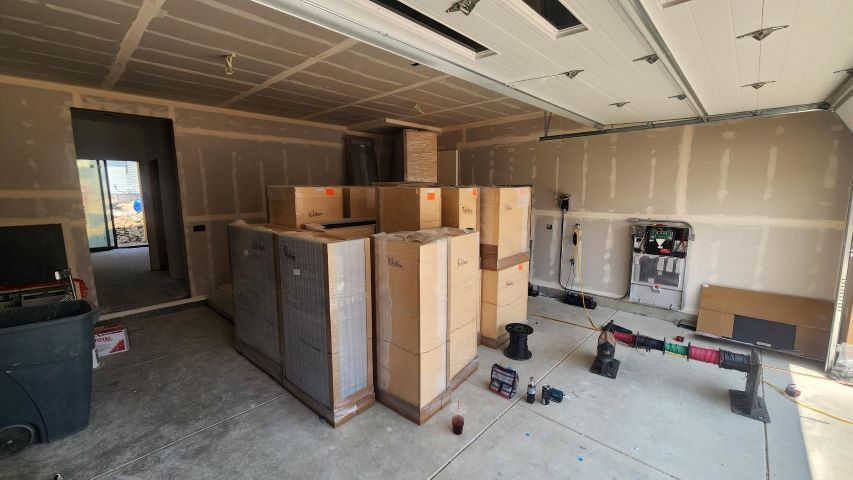

Cabinets delivered and stored in garageÂ
-

Sealing station holds & emits sealant under pressure at 100 PSI
-

Sealing station holds & emits sealant under pressure at 100 PSI
-

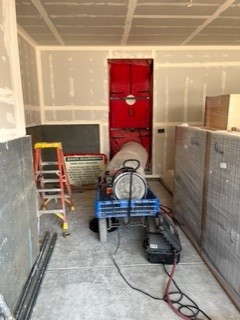

Fan and control box for monitoring of aero sealing
-

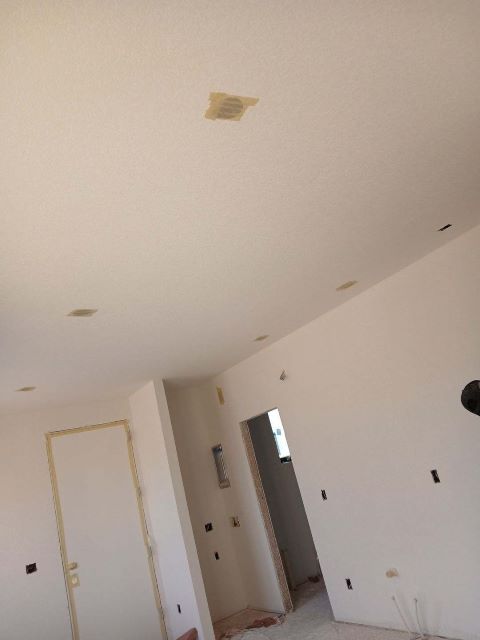

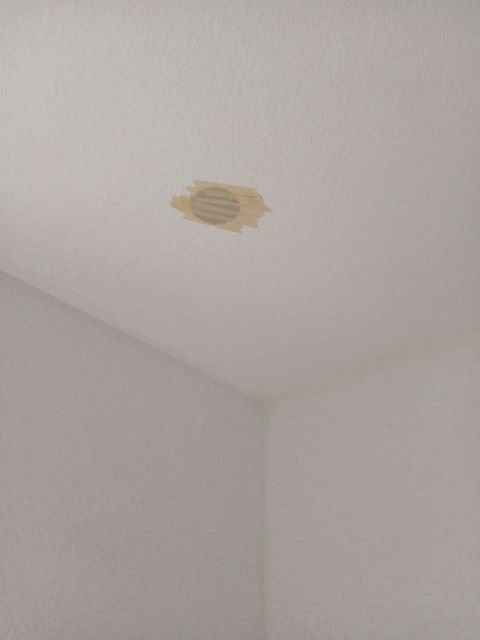

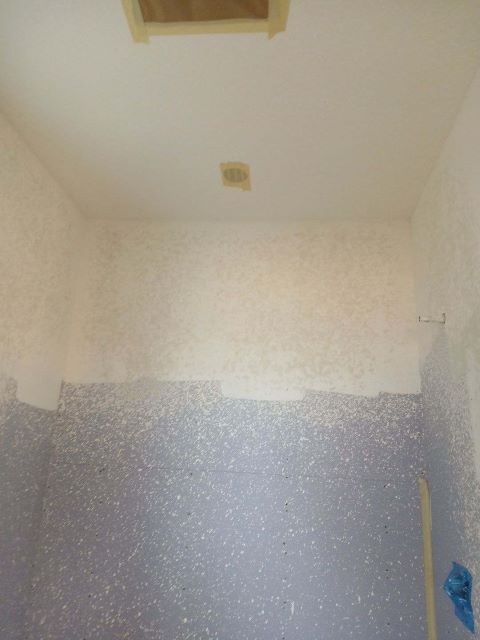

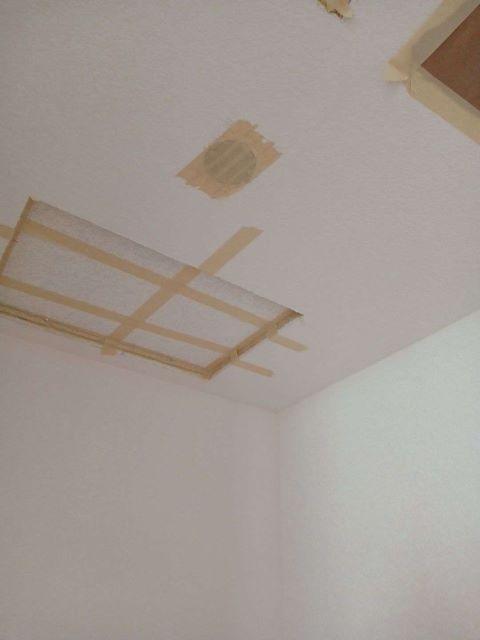

All penetrations sealed for AeroBarrier sealant application
-

All penetrations sealed for AeroBarrier sealant application
-

All penetrations sealed for AeroBarrier sealant application
-

All penetrations sealed for AeroBarrier sealant application
-

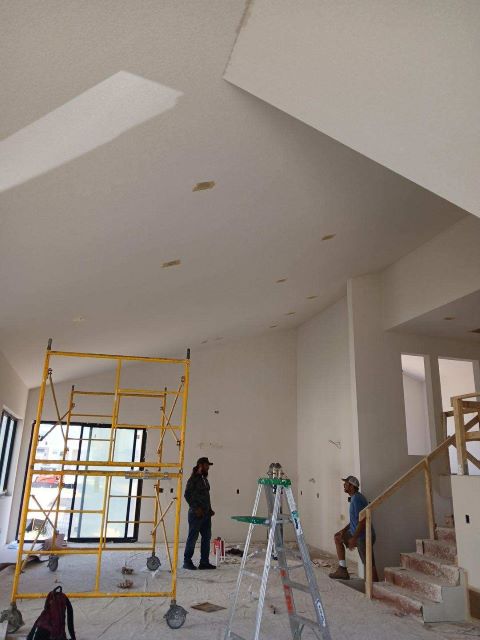

Drywall finishing crew
-

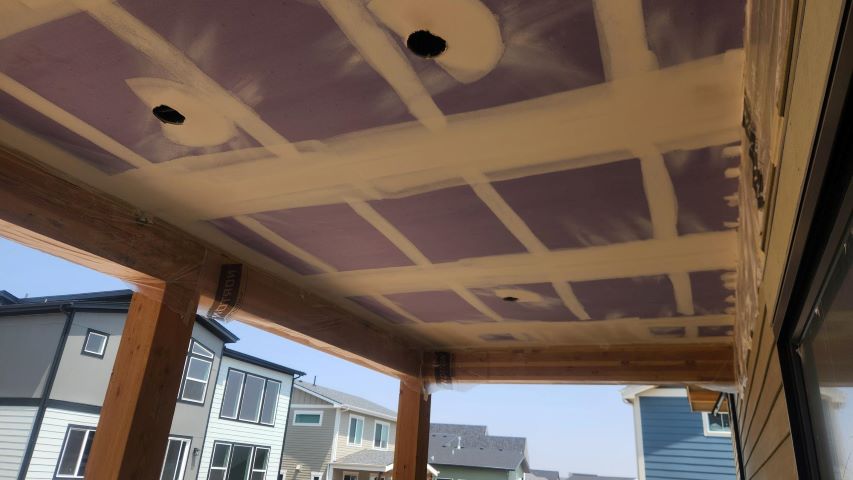

Exterior drywall taped and finish on rear porch ceiling
-

Drywall finished in kitchen
-

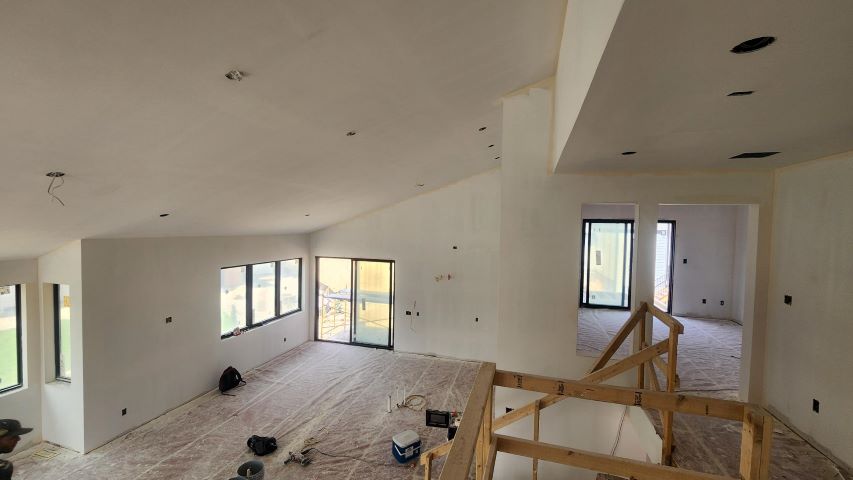

Drywall finished in great room
-

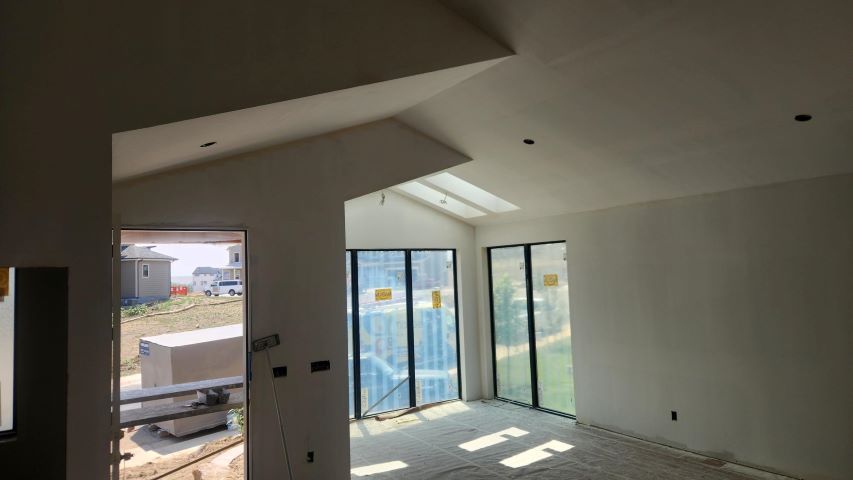

Drywall finished in solariumÂ
-

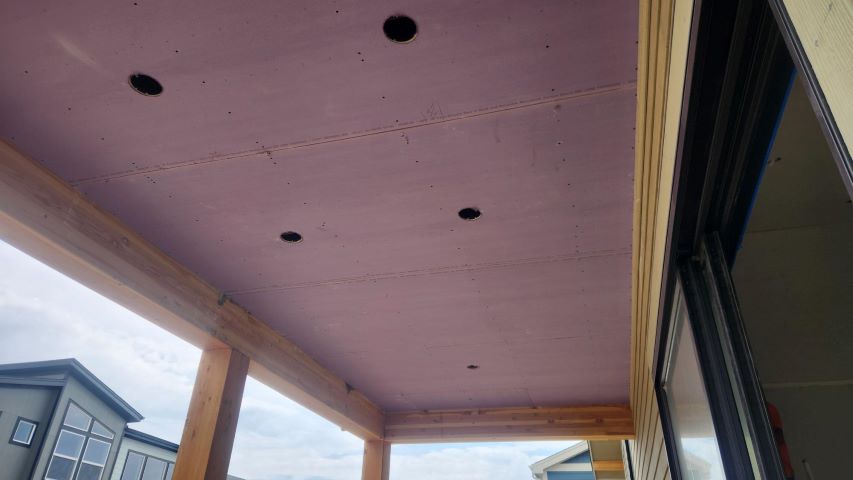

Exterior drywall installed on porch ceiling
-

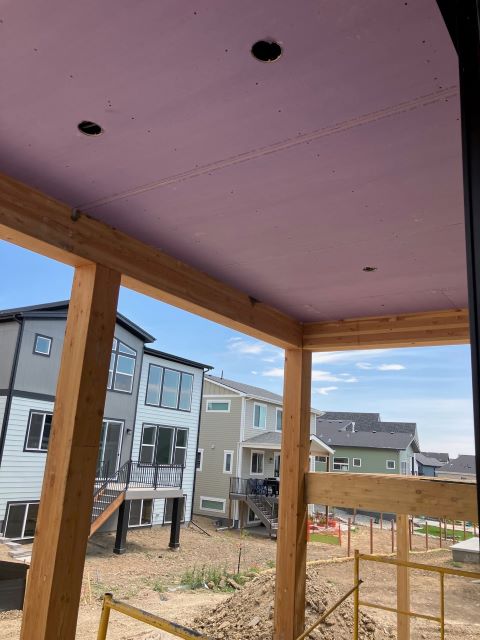

Exterior grade drywall on rear porch ceiling
-

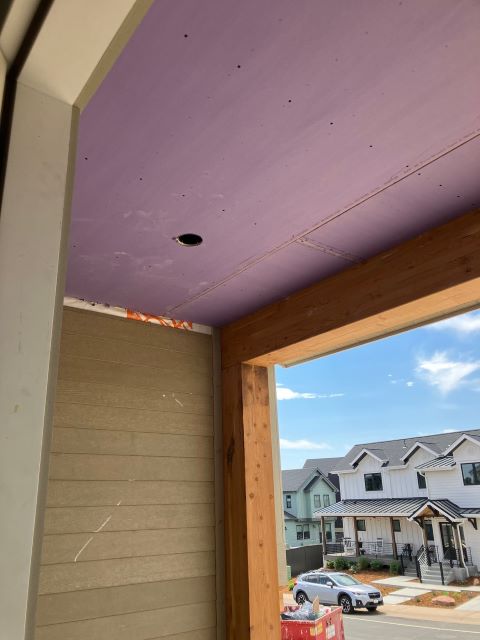

Front porch exterior grade drywall ceiling
-

Mud applied to openings
-

Drywall finishing in primary bedroom
-

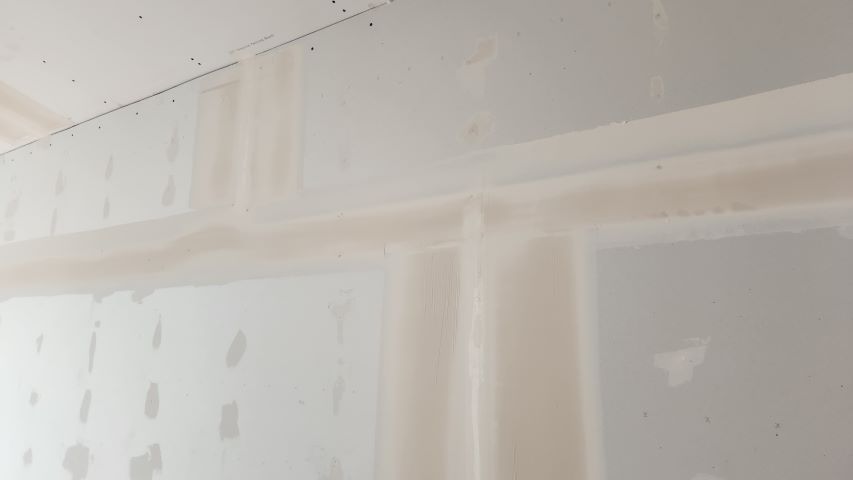

Drywall is taped
-

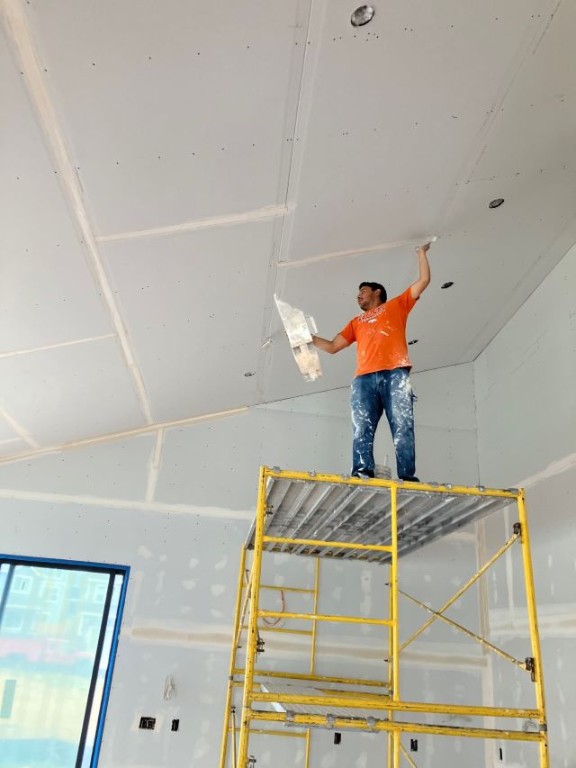

Tape being applied to ceiling
-

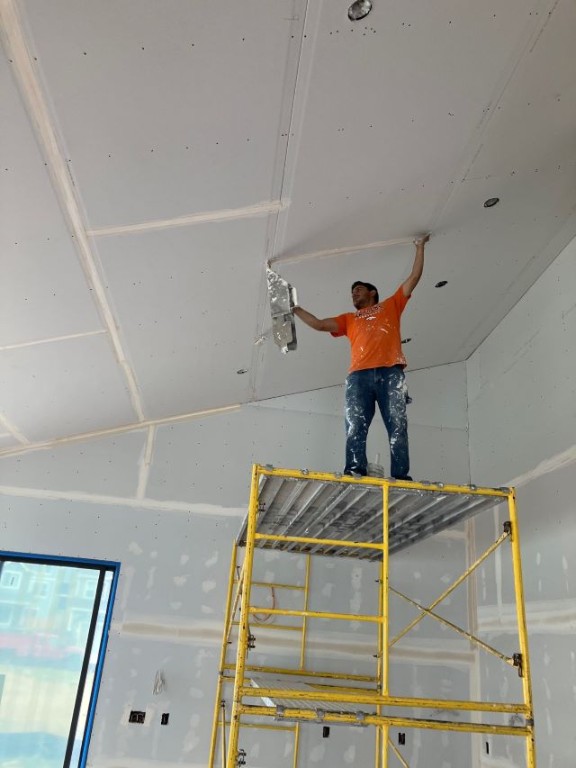

Tape being applied to ceiling
-

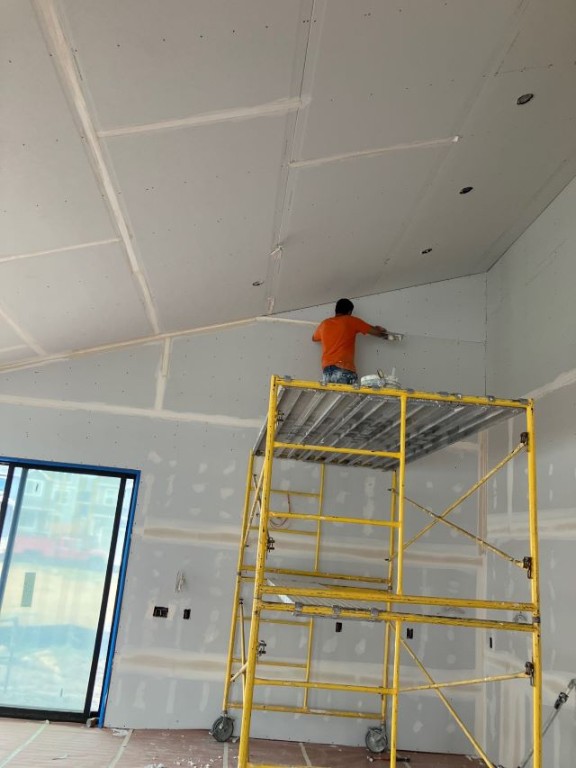

Tape application to walls
-

Safety rail post bases ready for install
-

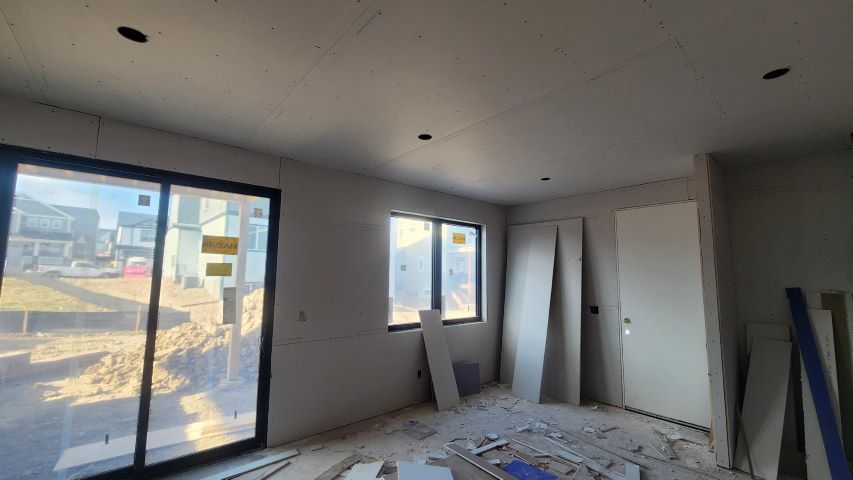

Drywall installed in studio
-

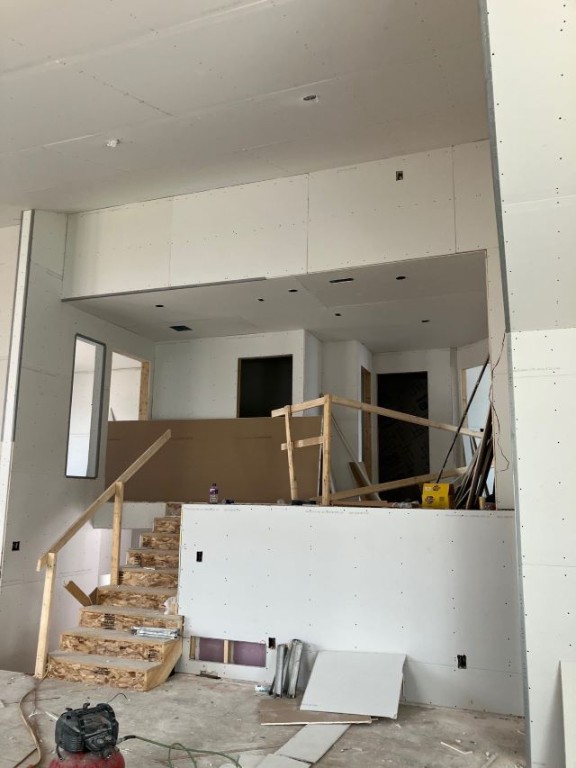

Drywall at loft
-

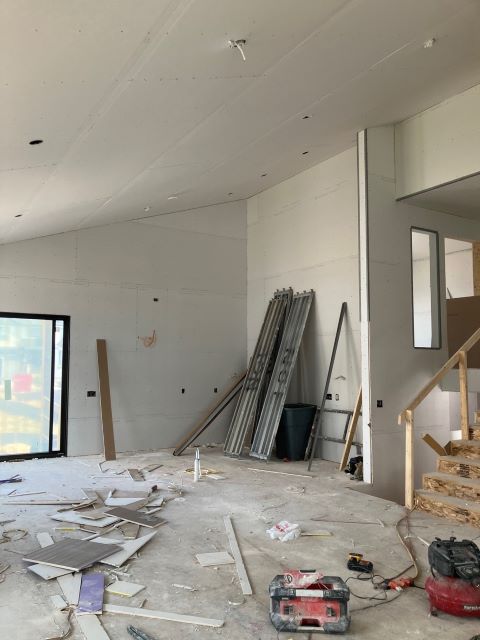

Drywall in kitchen
-

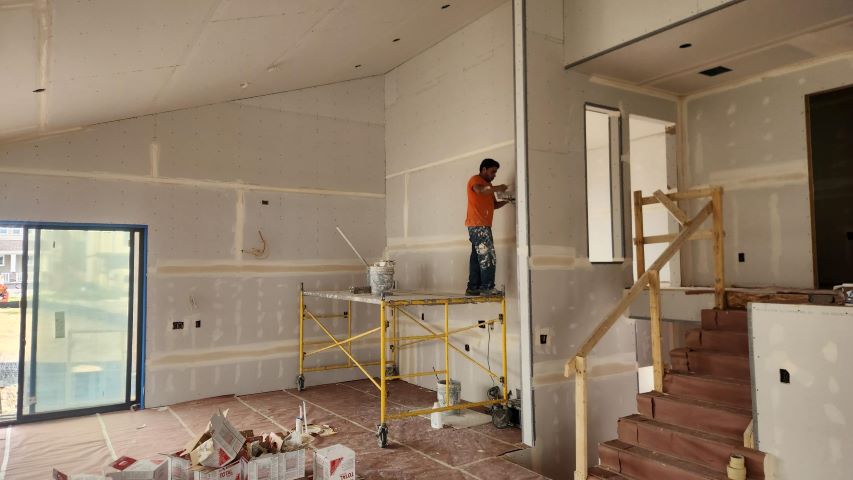

Drywall crew taping
-

Drywall installed in solarium
-

Installing drywall in studio
-

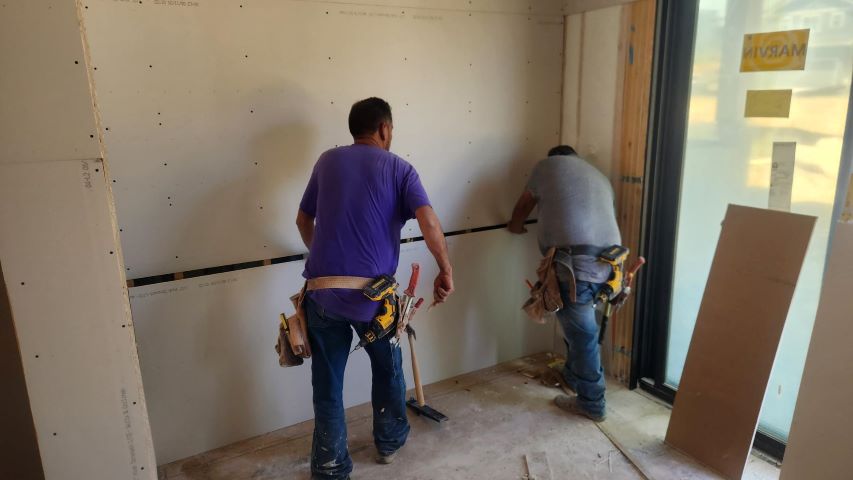

Installing drywall
-

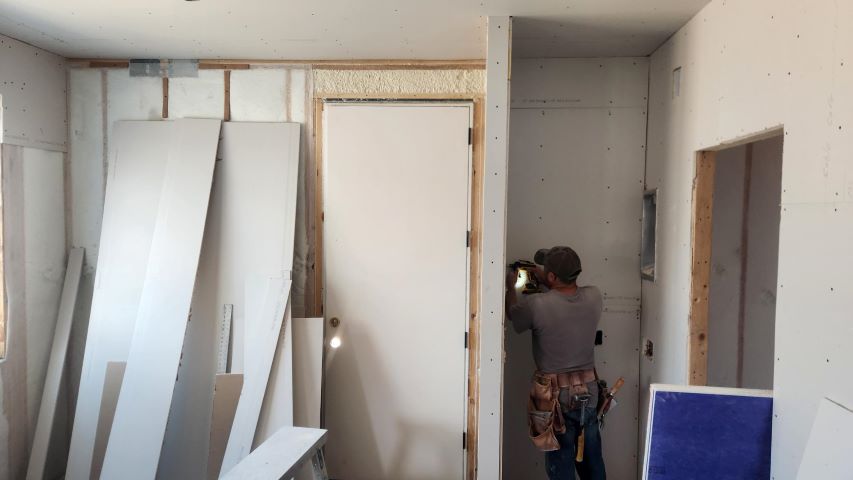

Installing drywall
-

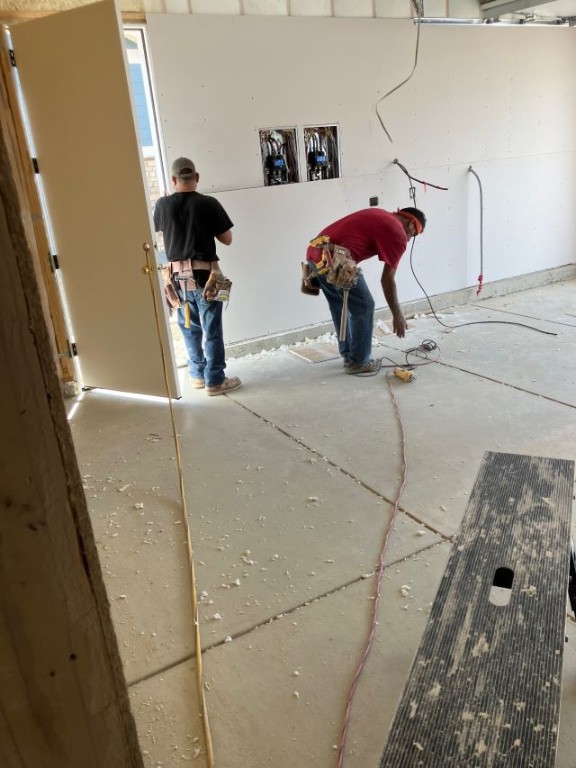

Installing drywall in garage
-

Protective paper on garage floor
-

Window protective tape being installed
-

Floor protection for a cleaner floor in place
-

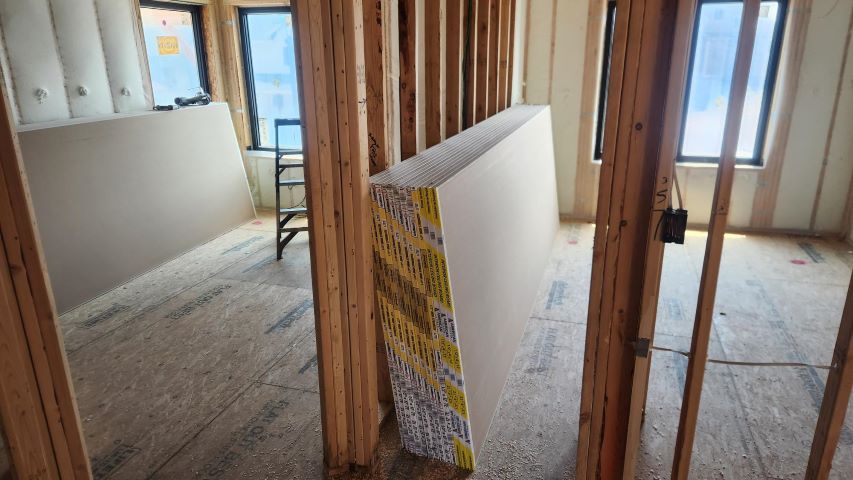

Drywall delivered
-

Special plumbing funnel for attic condensate drain
-

Egress cover with ladder and operable access
-

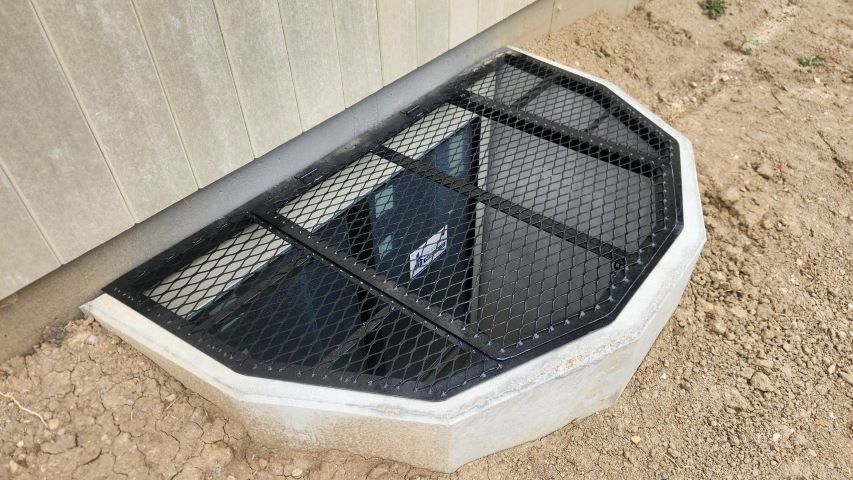

Window well covers are installedÂ
-

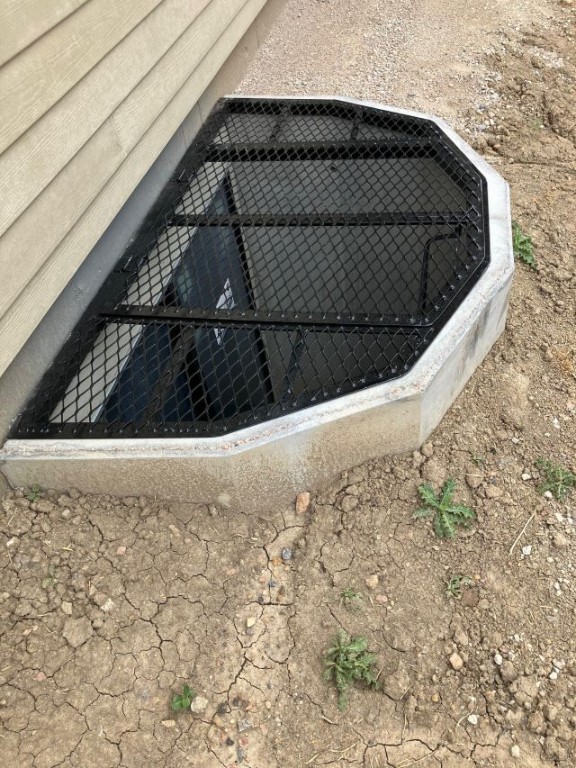

Window well covers installed
-

Proper yoke location
-

Interior cover in perfect condition
-

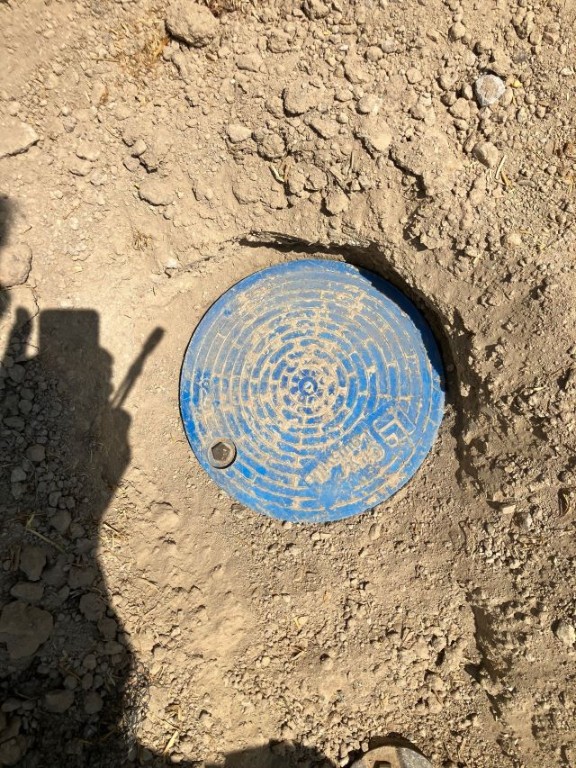

Meter pit cover un-damaged
-

AC condenser line is sealed to foundationÂ
-

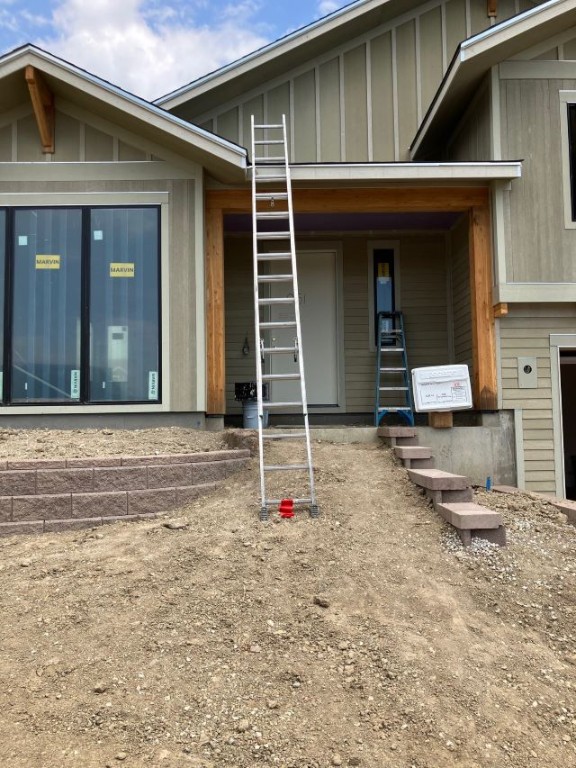

Ladder in place for final roof inspection
-

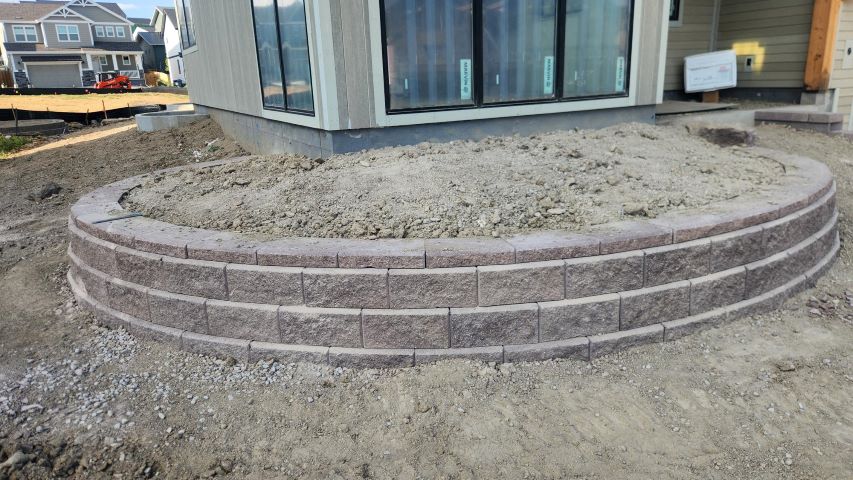

Round retaining wall by solariumÂ
-

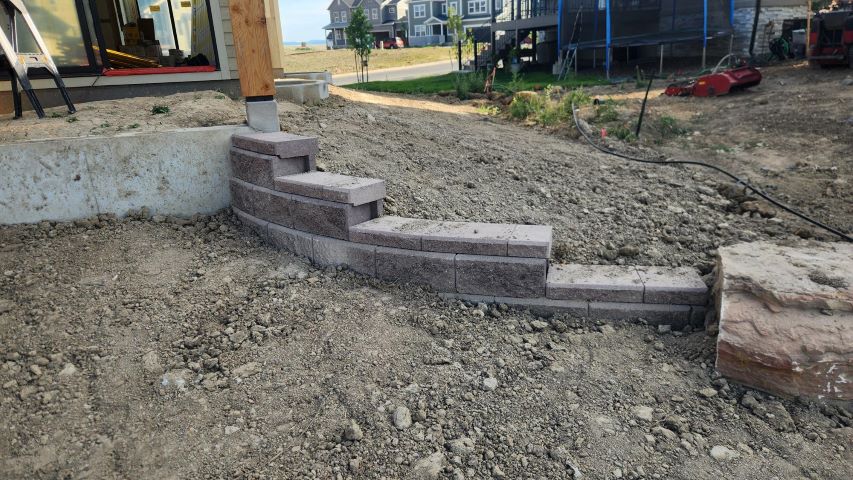

Retaining wall at back of house
-

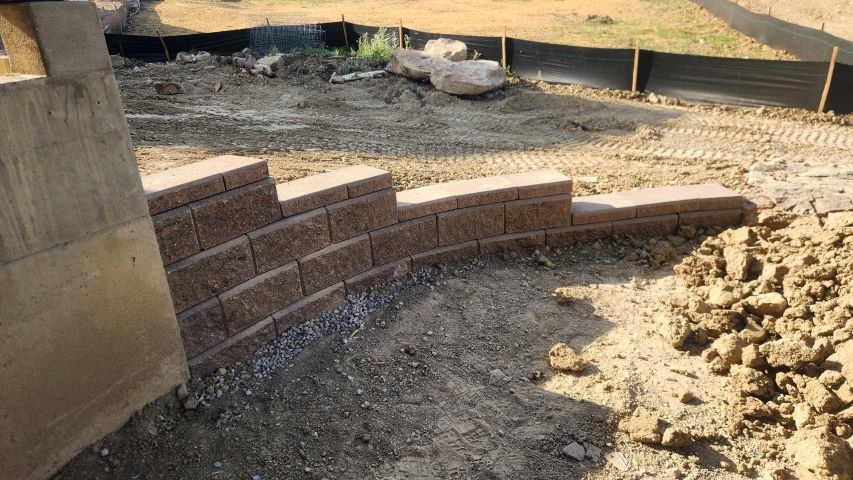

Retaining wall at studio patio
-

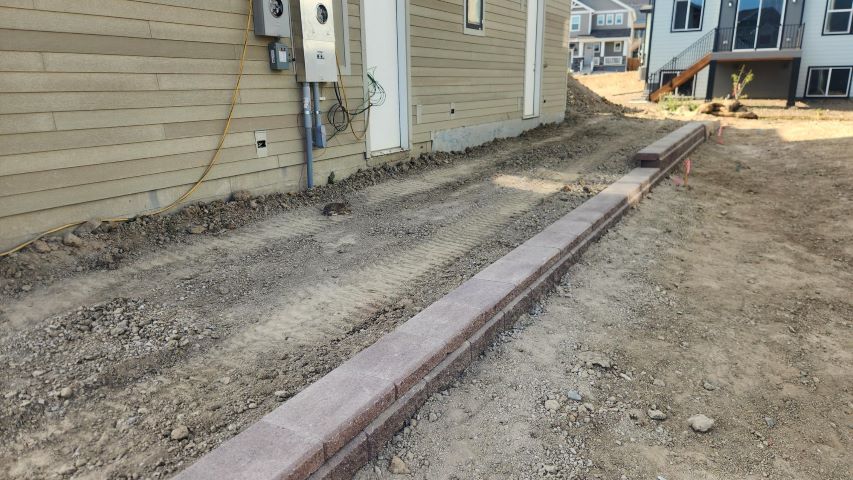

Retaining wall on east side for better drainage control
-

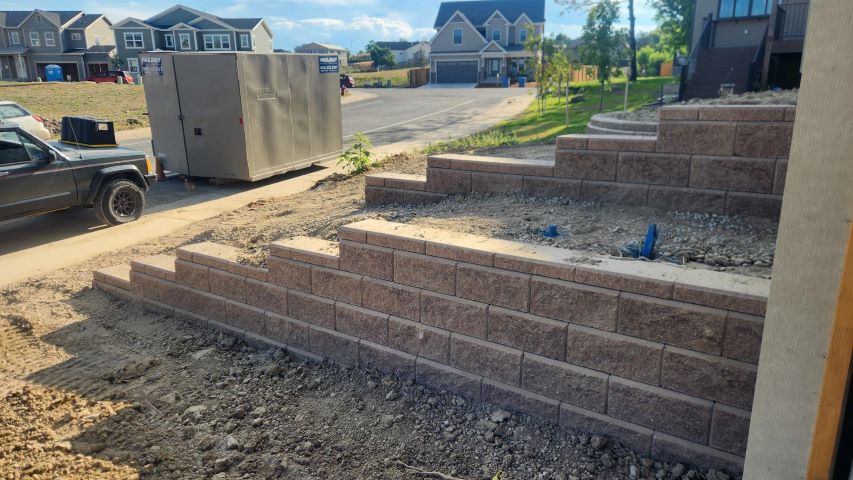

Entry retaining wallsÂ
-

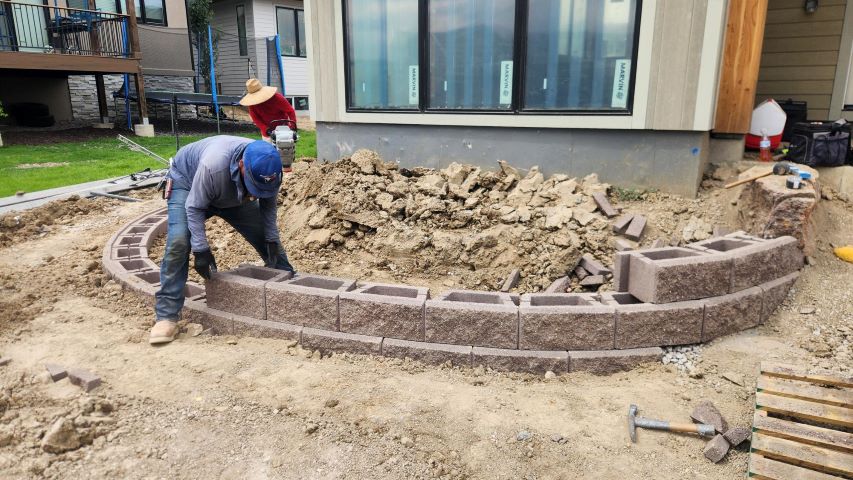

Retaining walls are build with locking blocks
-

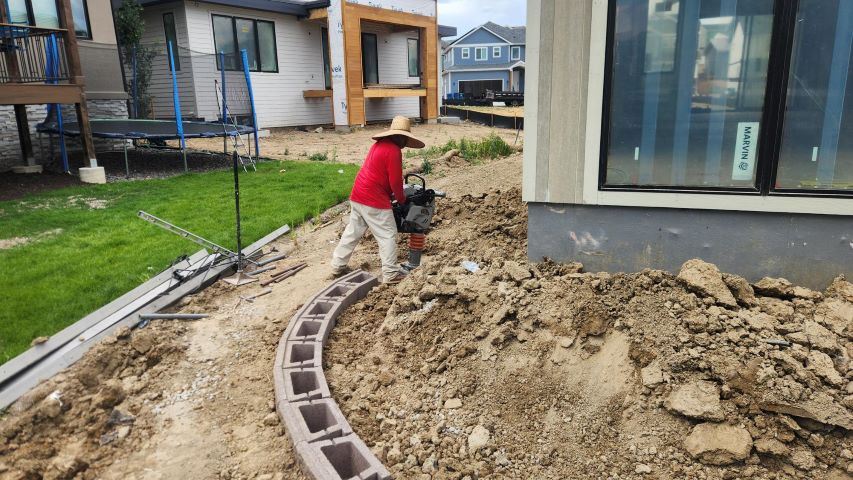

Compaction around retaining walls
-

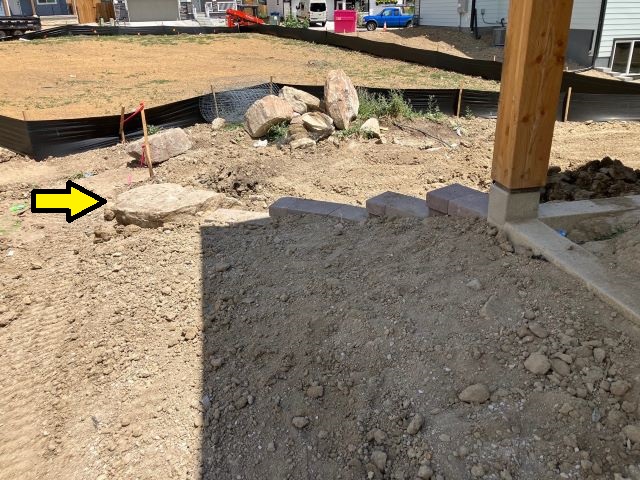

NW wall ending with boulder
-

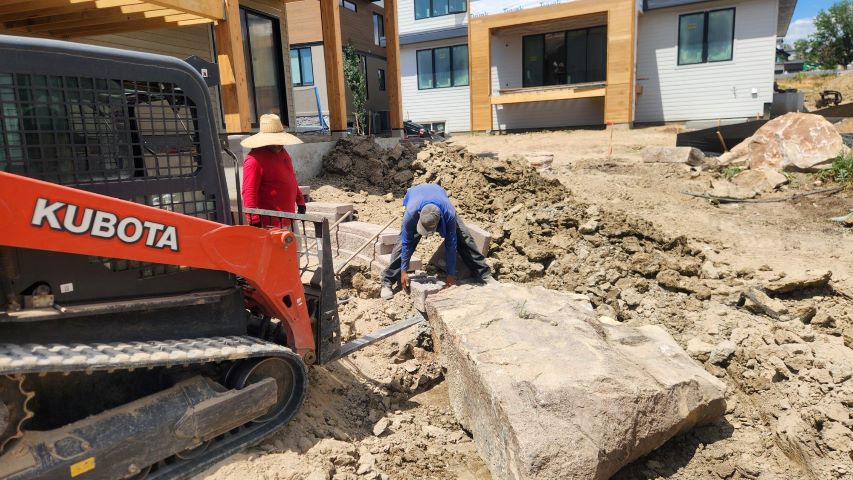

Large boulders were moved by tractorÂ
-

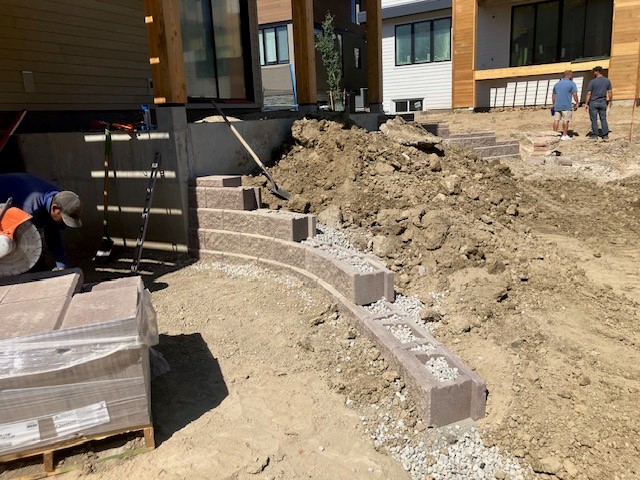

Rear retaining wall in progress
-

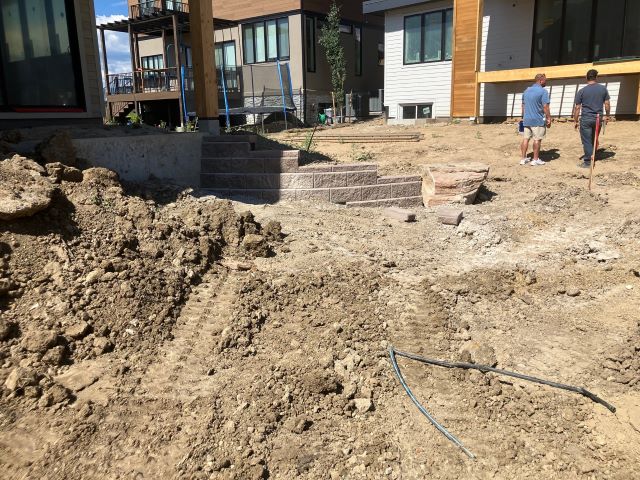

Small east retaining wall
-

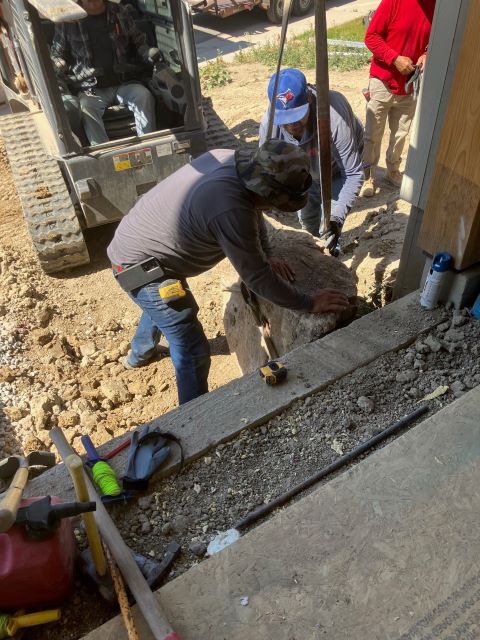

Starting boulder placement for wall around solarium
-

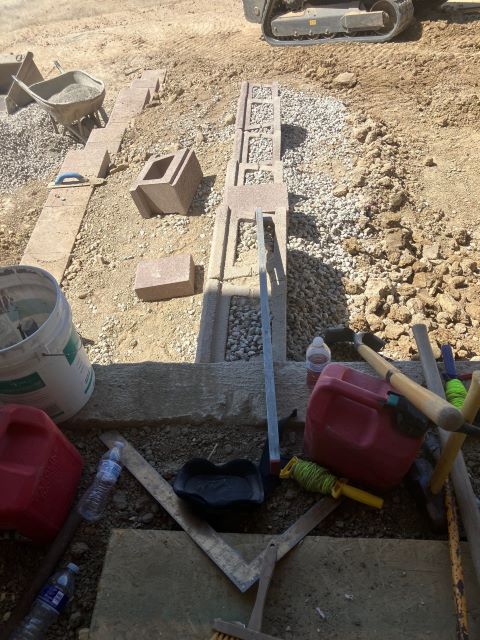

Upper entry retaining wall completed with gravel
-

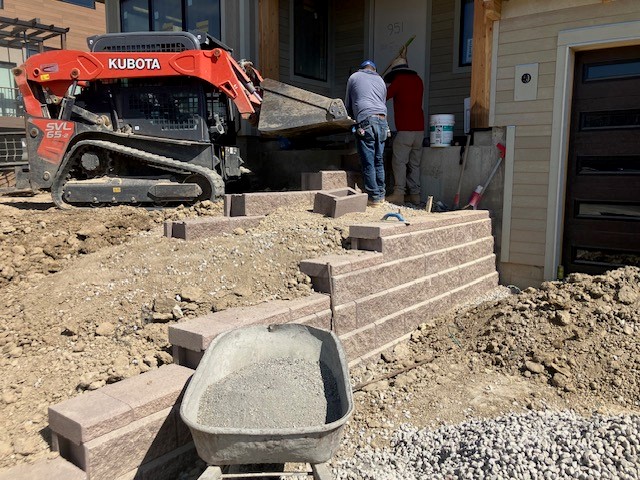

Lower wall completed
-

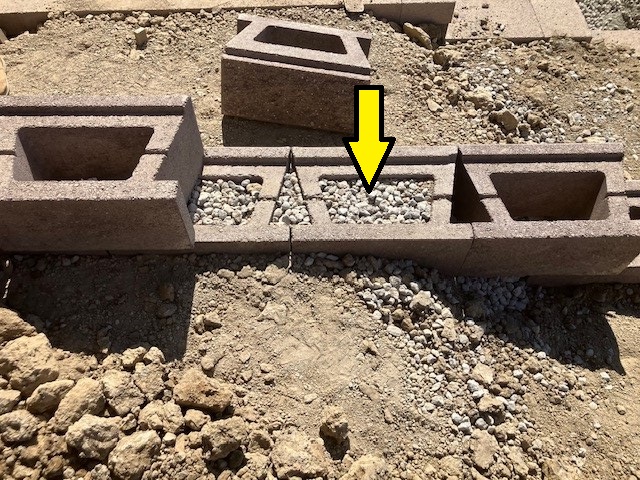

Level of blocks filled with gravel
-

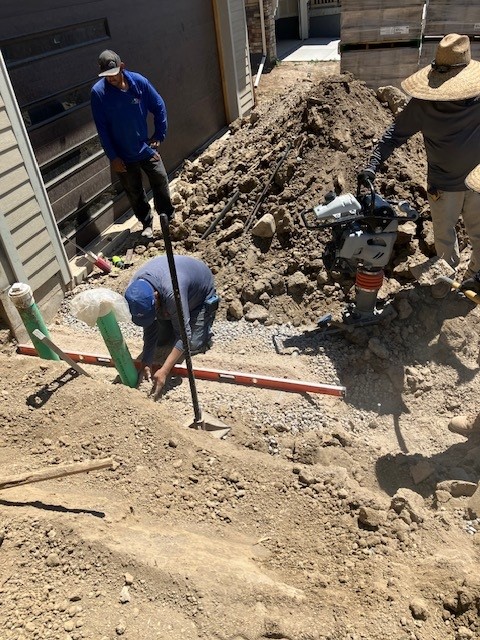

Leveling gravel base with bars and granite fines
-

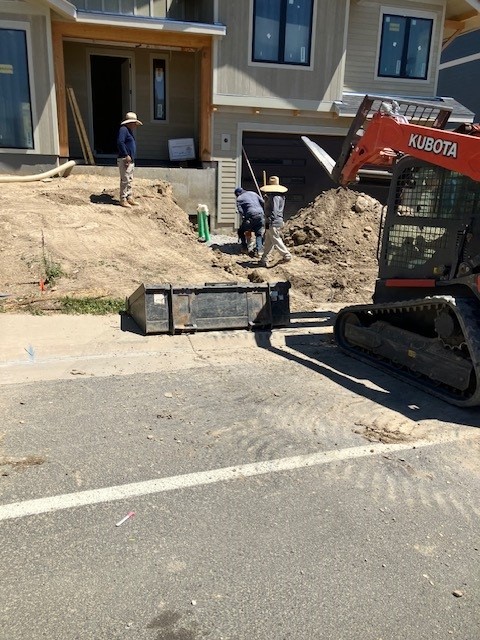

Placing gravel base
-

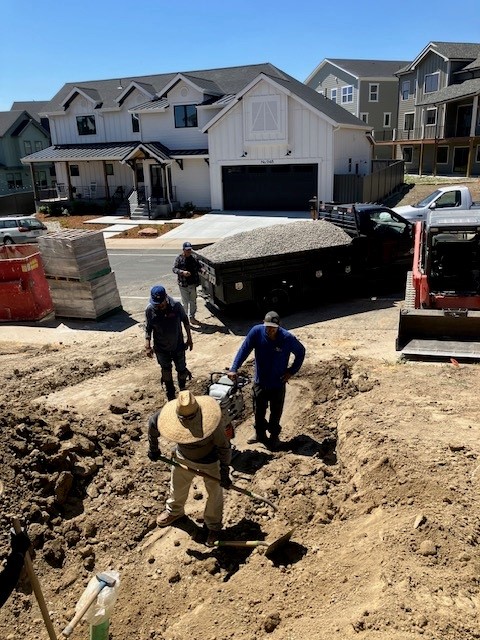

Gravel for wall base being unloaded
-

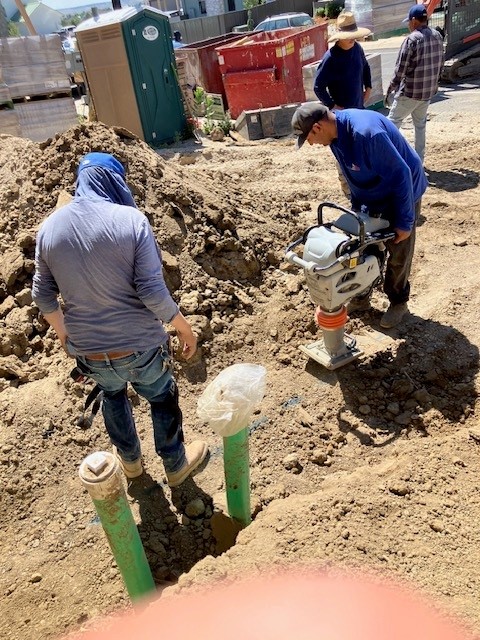

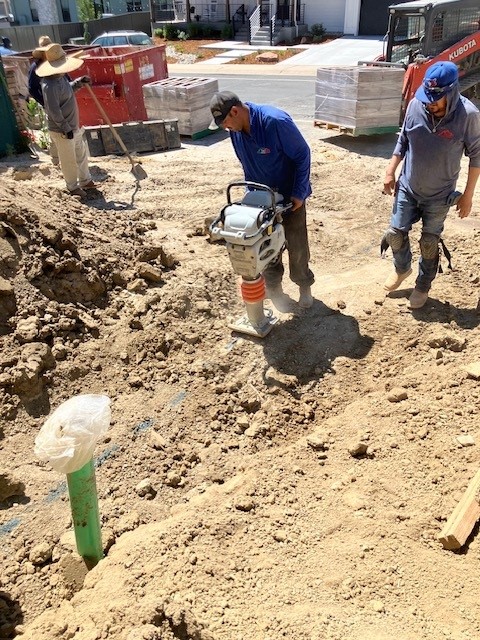

Compacting for wall base
-

Compacting for wall base
-

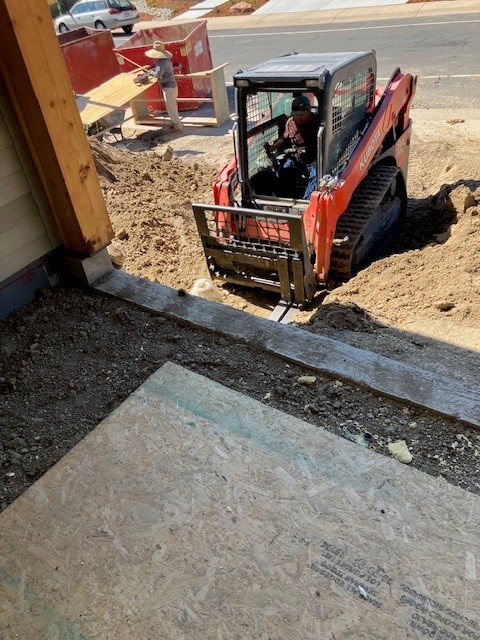

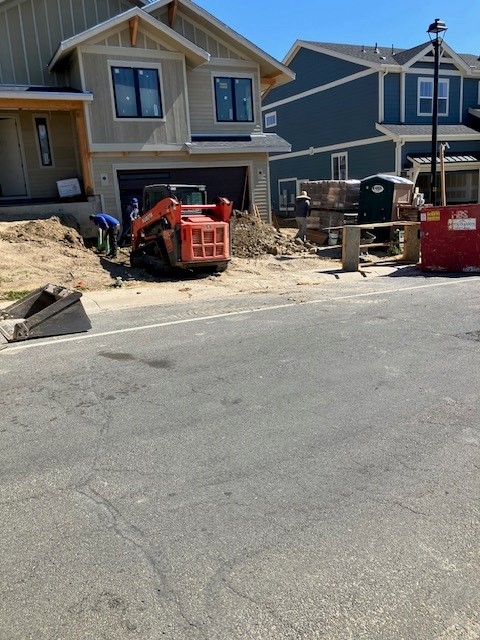

Cutting grade for lower front retaining wall
-

Cutting grade for lower front retaining wall
-

Start of retaining wall excavation
-

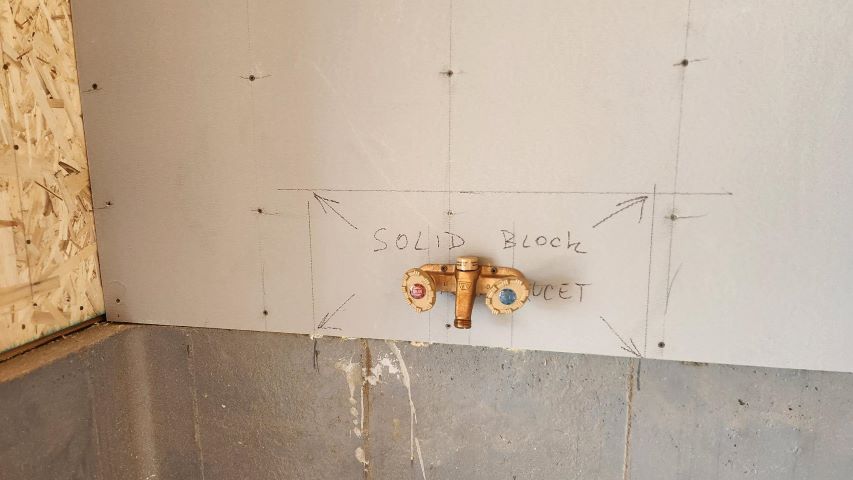

Hot cold faucet in garage
-

Additional insulation installed to protect heat ducts
-

Rigid insulation for heat returns behind wall
-

Rigid insulation to be sealed on garage wall
-

Extra insulated lid to protect plumbing drains in garage ceilingÂ
-

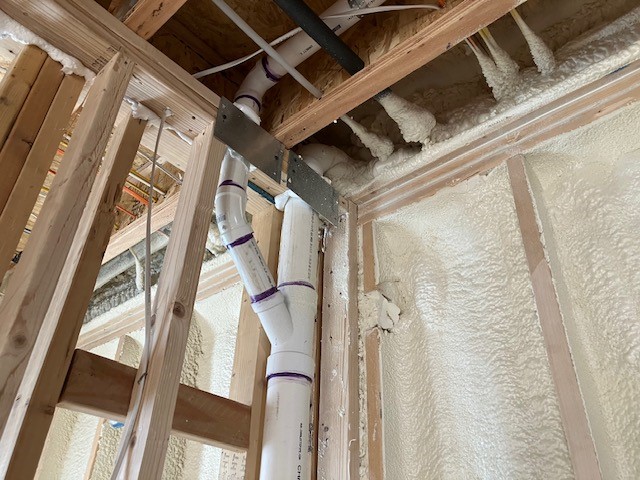

Closed cell foam at rim joist between garage & house
-

Closed cell foam in garage wall to house
-

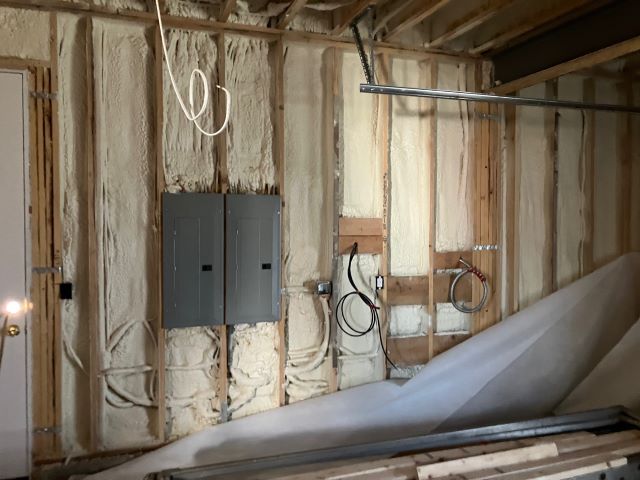

Closed cell foam in garage walls
-

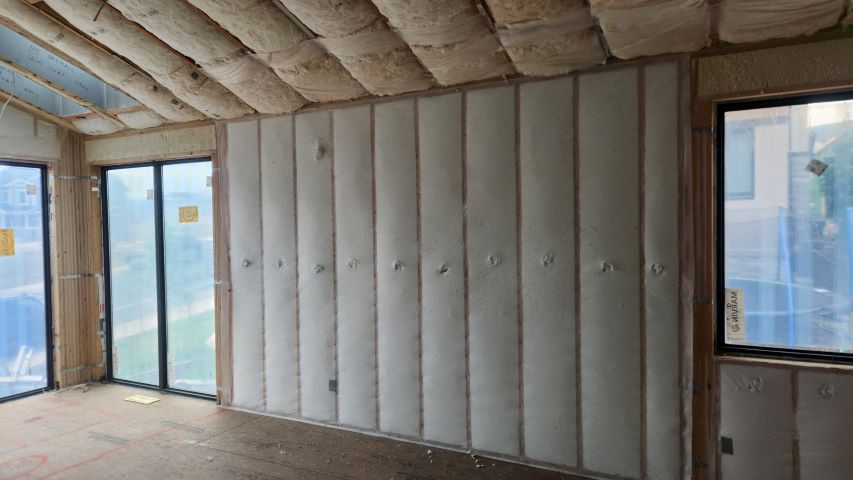

Walls are insulated with 2 inch closed cell foam & blown fiberglassÂ
-

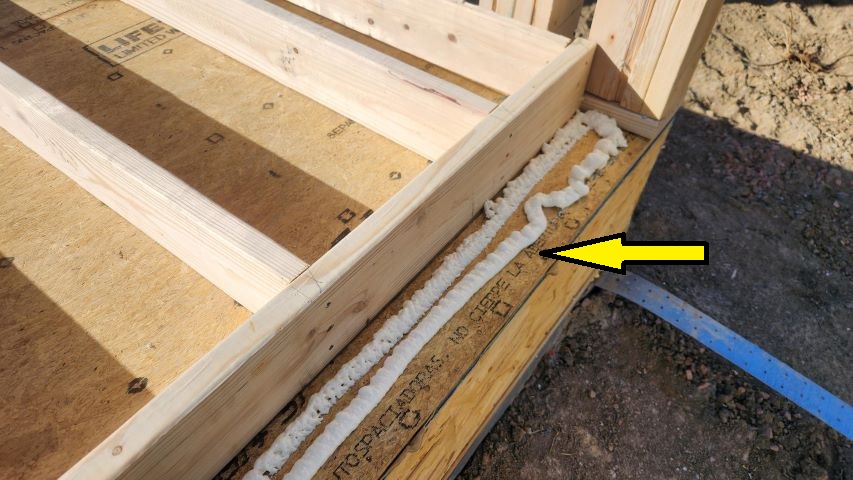

R-60 batt insulation up 8 feet in dining room ceiling
-

R-60 batt insulation in solarium
-

Walls in upper bedroom completed
-

Insulated kitchen wall
-

Walls in kitchen completed
-

Starting fiberglass blown-in insulation in kitchen walls
-

Netting on walls ready for blown-in insulation
-

Netting in primary closet
-

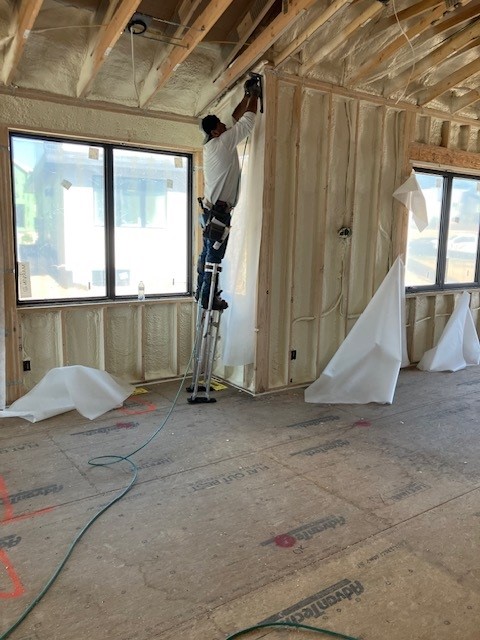

Stapling netting
-

Stapling netting
-

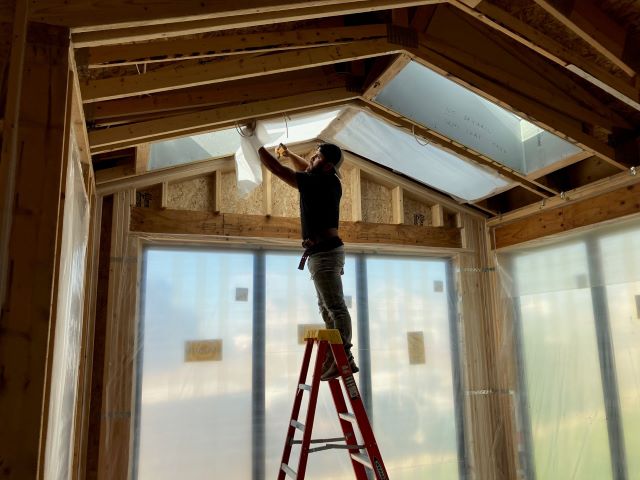

Installing netting protection over skylights
-

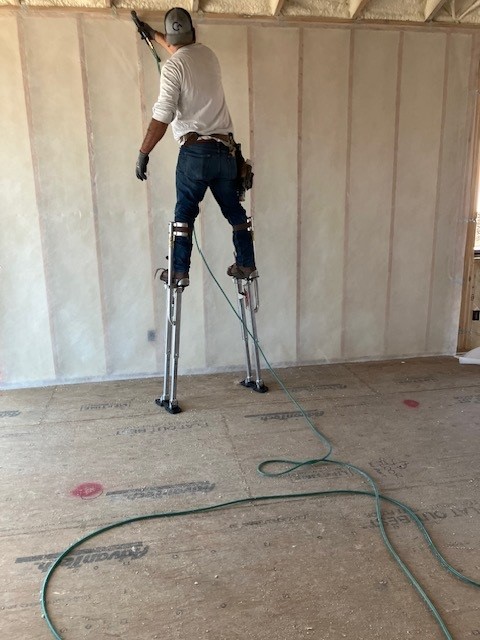

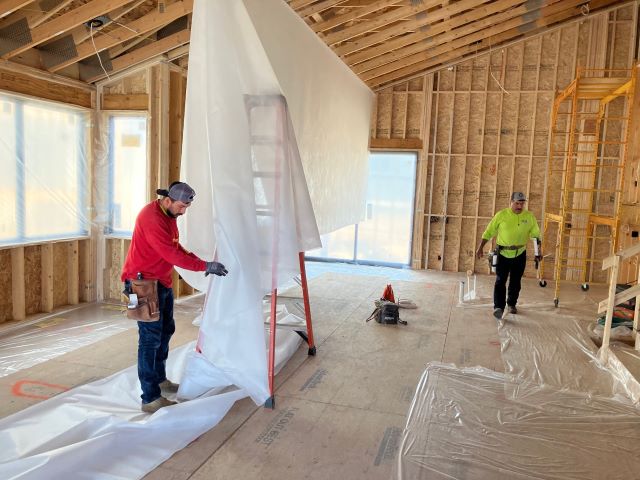

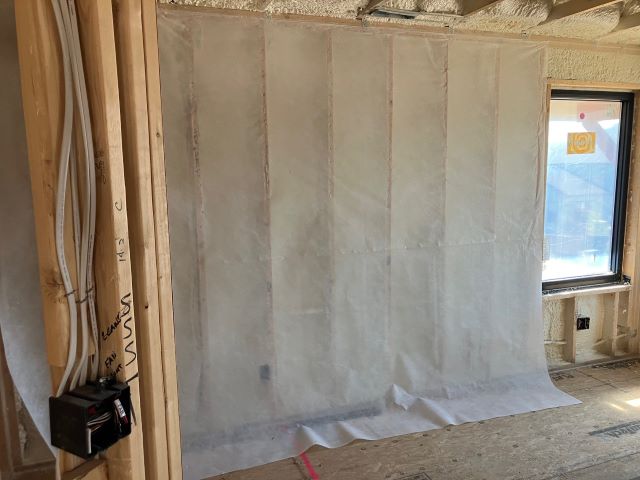

Hanging netting for blown-in insulation
-

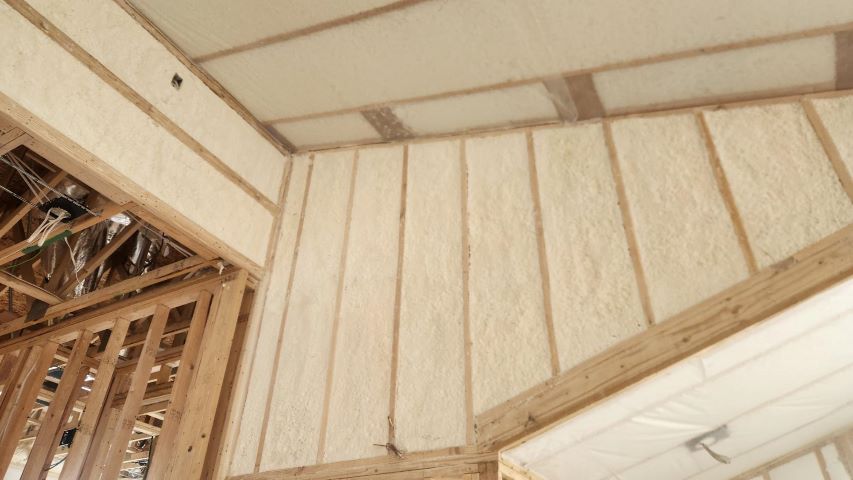

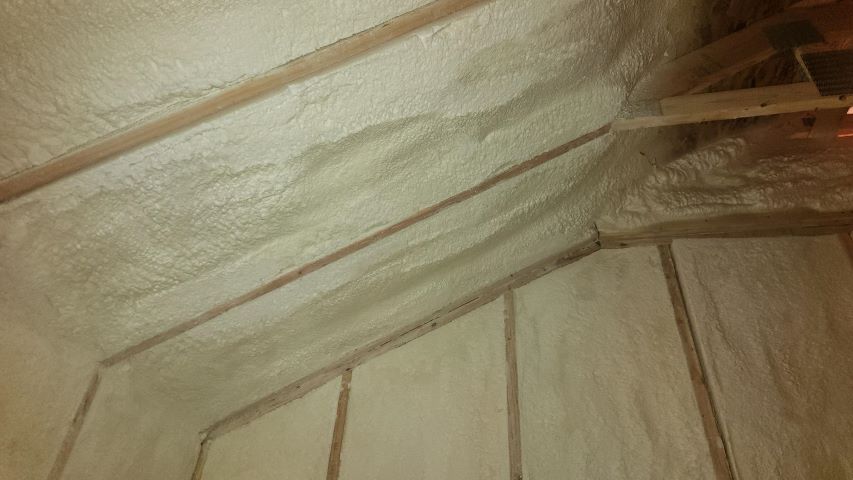

Attic walls are insulated with spray foam
-

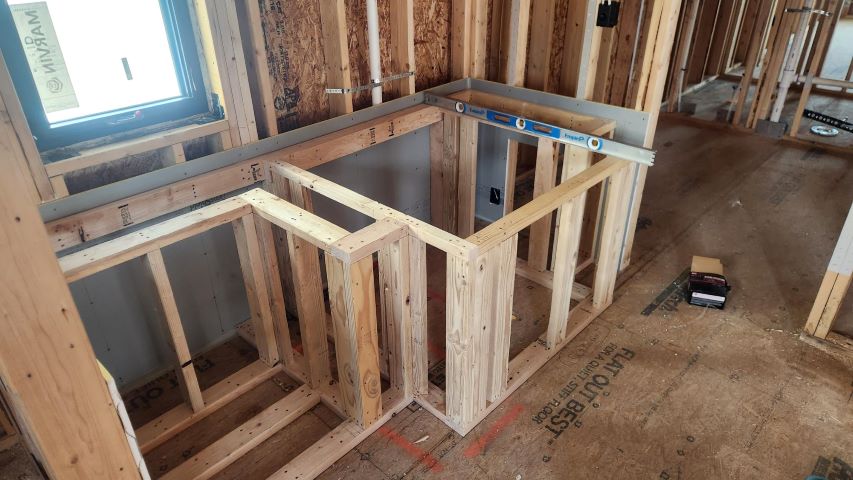

Closed cell foam in walls
-

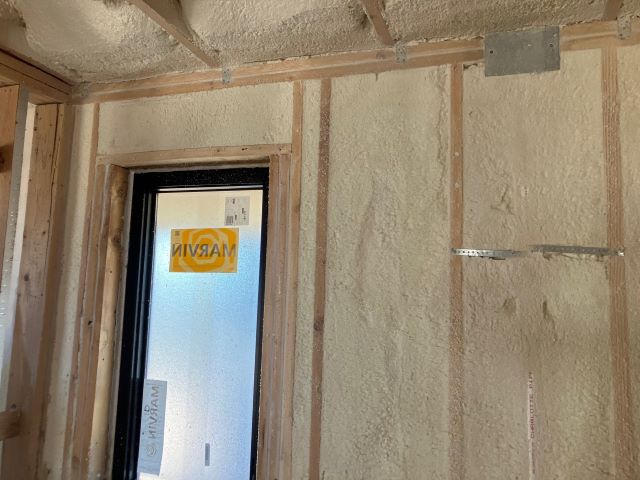

Closed cell foam in primary bath ceiling and walls
-

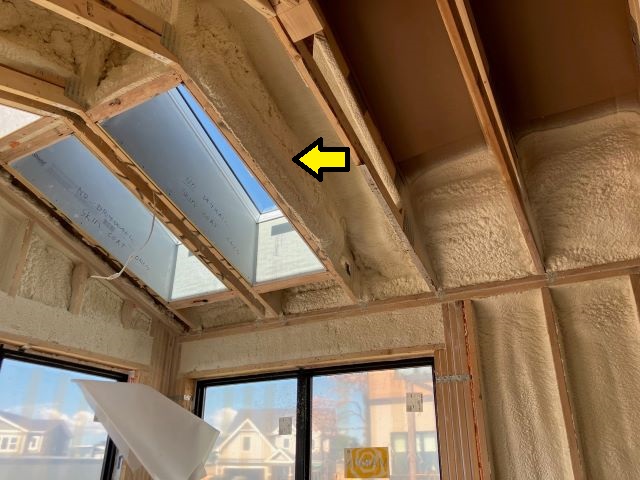

Four inches of closed cell foam around skylights and solarium framing
-

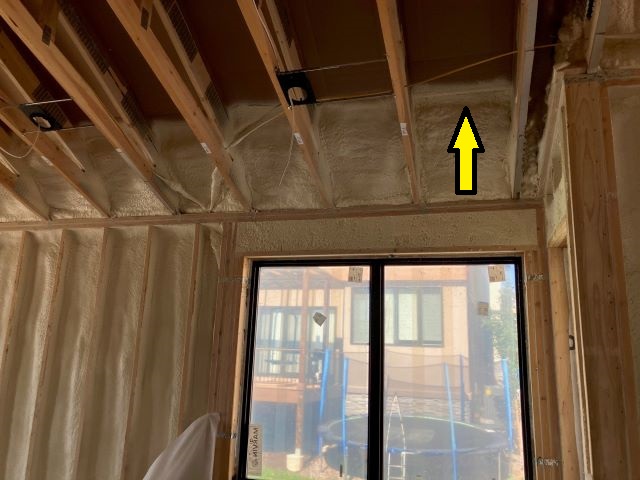

Seven inches of closed cell foam up two feet on exterior wall
-

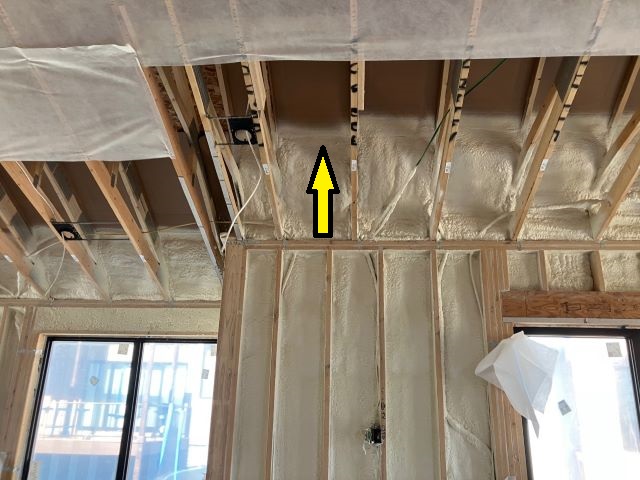

Seven inches of closed cell foam up two feet on exterior wall
-

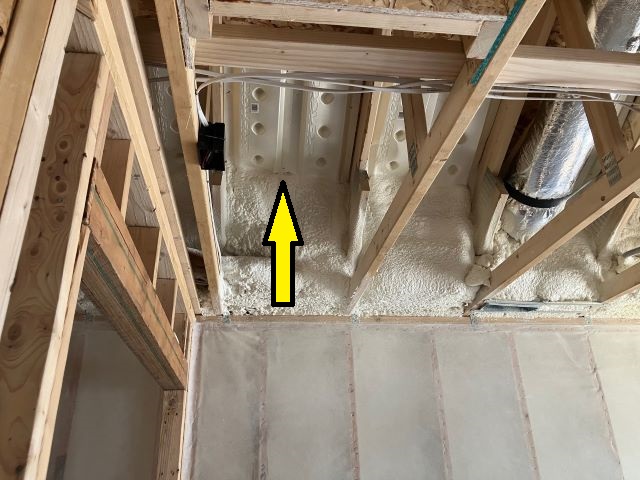

Seven inches of closed cell foam up two feet of the exterior walls upper attic to baffles
-

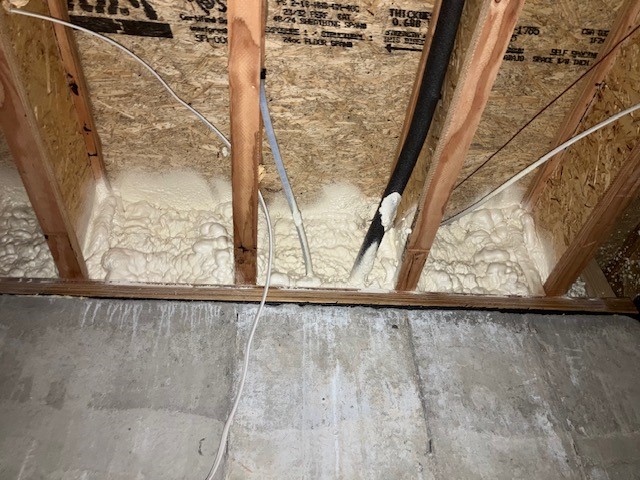

Closed cell foam at ledger box sill adjacent to garage wall
-

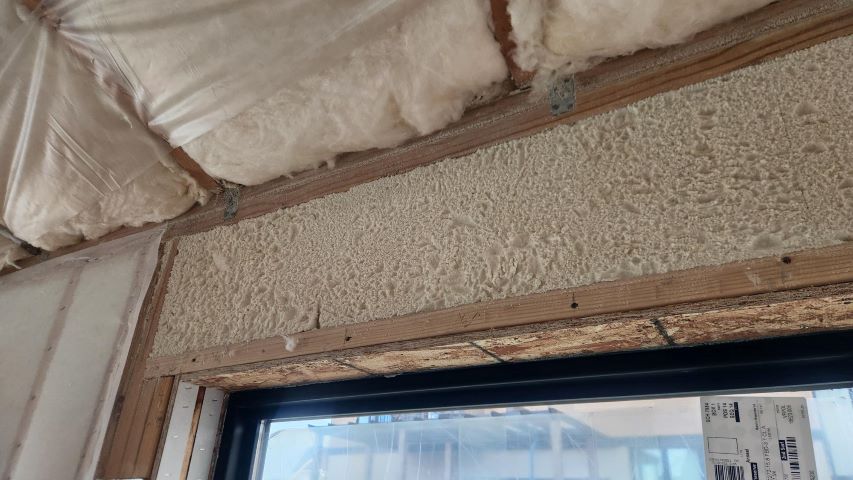

Headers are insulated with closed cell foam
-

Closed cell foam in door header
-

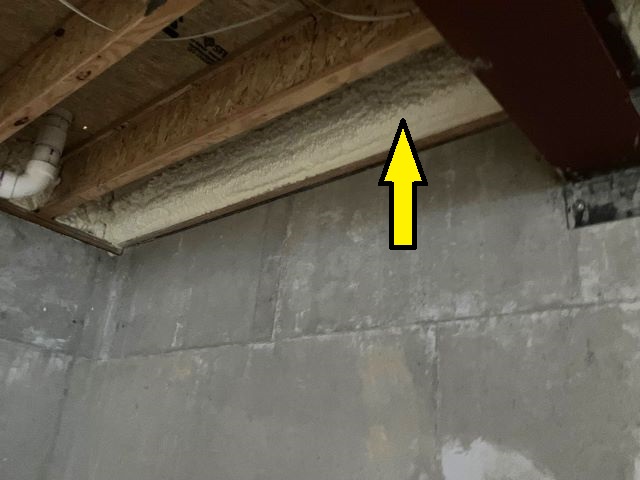

Closed cell foam in basement ledger
-

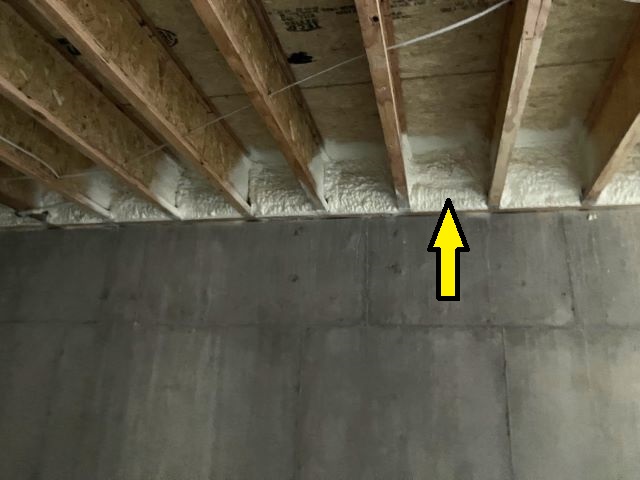

Closed cell foam in basement box sills
-

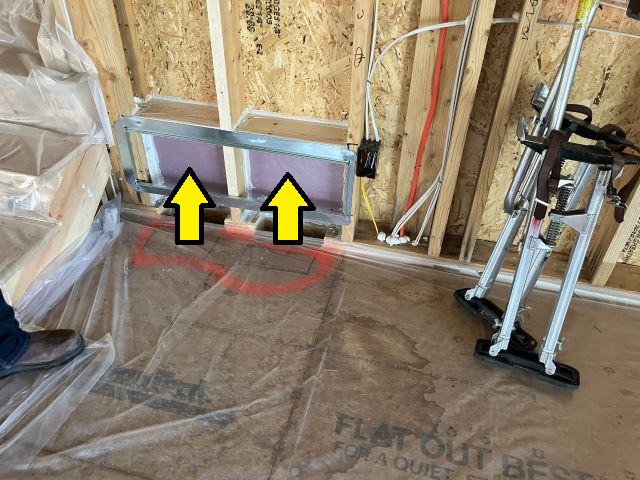

Insulation at return air inlet in family room
-

Windows reveals are framed and shimmed accuratelyÂ
-

Plumbing in basement for future sink
-

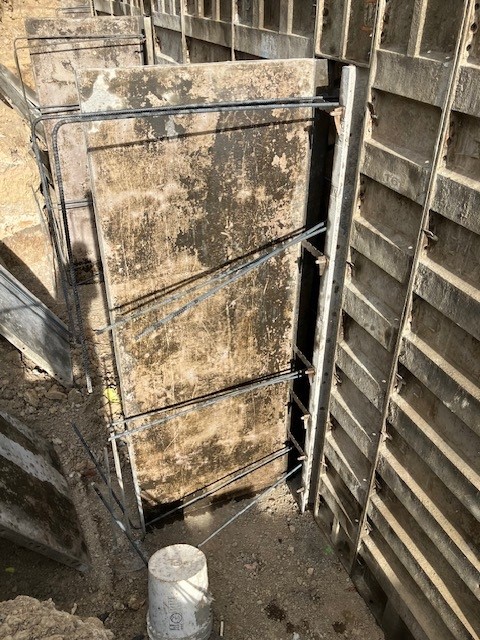

Steel beam pocket is groutedÂ
-

Beam pocket blocked for groutingÂ
-

Vent fan for lower basement floor
-

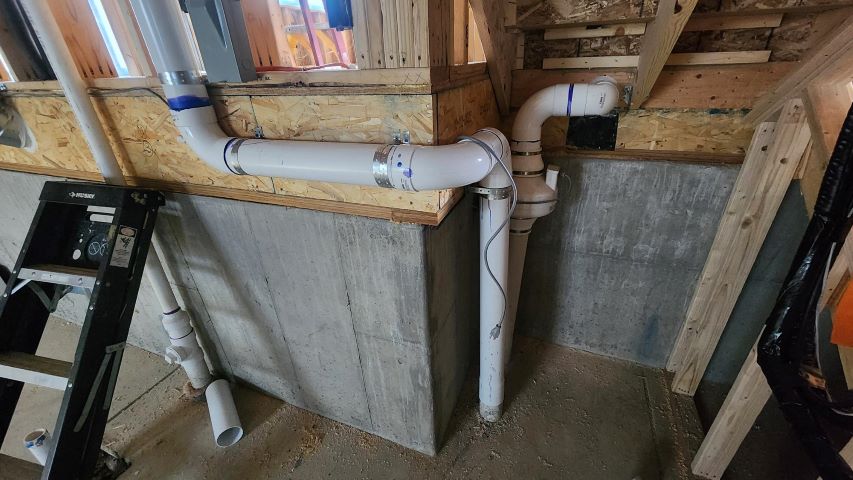

Crawlspace venting intake pipe
-

Crawlspace venting piping
-

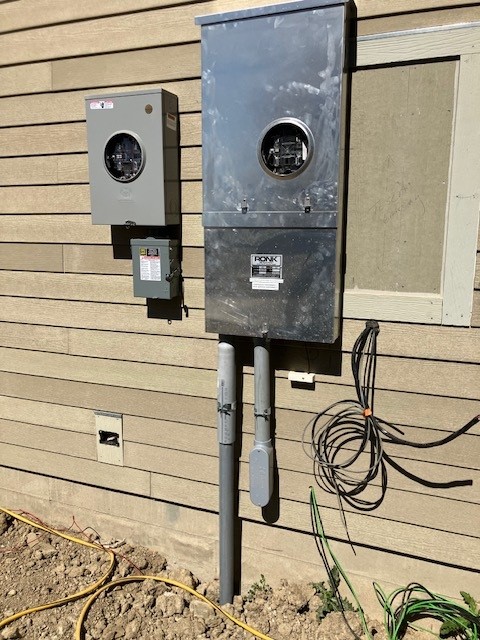

Service lateral connected ready for meter
-

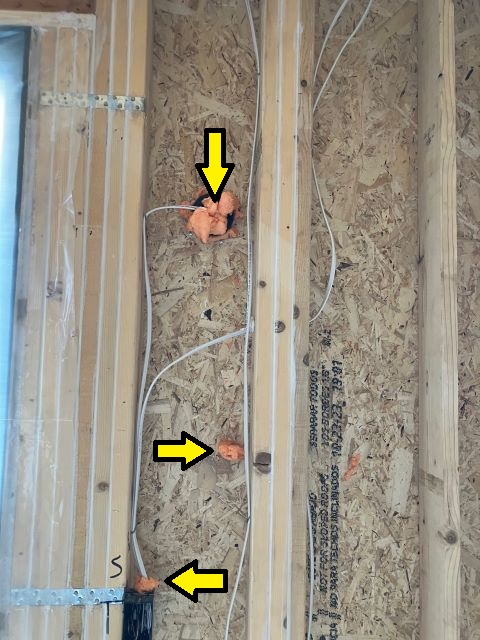

Fire stop foam at exterior outlets
-

Fire stop foam at exterior outlets
-

Tub protected with three-quarter inch plywood lid
-

Soaking tub is installed in the deck
-

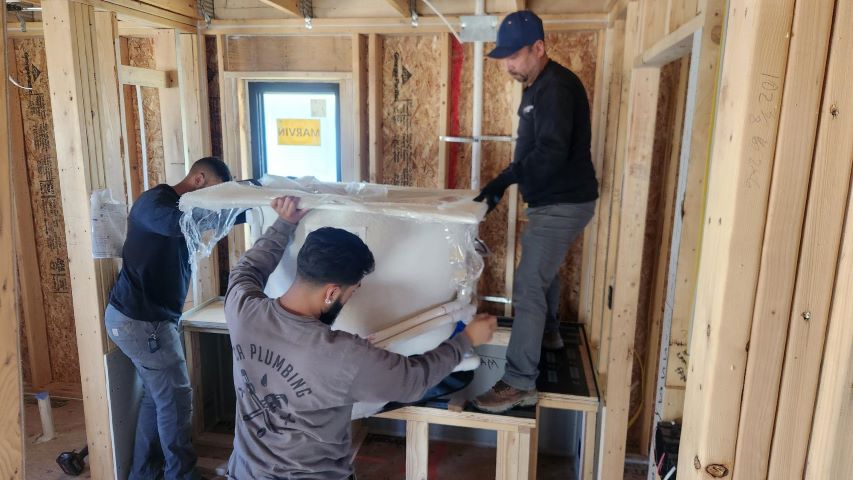

Soaking tub being installedÂ
-

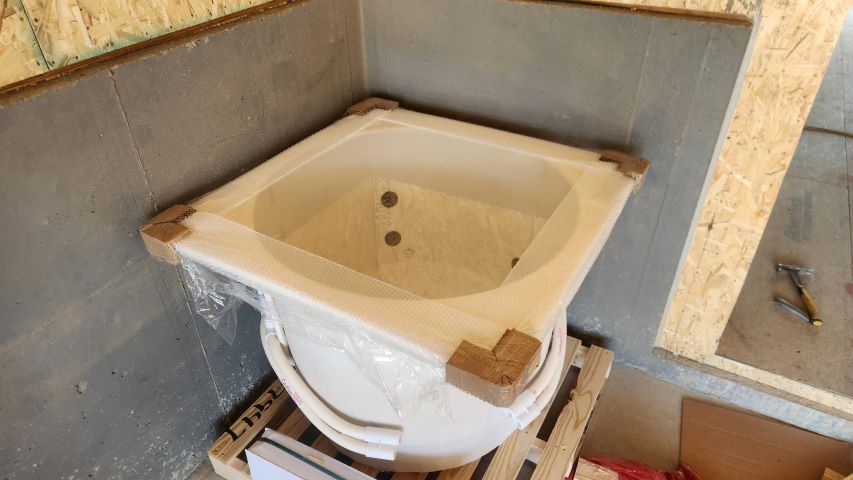

Soaking tub is delivered
-

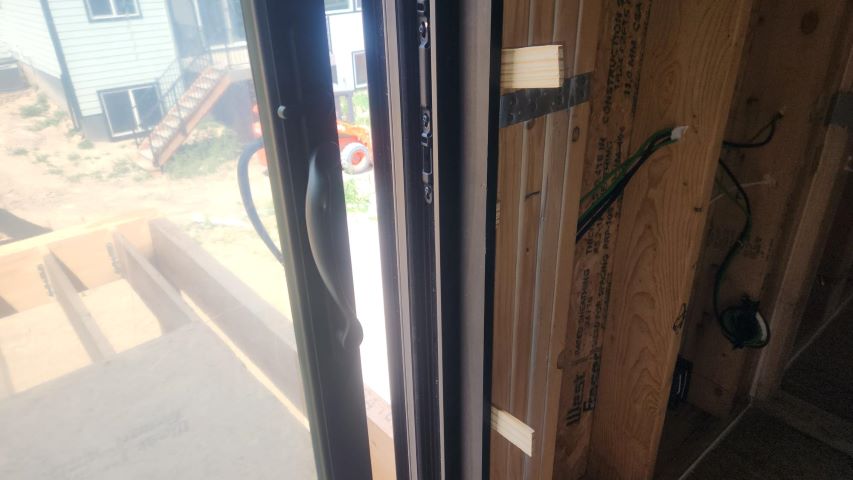

Hardware & handles are installed on sliding doors
-

Sliding doors are shimmed
-

Floor heat registers are protected from dust
-

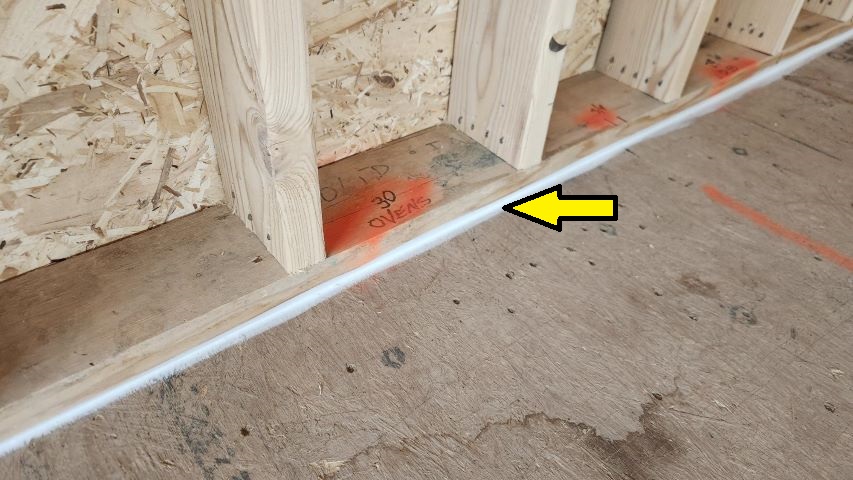

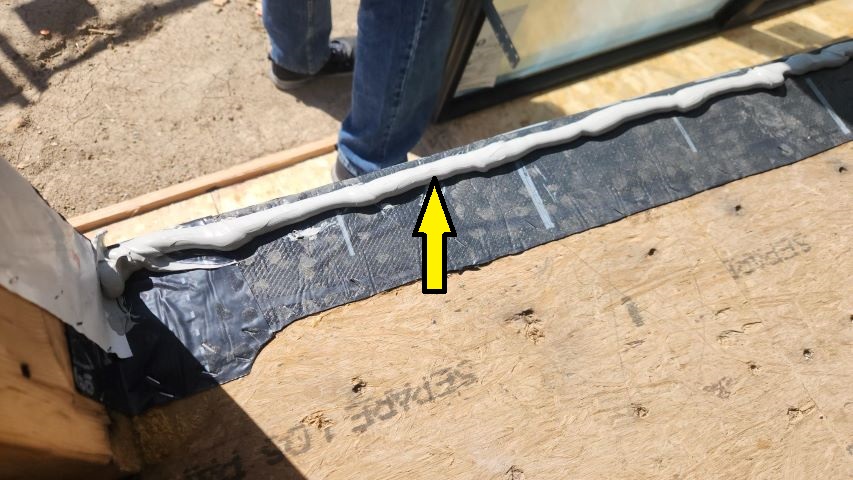

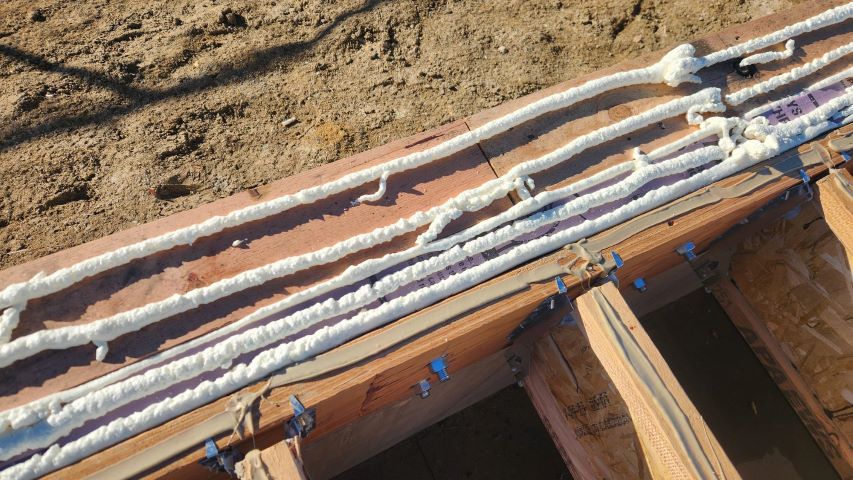

Bottom plates are caulked for maximum air infiltration control
-

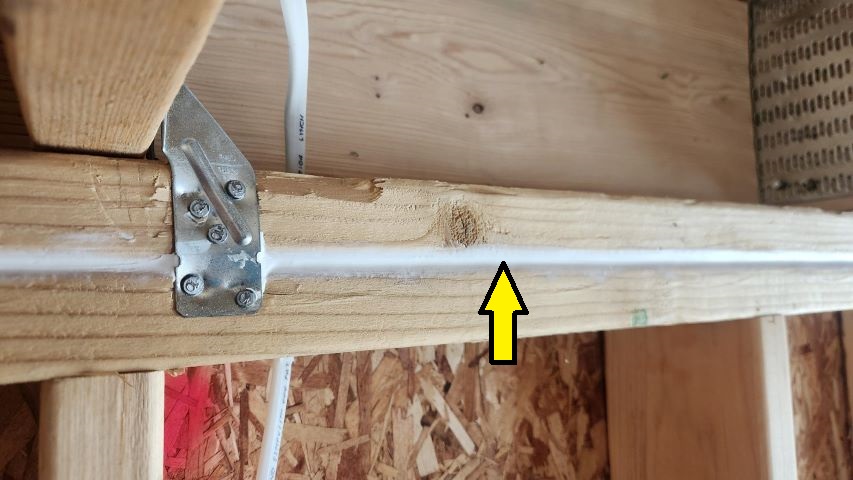

Top plates are caulked
-

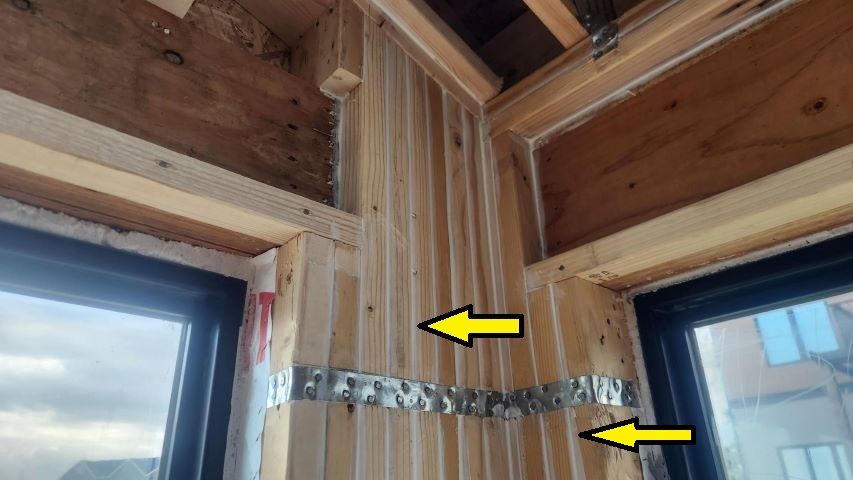

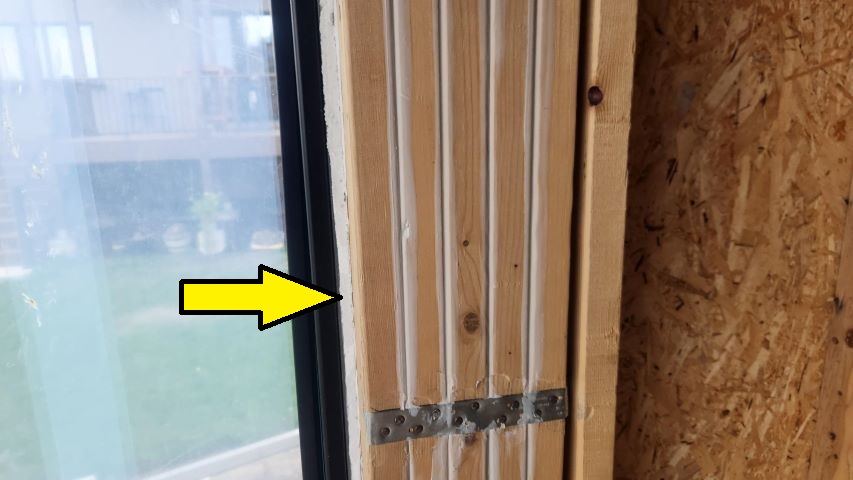

Framing is caulked for higher performance tight envelopeÂ
-

Framing multipacks are caulked for maximum air infiltration control
-

Hvac ducts are tested and sealedÂ
-

Foam firestopping
-

Wire penetrations are foamed for firestop
-

Wiring above breaker boxes
-

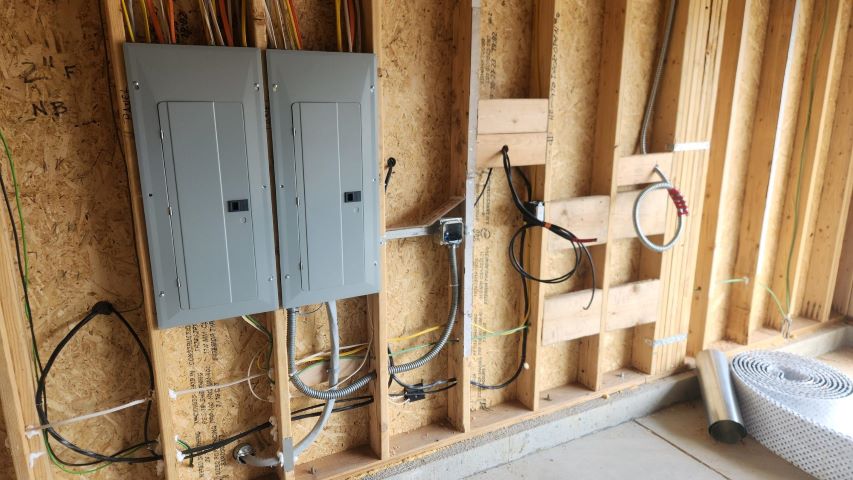

Breaker boxes wall in the garage
-

Electric trench connection in progress
-

Electric meter housing outside of garage
-

400 amp panel being installed
-

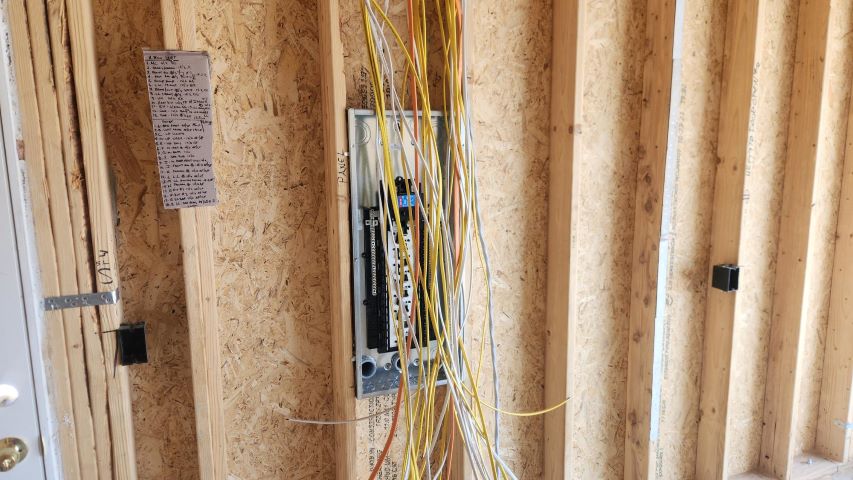

Breaker box in garageÂ
-

Electricians setting up the service panel
-

Wiring in kitchenÂ
-

TV wiring in great room
-

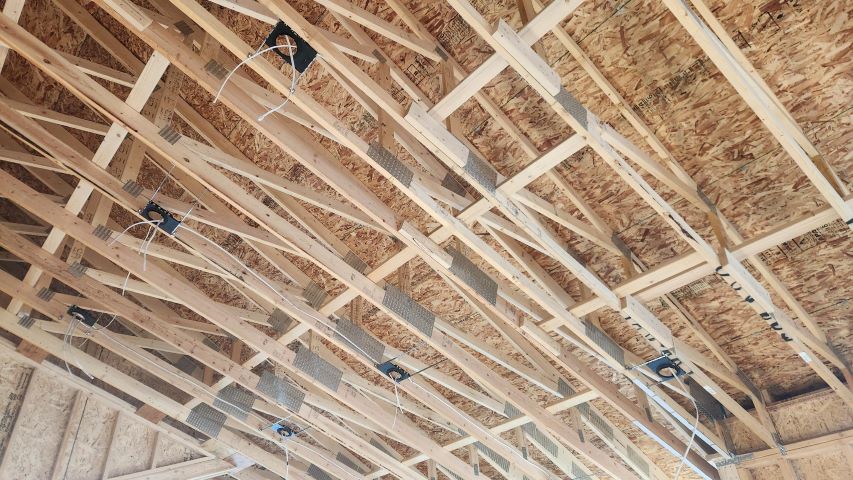

Wiring for great room lights
-

Blocks in basement to hold electric outlets past insulation blankets
-

Wall to receive electrical panels in basement
-

Walls are checked with straight edge
-

Studs are shimmed before drywall for perfect wall
-

Pavel is shaving studs with planer for straight walls
-

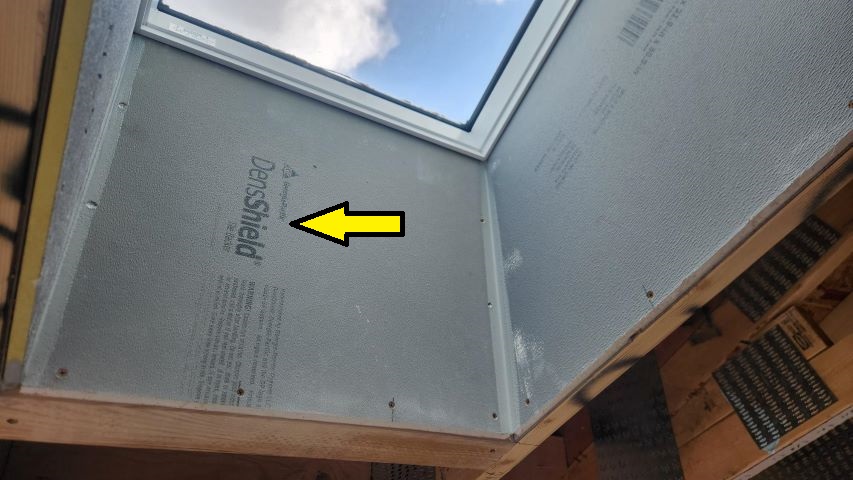

DenShield used for skylights frameÂ
-

Tub deck protected with Vycor
-

Master tub deck frame
-

DenShield behind tub deck was sealed
-

DenShield installed behind tub deck to hold insulationÂ
-

Caulking in progress to tighten up stud spacing behind tub deck
-

Radon air barrier in upper crawlspace
-

Radon air barrier in upper crawlspace
-

Heating equipment installed in basement Â
-

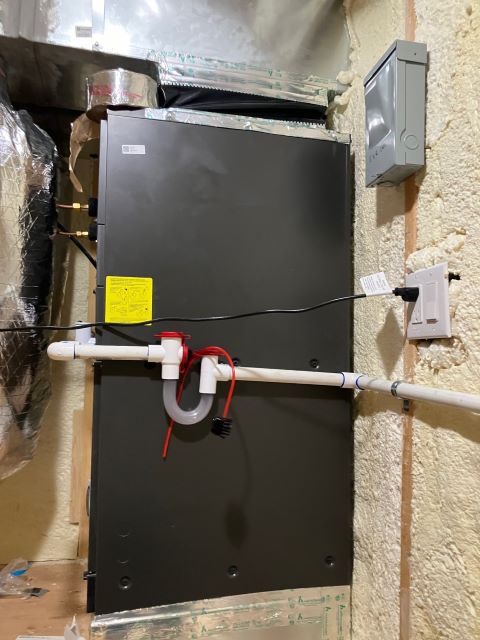

Heat pump air handler in basementÂ
-

Basement air handler and duct work
-

Air handler in insulated mechanical room
-

Front of house with roof finishedÂ
-

Front of house with siding finished
-

Siding almost complete
-

Vertical siding on west wall
-

Board and batt siding on gables
-

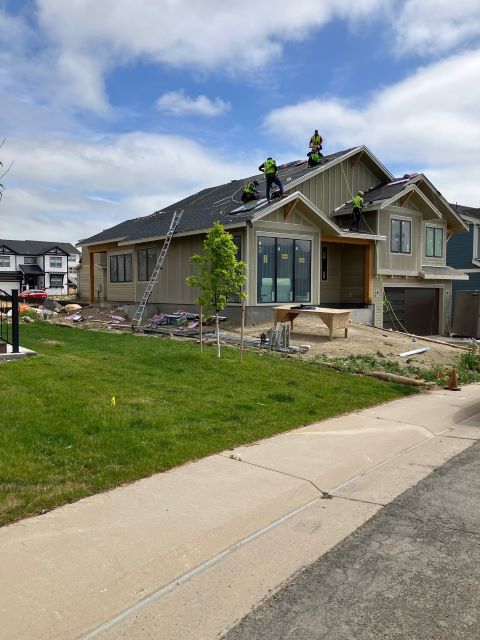

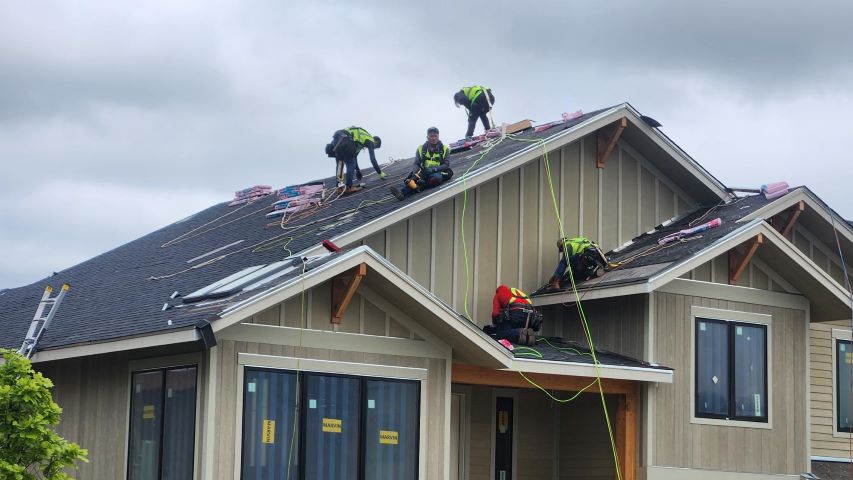

Roofers finishing roofing installationÂ
-

Roofing in progress
-

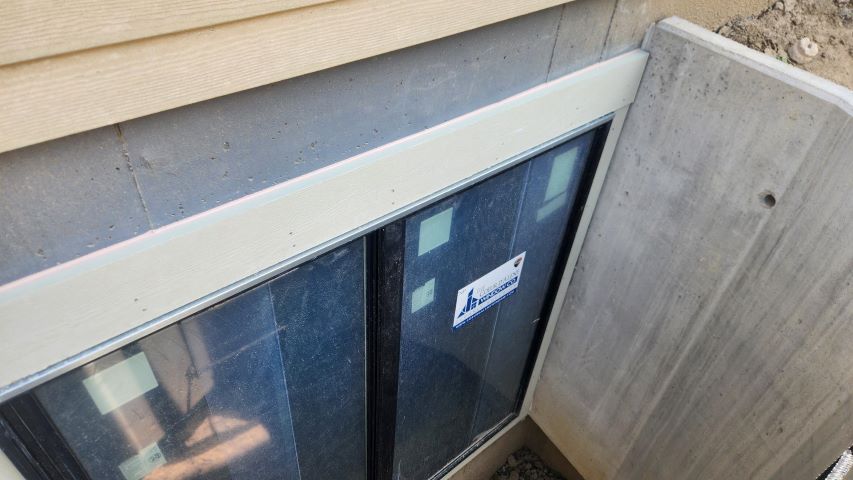

Basement windows trimmed
-

Hot water lines are insulatedÂ
-

Shower valves are installed
-

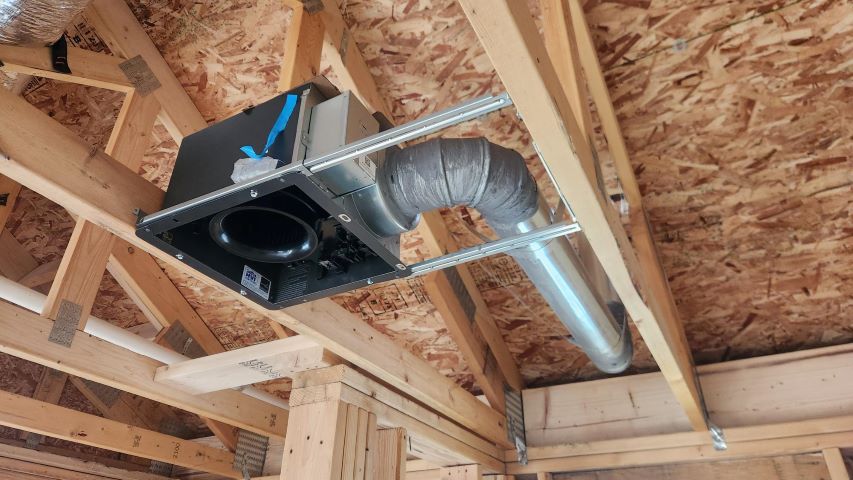

Master bathroom fan
-

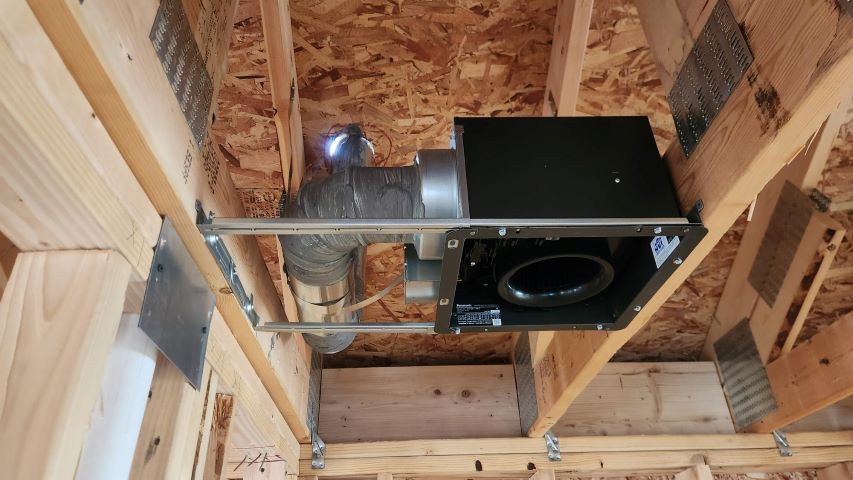

Upper bath fan installed
-

Ceiling cold air return
-

Ceiling heat supplyÂ
-

Plumbing, radon and duct below pantry
-

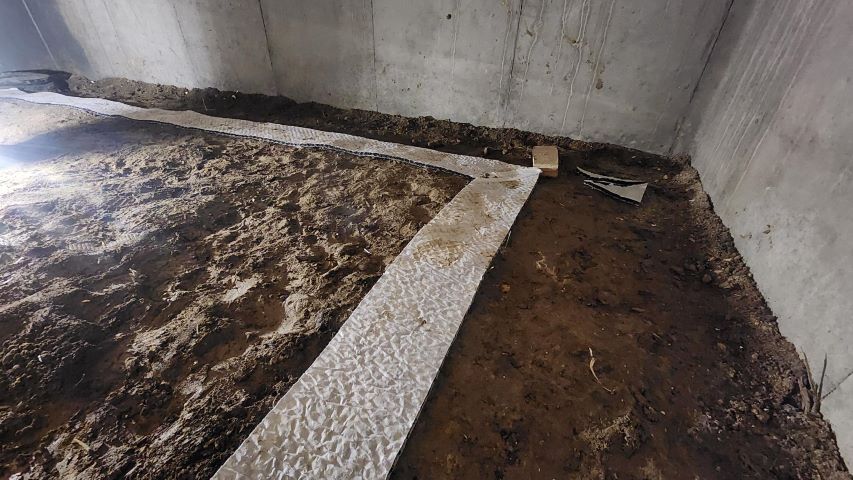

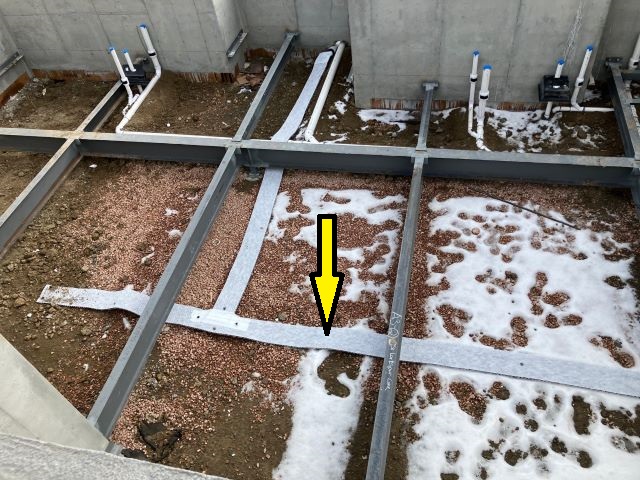

Radon mat system in crawlspace before plastic cover is installed
-

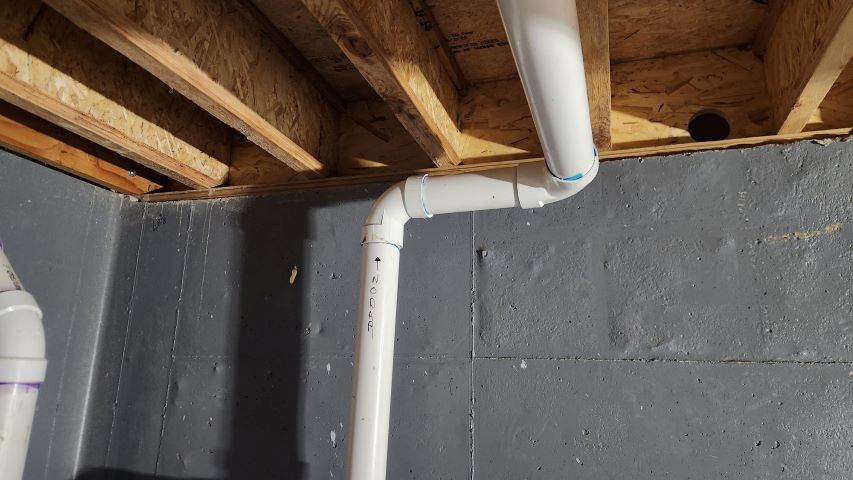

Radon pipe coming from studio crawlspace
-

Radon system below studio
-

Plumbing drain pipes in crawlspace below studio bathroomÂ
-

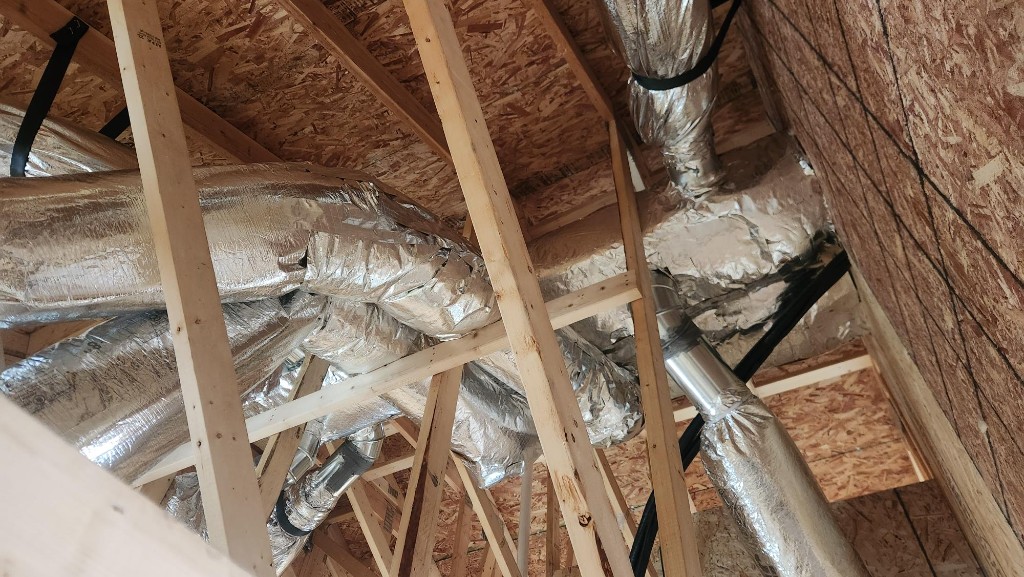

Attic ducts and main trunks are insulatedÂ
-

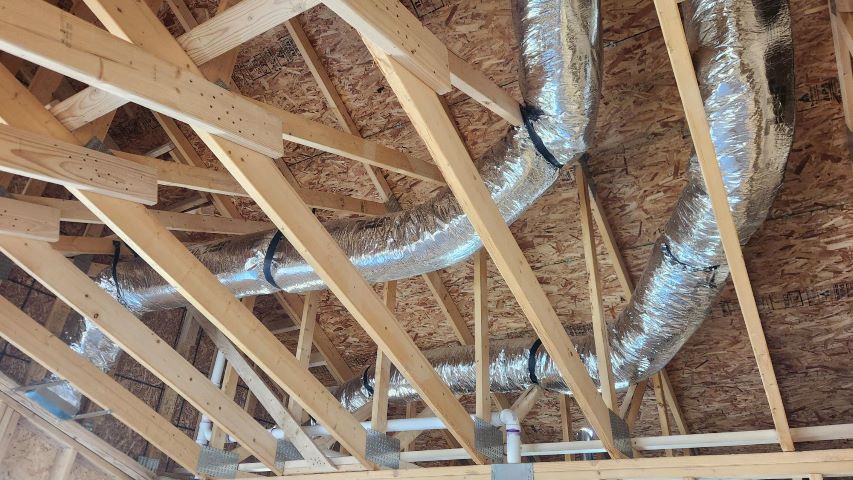

Insulated ducts above master suiteÂ
-

Heat duct below studioÂ
-

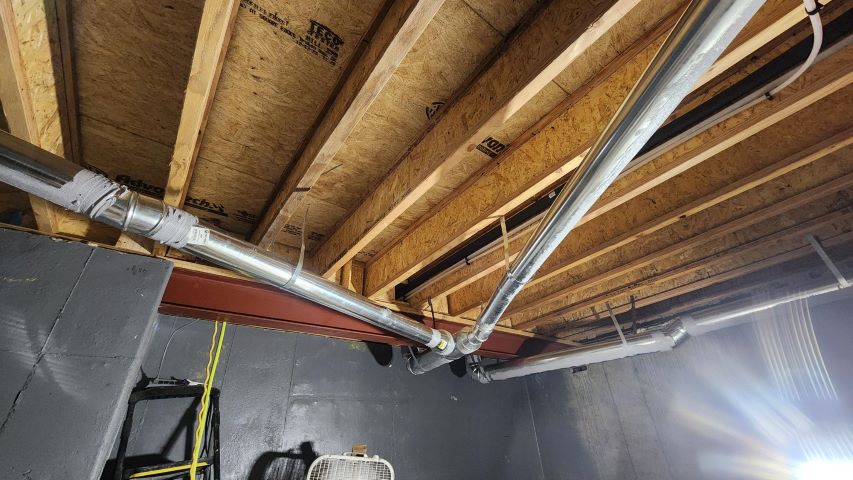

Sealed ducts in crawlspace below studio
-

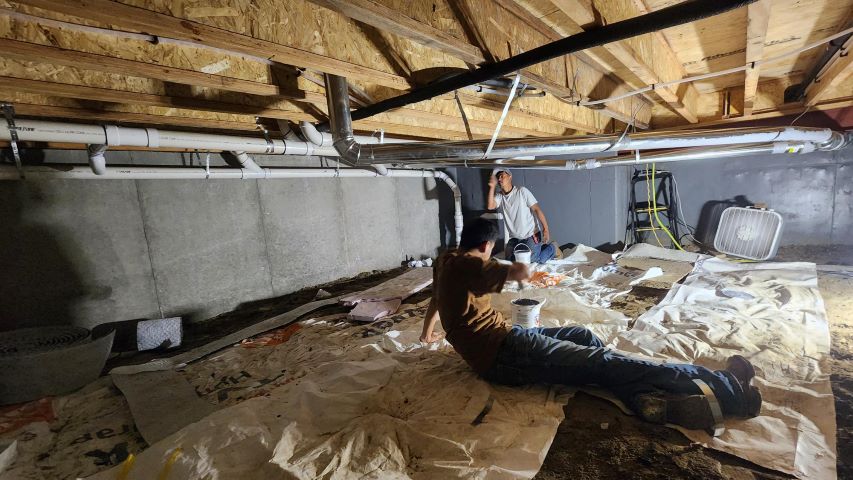

HVAC installers sealing ducts
-

Foam at window gap for air infiltration control
-

Window gaps are filled with foam for air infiltration control
-

Rear of the house with siding finished
-

Siding at entryÂ
-

Siding completed on east side
-

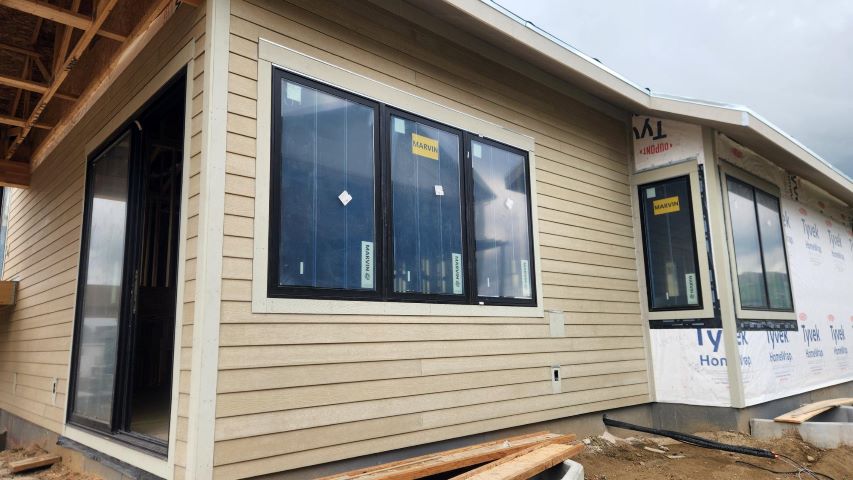

Horizontal siding on west kitchen wall
-

South gables in progress
-

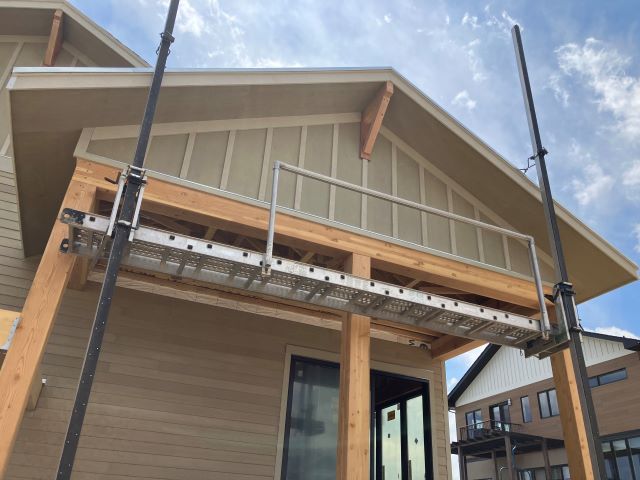

Rear porch gable board and batten completed
-

Rear upper gable with board and batten
-

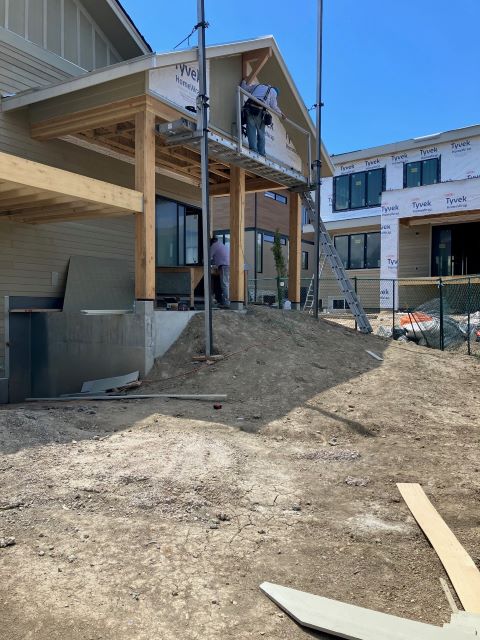

Siding in progress on rear porch gable
-

Board and batten on solarium gable
-

Garage door installedÂ
-

Corbels below garage cantileverÂ
-

Solarium skylights from inside
-

Solarium skylights installed
-

Skylight flashed and installed
-

Sealed HVAC ducts for maximum airflow from heat pump
-

Sealing duct work for maximum airflow from heat pump
-

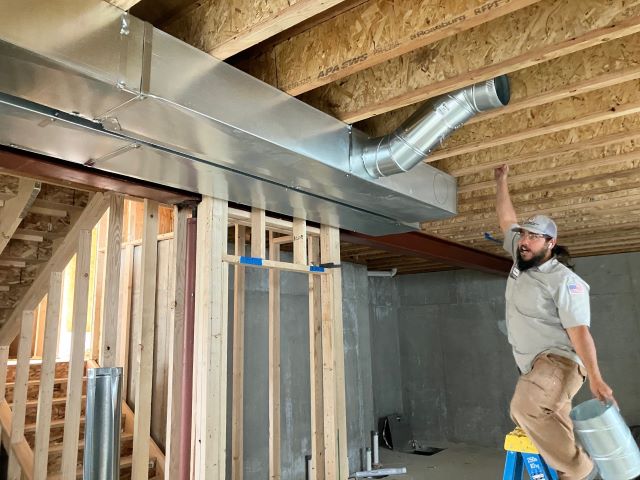

Very nice workmanship installing duct work for heat pump
-

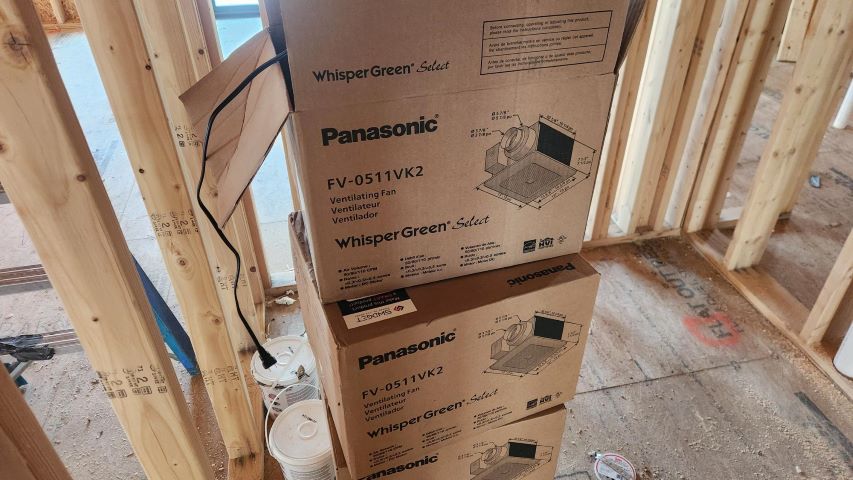

We use quiet Panasonic WhisperGreen Select fansÂ
-

Laundry room plumbingÂ
-

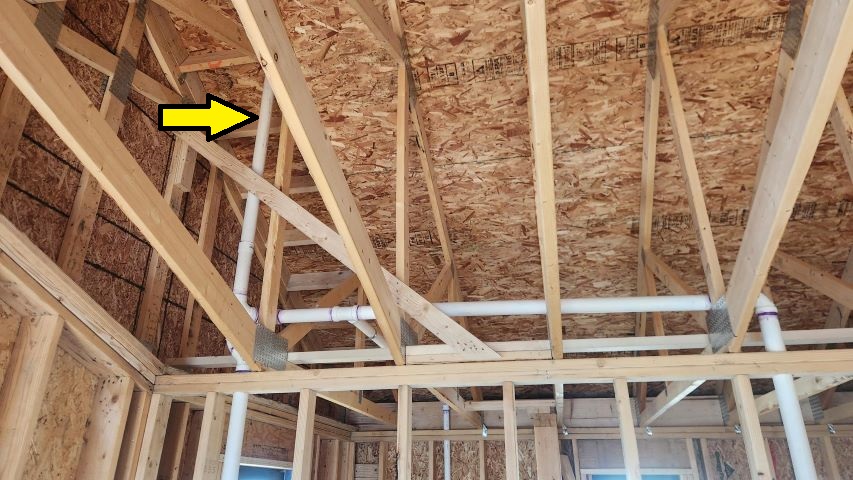

Plumbing vents
-

HVAC material stored in great room
-

Best pex water lines and compression fittings
-

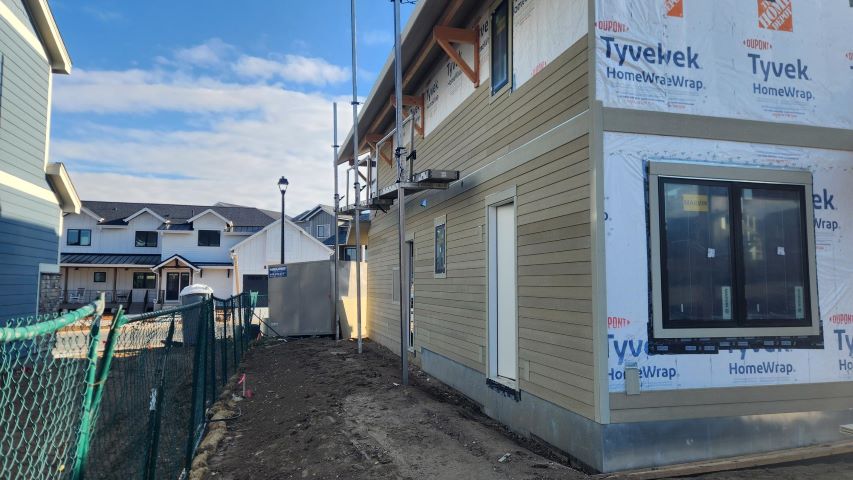

Siding being installedÂ
-

Installing siding on east wall
-

We remove brick mold before installing trim
-

Outlet panels with flashing
-

Panels for electric outlets and disconnects
-

Window and trim flashings
-

Window trim
-

Outlet blocks line up with siding lines
-

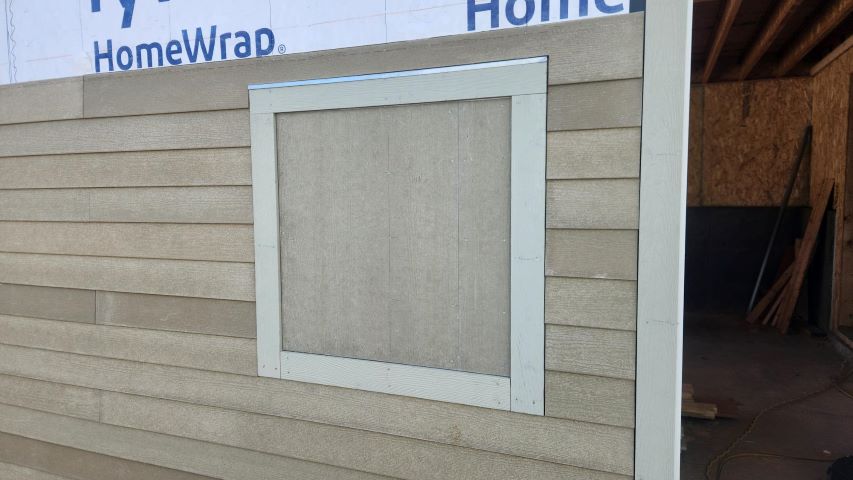

Special siding placement for electric panel
-

Window wells sealed against foundationÂ
-

Vertical framing with weather barrier sealed to foundation in all similar locations
-

Deck ledger bolted & joist hangers are attached with screws for more secure fastening
-

Garage man door set in sealant
-

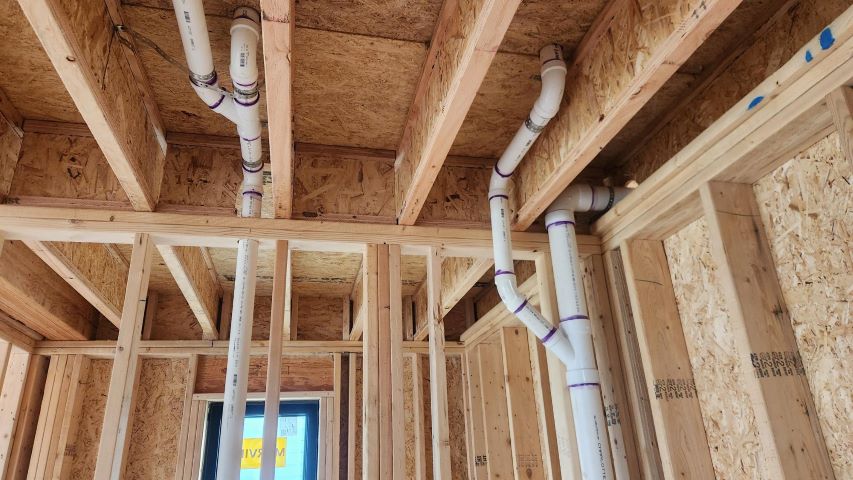

Plumbing drain lines in pantry
-

Studio laundry drain and vent line plumbing
-

East soffit with beam and corbels
-

Deck perimeter built with solid glulam beams for extra stability
-

Deck beam is bolted to column for extra strength
-

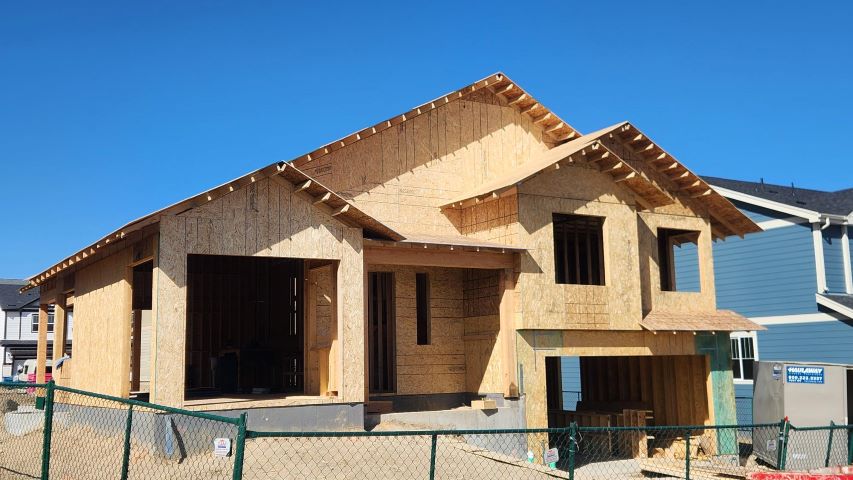

Front of house
-

Roof shingles delivered
-

Upper bathroom plumbing
-

East soffit beam and supporting corbels
-

Master bedroom deck safety rail in place
-

Deck glulam beams and post
-

Front of house with exterior weather barrier
-

Basement window in window well with Vycor flashingÂ
-

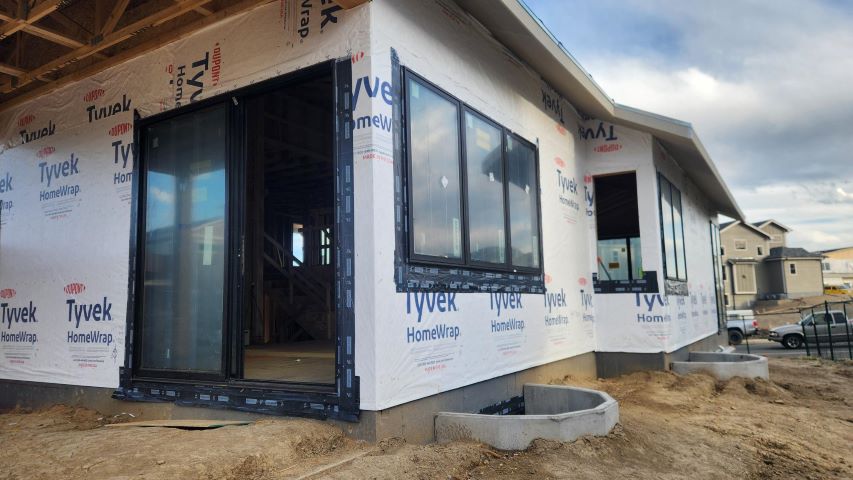

Back patio large sliding door
-

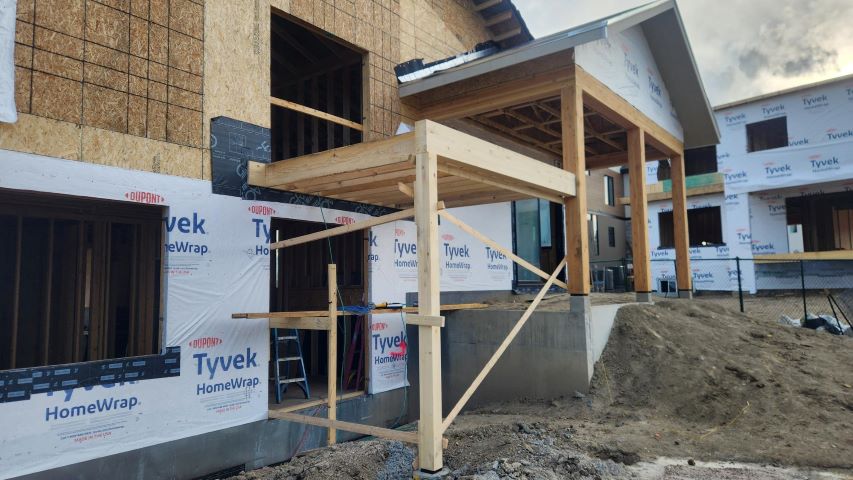

Deck is being built with glulam posts and beams
-

Plumbing drain lines in garage ceiling
-

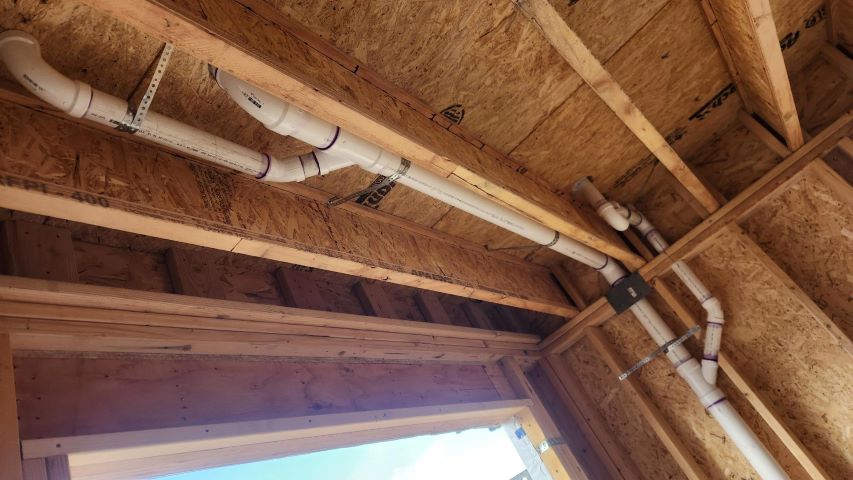

Plumbing drain lines in studio ceiling
-

Exterior trim and windows
-

East soffit corbels bolted from backside
-

East soffit beam and corbel
-

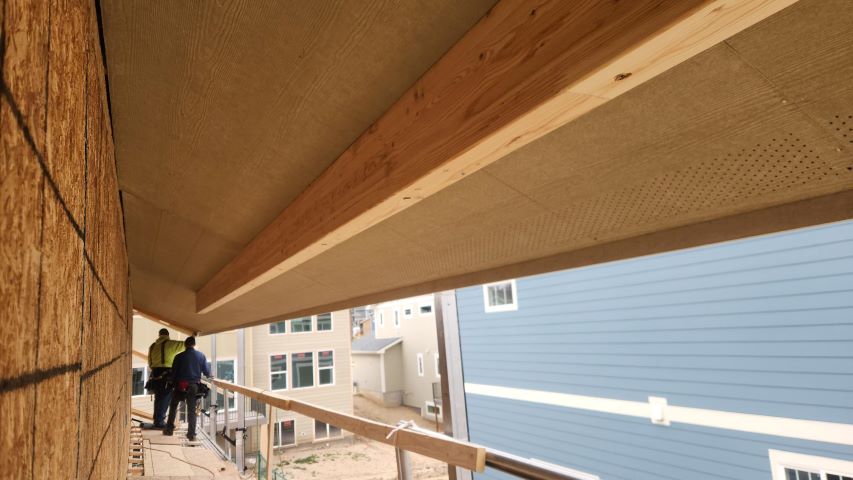

East soffit glulam beam in place ready for corbel attachments
-

East soffit beam was bolted to each truss
-

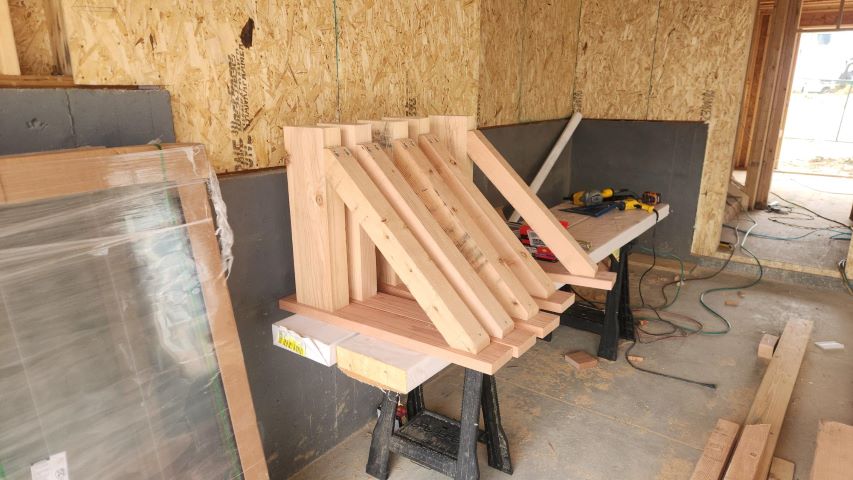

East soffit corbels are prebuilt on table
-

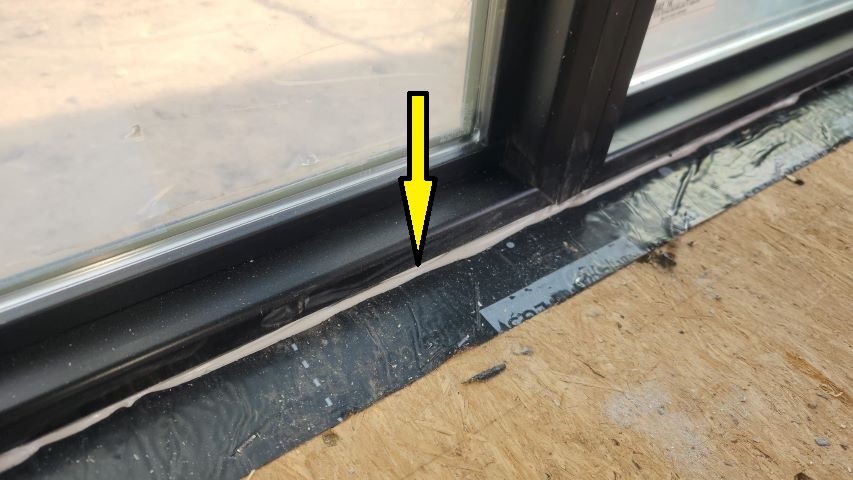

Solarium window set in sealantÂ
-

Solarium window to be set in sealant for maximum air infiltration control
-

Installing windows
-

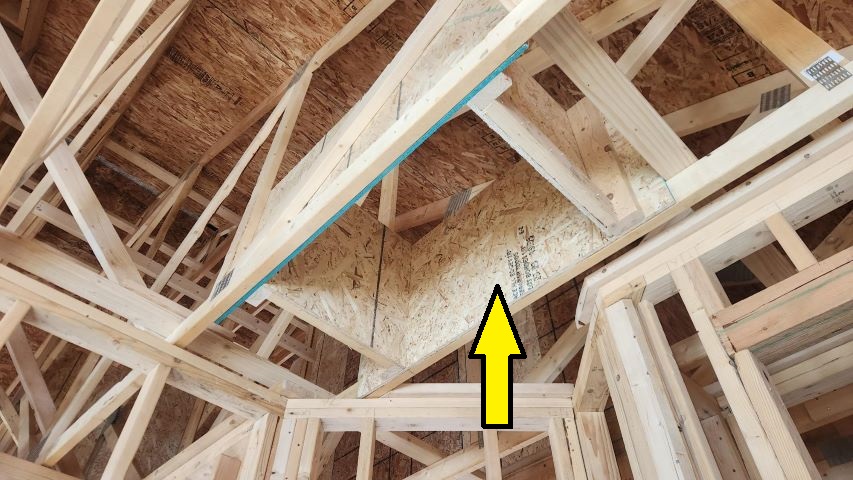

Attic access with tall insulation barrier for cleaner access
-

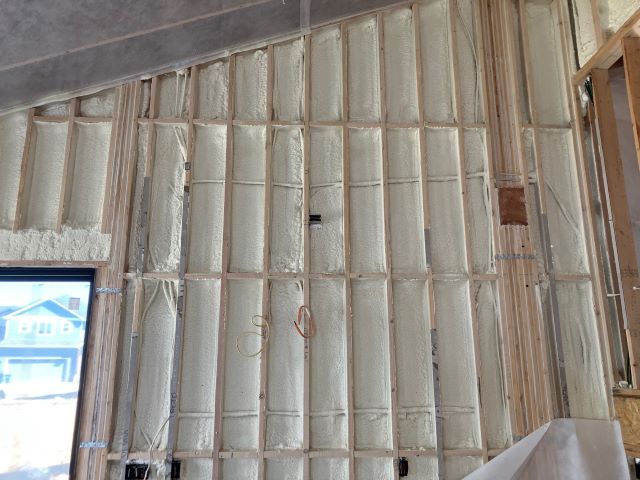

Attic mechanical room ceiling and walls insulated with closed cell foam
-

Attic mechanical room walls insulated with closed cell foam
-

Basement steel beam shims are welded
-

Steel column welded to steel beam
-

Freshly placed caisson protected from rain
-

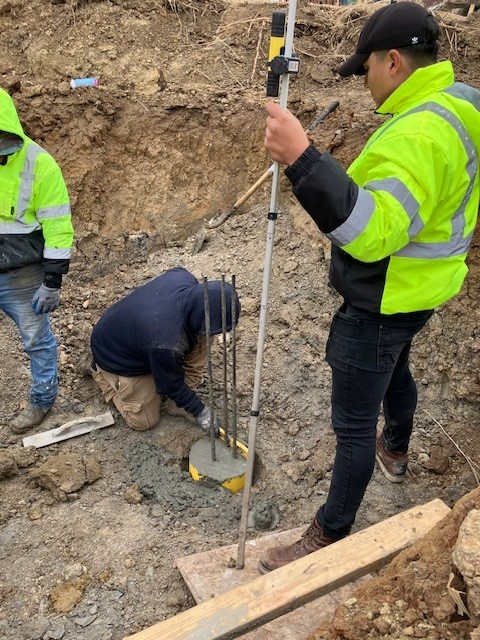

Concrete being placed in caisson hole
-

Caisson for deck has dried, steel in place
-

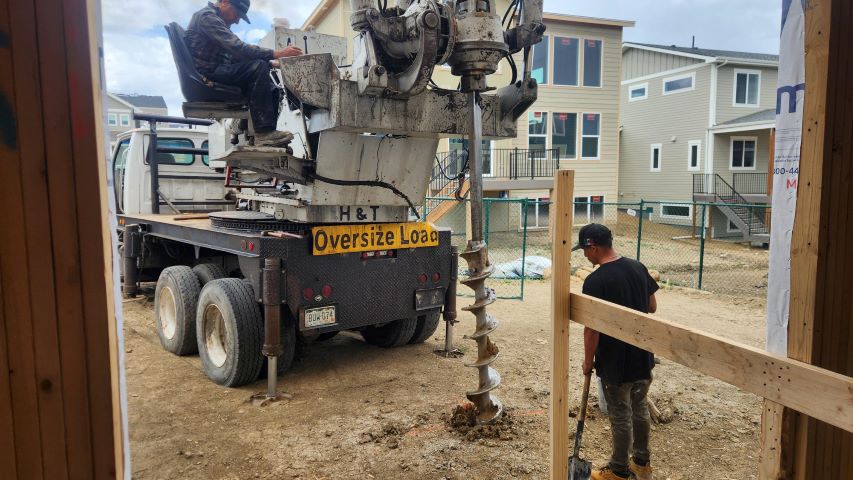

Caisson drill for deck post
-

Caisson staked for drilling to support the upper deck
-

Post straps on side of window openings
-

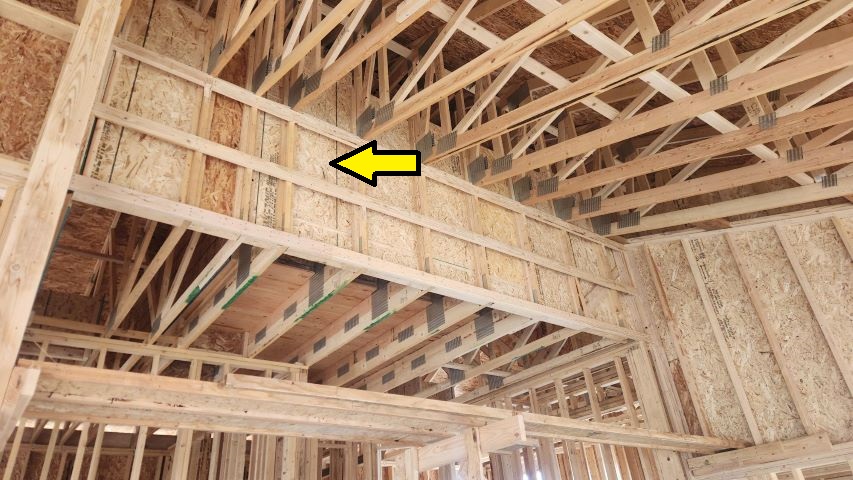

Attic knee wall extended to 5-inch depth to receive insulationÂ
-

Straps at top of posts for extra strength and stability
-

Fascias at front of house
-

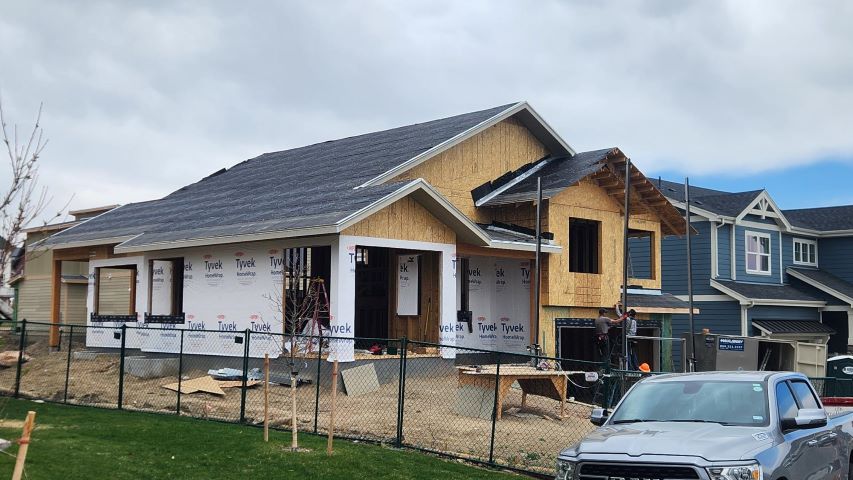

Roof covered with high-quality underlayment-house is dried in
-

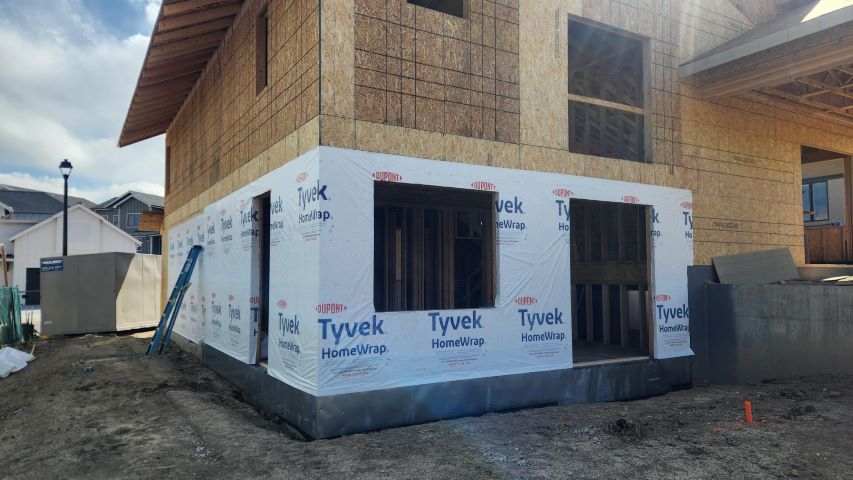

Starting house wrap
-

Ice & water shield protected with metal flashing
-

Backings for garage door installation
-

Garage door opening trimmed over Vycor flashing
-

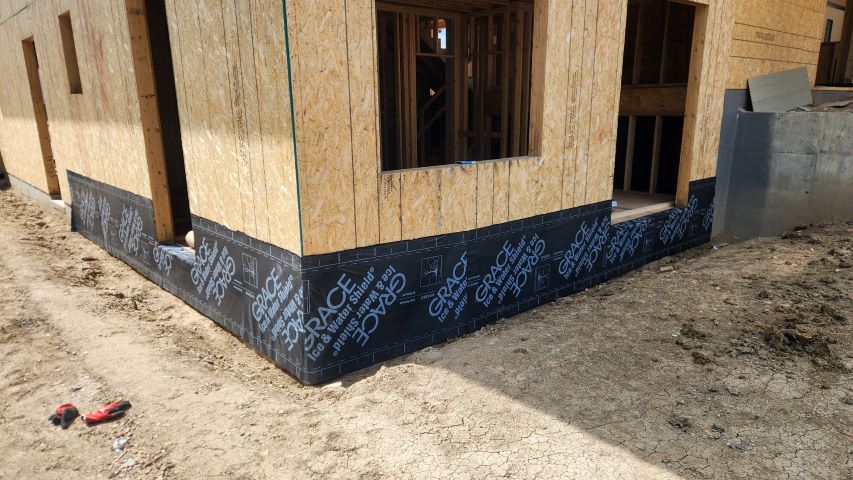

Back of house protected with ice & water shield for future additional moisture control
-

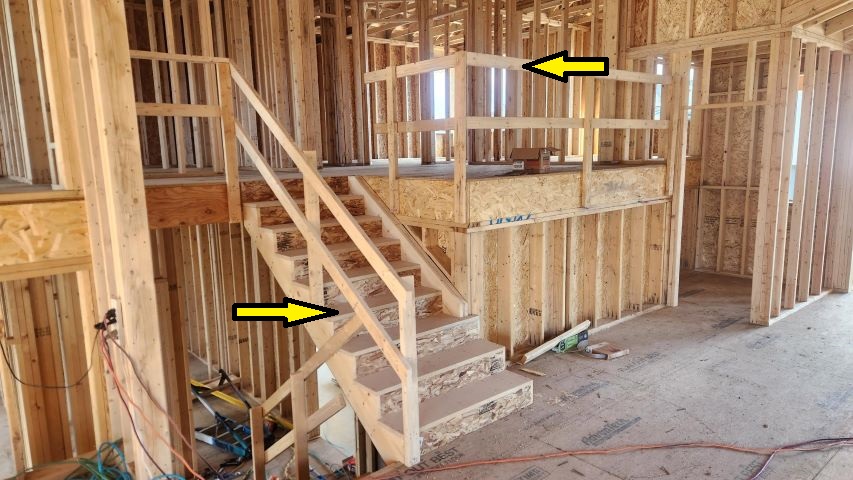

Temp construction safety railings
-

Upper stairs with LVL beams reinforcement for maximum stiffness
-

Basement stairs and walls
-

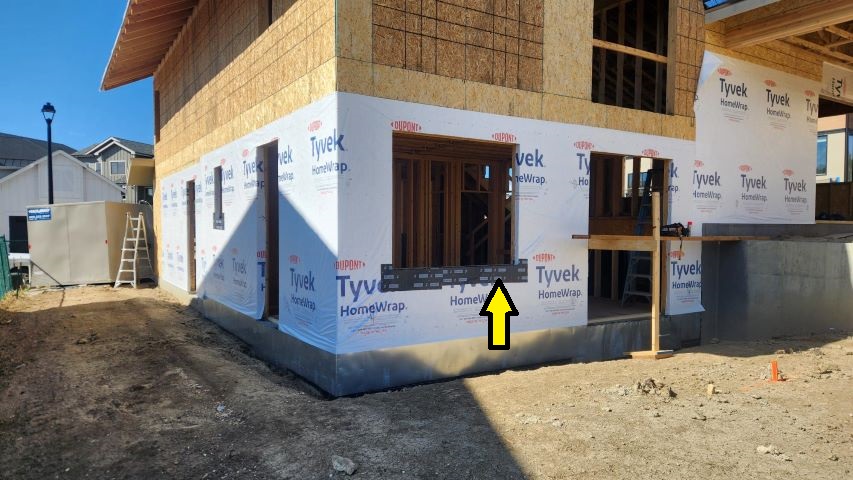

Window Vycor flashing before windows installation
-

Flashing for extra moisture protection
-

Tyvek & flashing for extra moisture protection
-

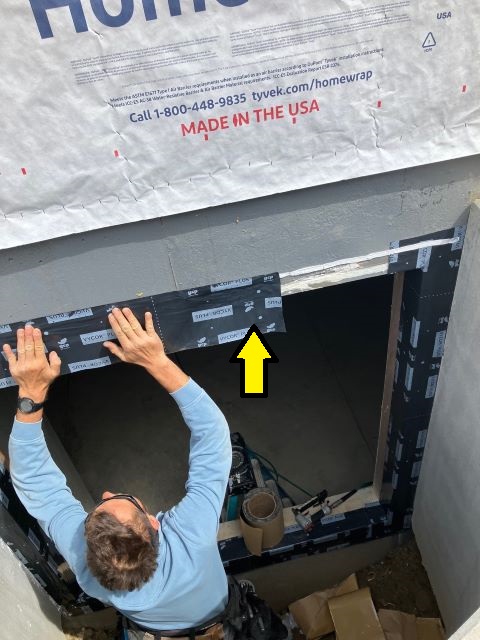

Vycor installation for basement windows for additional protection
-

Fascia & soffit insulation in progress
-

Another snow storm. Fascia soffit installation started
-

Master bedroom rake attic wall
-

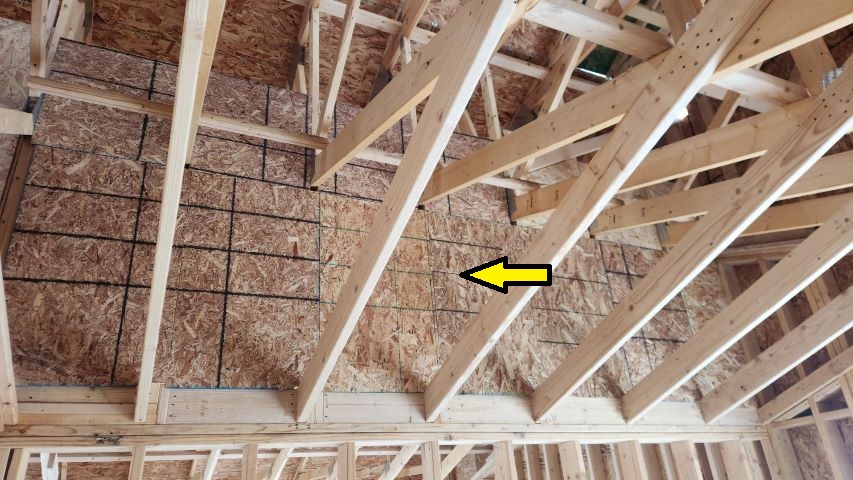

Attic knee wall above master bedroomÂ
-

Attic walls of mechanical room
-

Attic walls are sheathed to receive insulationÂ
-

Attic knee walls between high and low ceilings
-

Stairs are protected from rain
-

Basement stairs installedÂ
-

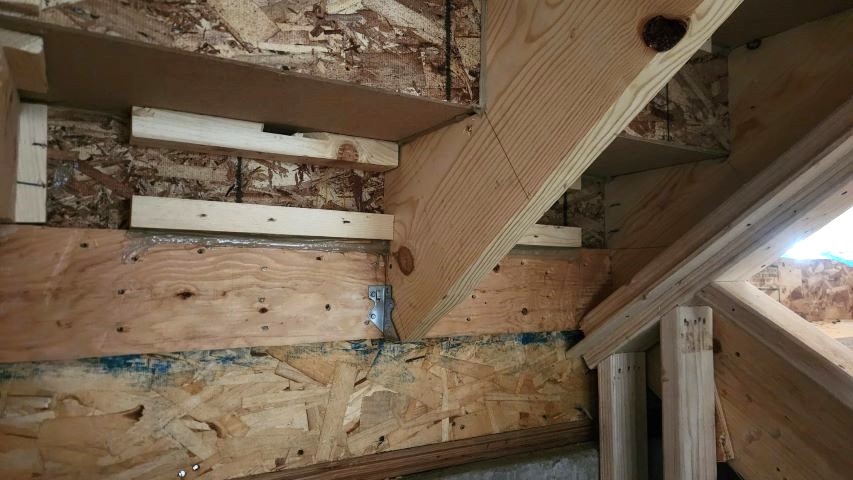

Bird mouth stringers
-

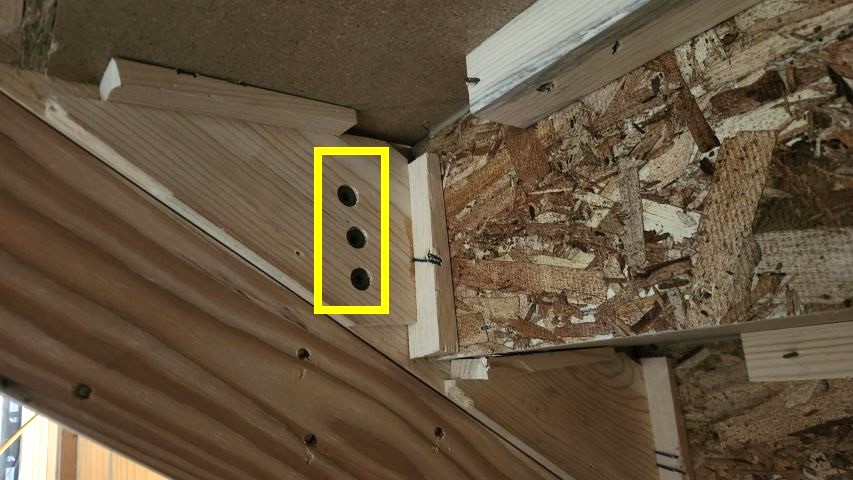

Side of stairs are bolted in the side walls for solid feel
-

Each stair stringer is hung on strap
-

Middle stairs with open stringer installed
-

Upper stairs with open stringer installed
-

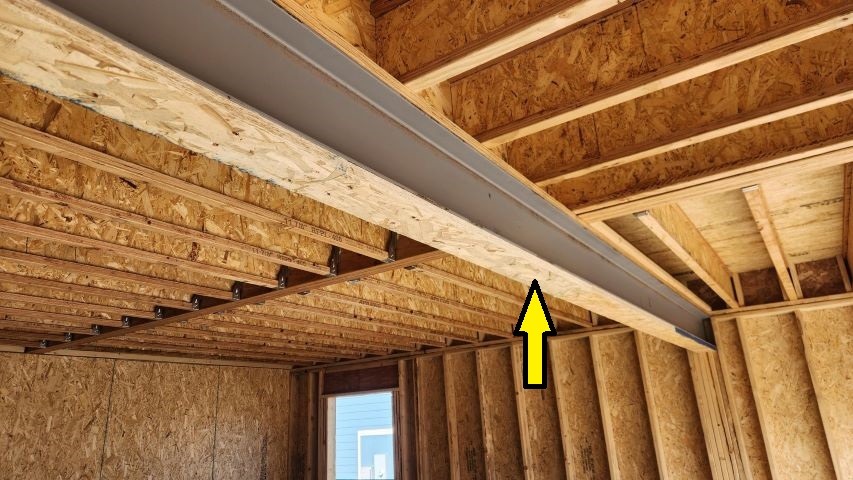

Steel beam plated
-

View from kitchen to solariumÂ
-

Tall kitchen walls
-

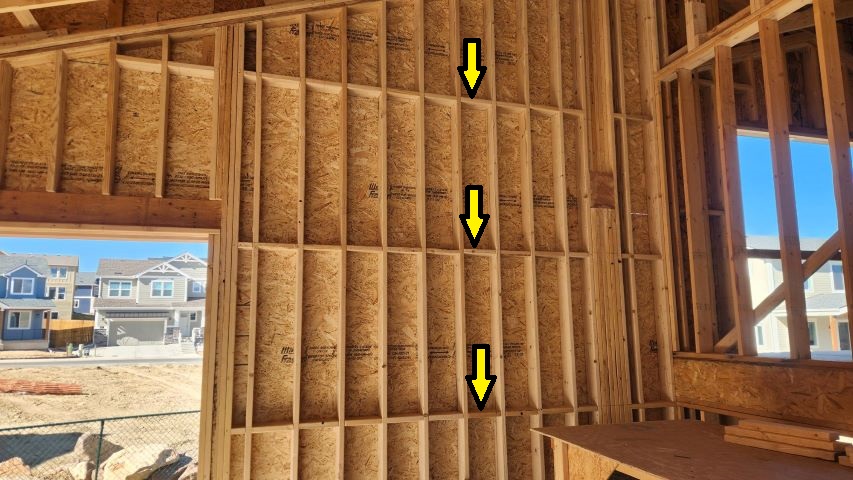

Tall walls blocked 4' O.C. per engineeringÂ
-

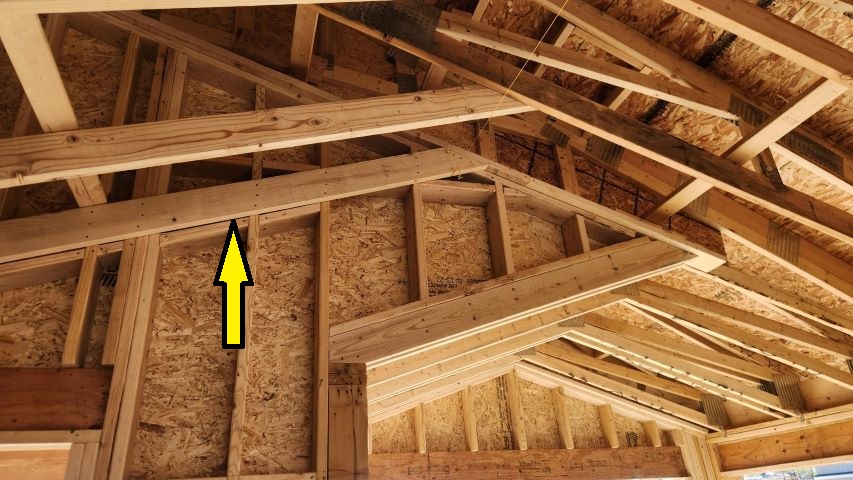

Rake ceilings by entry
-

Windows in great room bring in lots of natural light
-

Ceiling underframe by entryÂ
-

Front entry
-

Front porch ledger and trusses
-

Front of houseÂ
-

Front of house with front porch roof framed
-

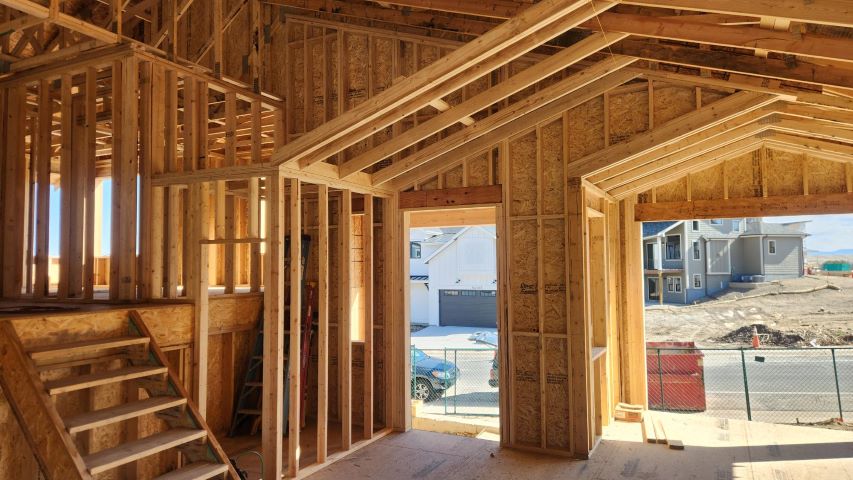

Ceiling lines by entry and solariumÂ
-

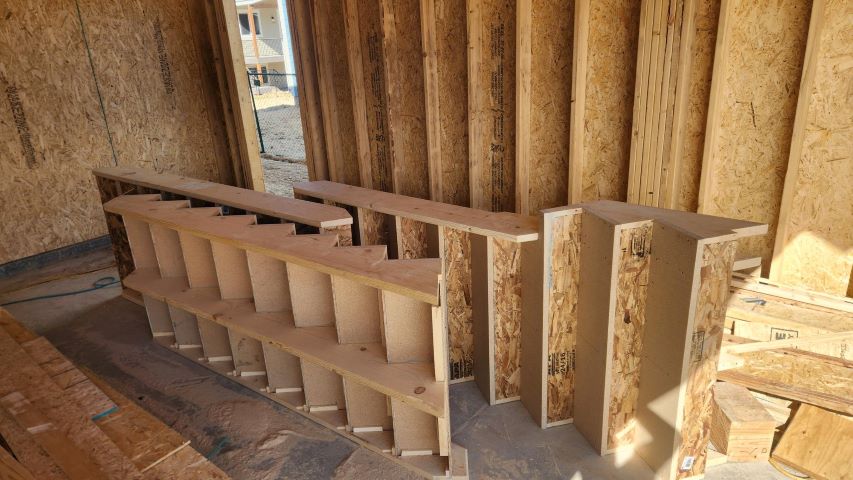

Stairs deliveredÂ
-

View from great room to solariumÂ
-

View from great room thru dining room looking north
-

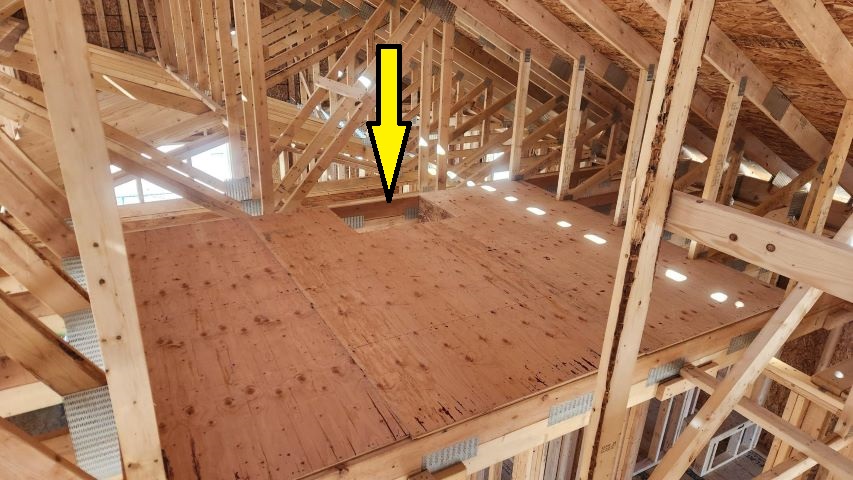

Attic mechanical room subfloor with access
-

Master bedroom attic knee wall will be insulated
-

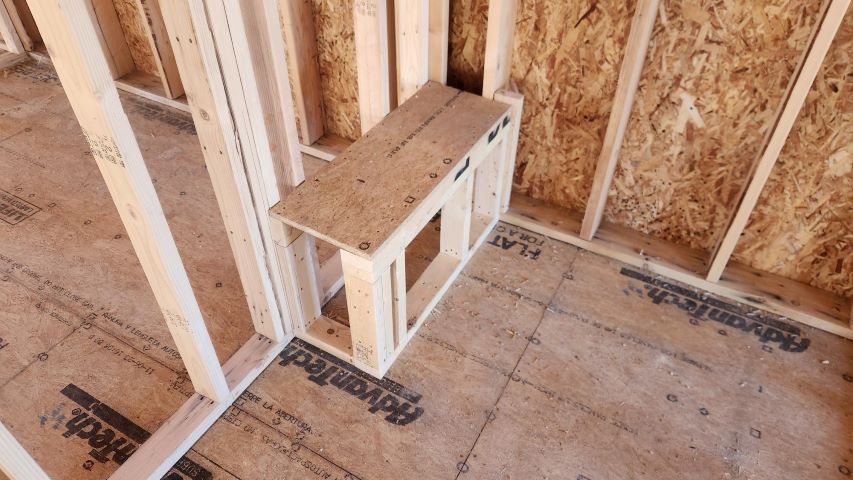

Slightly sloped shower seat in upper bathroom
-

Trusses blocked for perfect drywall edge
-

Slightly sloped shower seat in studio
-

Back of the house with roof sheathed
-

Most of the roof is sheathed
-

Gables are permanently braced
-

Gable bracing
-

Rake master bedroom ceiling is under framed
-

Rear patio beams & columns with bracing removed
-

Tall front rake wall being framed
-

18 foot tall kitchen rake wall is framed
-

Front entry wall being sheathed
-

Shape of house with roof trusses installed
-

Rear patio 9x12 glulam beams
-

Strong LVL headers for future barn door in master bedroom
-

Roof gable overhangs (16 O.C.)
-

Roof gable overhangs are supported with 2x6 (16 O.C.)
-

Roof trusses above great room
-

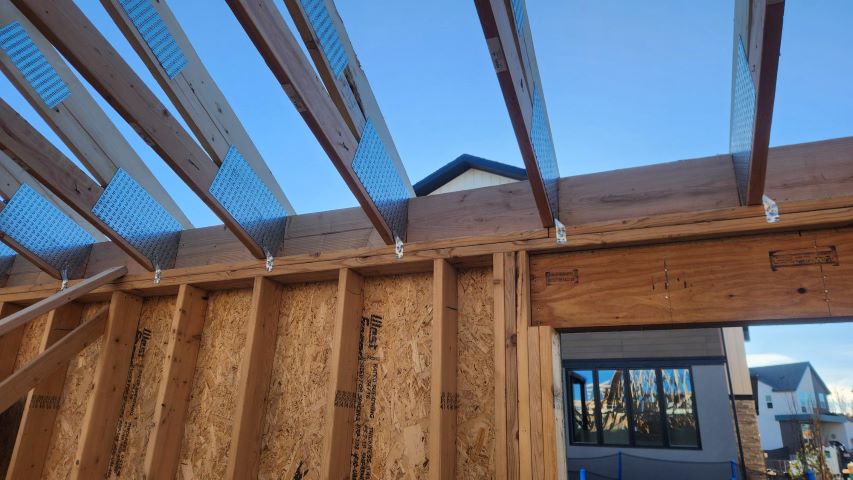

Trusses installed in great room
-

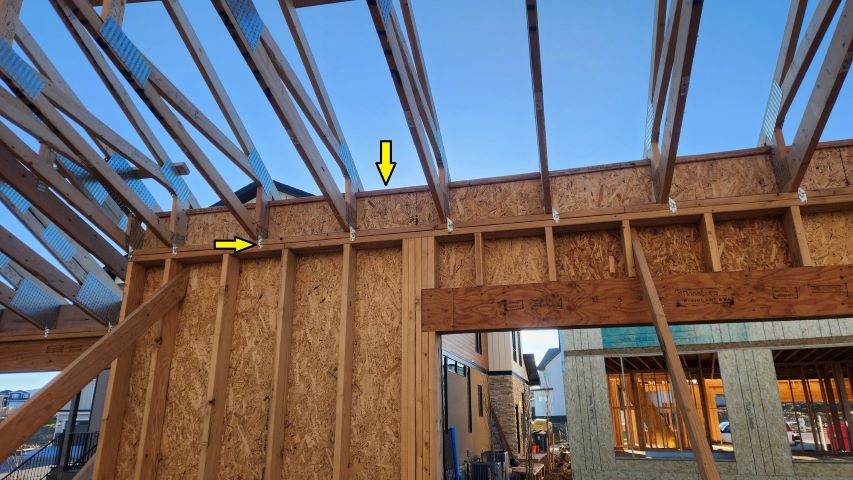

Trusses installed with hurricane clips and roll blocks
-

Future rear patio LVL beams, posts and trusses installed
-

Entry massive glulam posts and beam
-

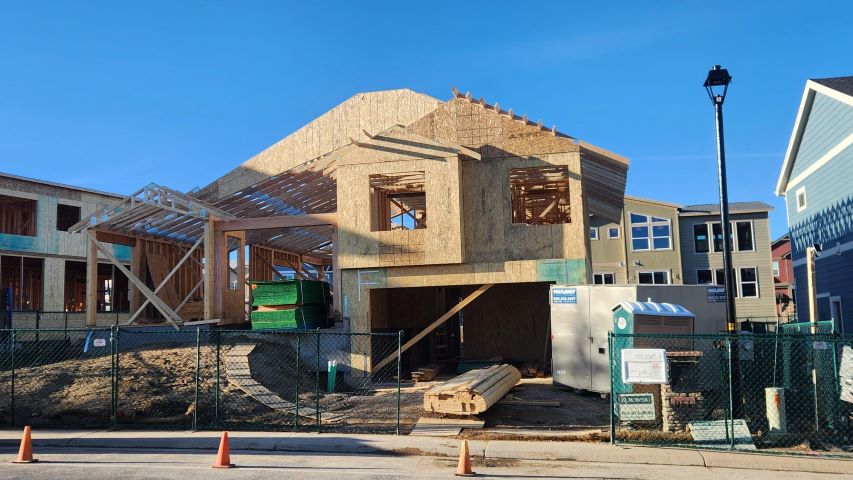

With roof trusses in place house is getting final shape
-

Cranes placing trusses
-

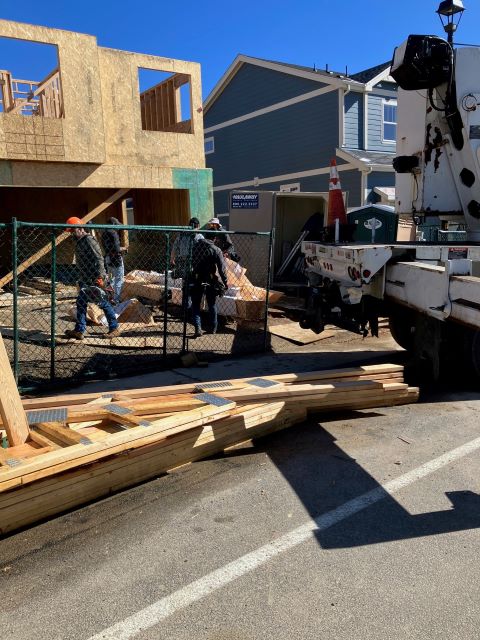

Crane setting up
-

Crane setting up
-

Walls in place awaiting trusses
-

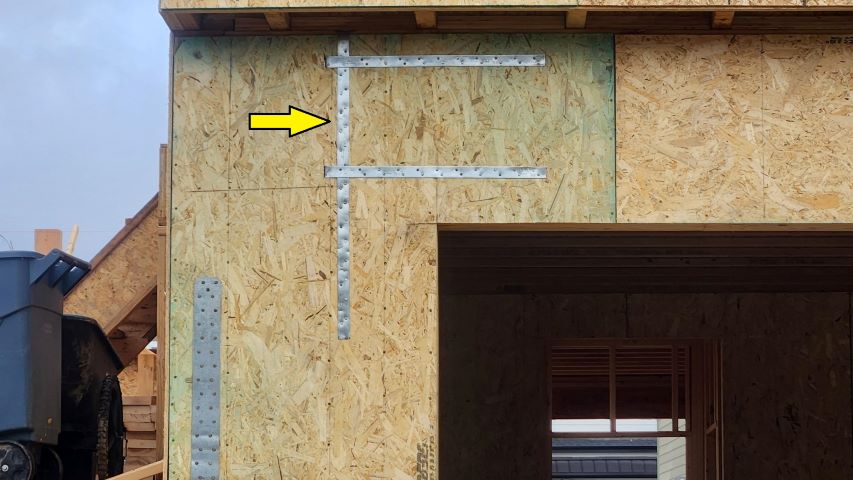

Garage header straps per engineering
-

Top of upper interior walls with metal straps
-

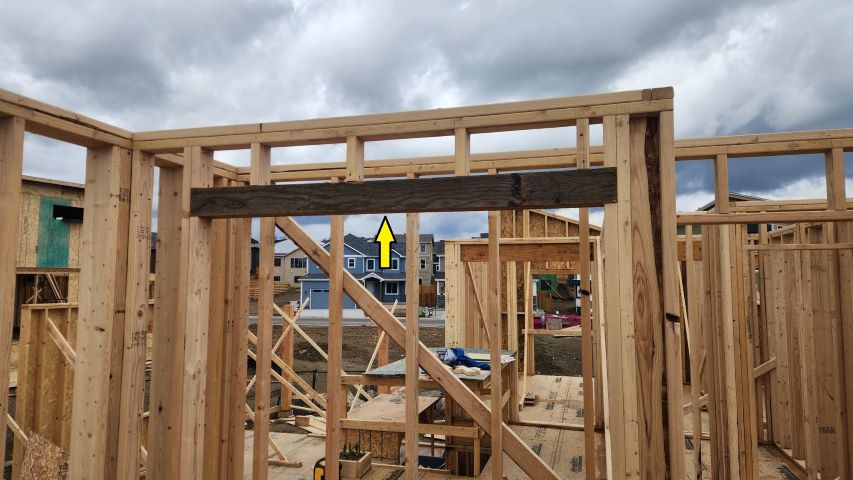

Strong LVL header for bypass door
-

Top plates of upper interior walls
-

Interior walls on upper floor are framed
-

Interior walls in master suite
-

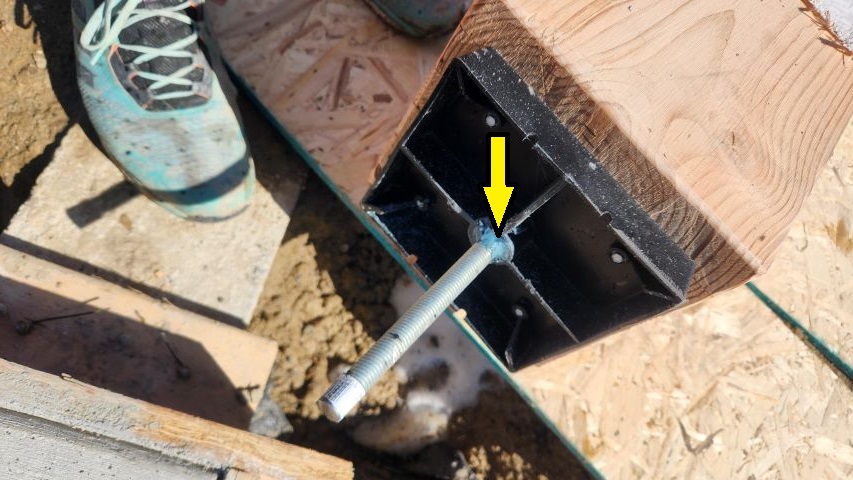

Epoxy rod and post base for 9x9 post
-

Rear patio 9x9 post are ready to be stood up
-

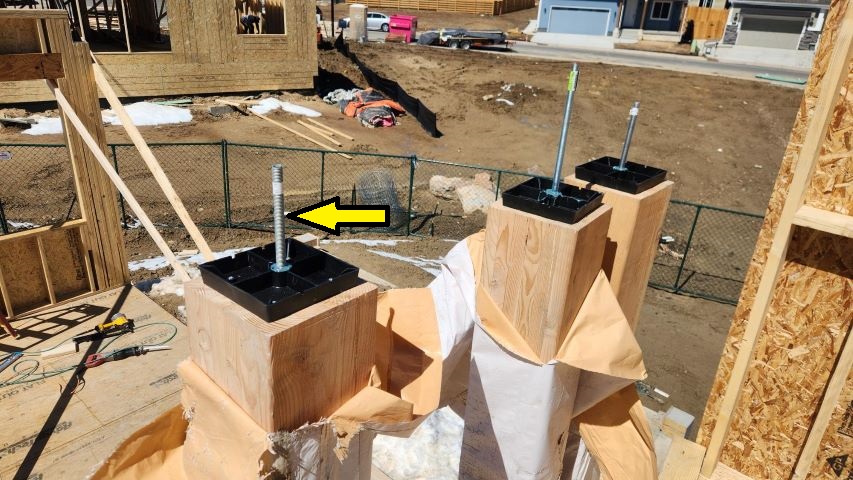

Patio post bases are epoxied upside-down
-

9x9 patio beams joints are cut and drilled
-

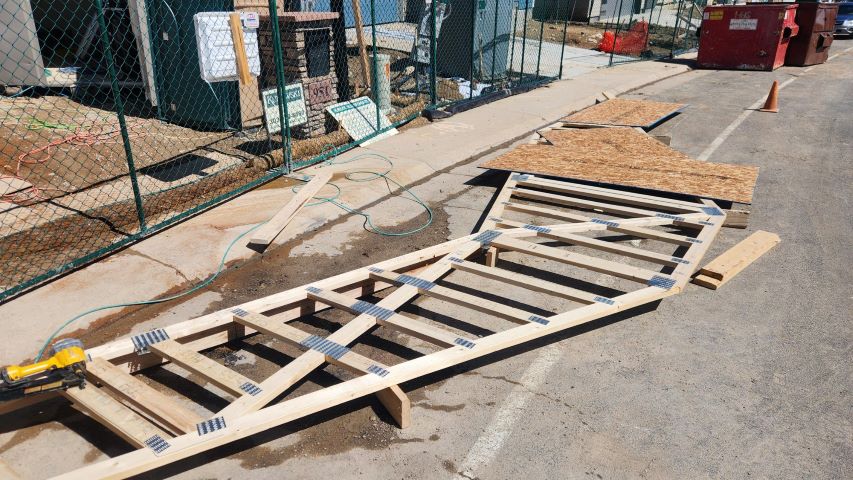

Gable trusses are prepared on the ground
-

Truss gables are sheathed on the ground
-

Glulam posts & beams for rear patio roof are delivered
-

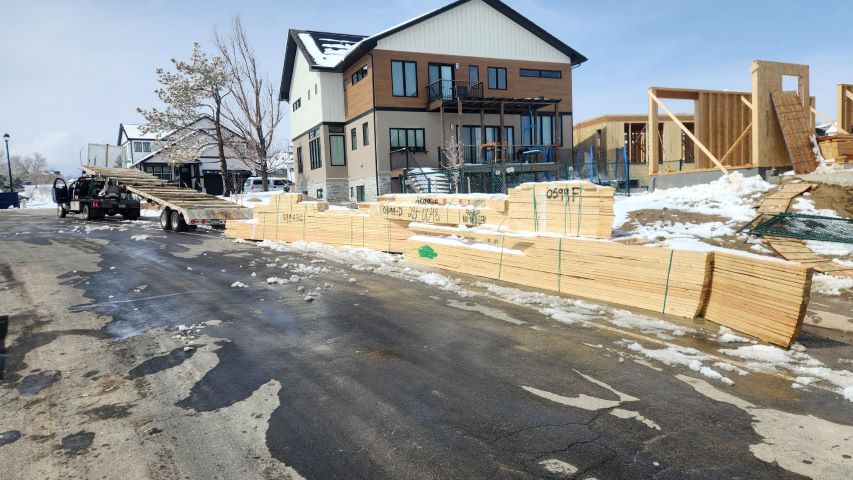

Roof trusses are delivered
-

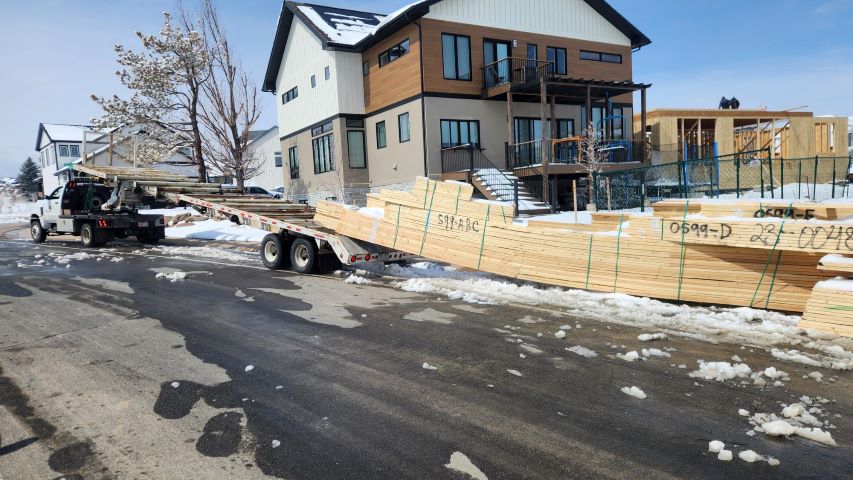

Roof trusses being dropped off
-

Upper walls in front of the house
-

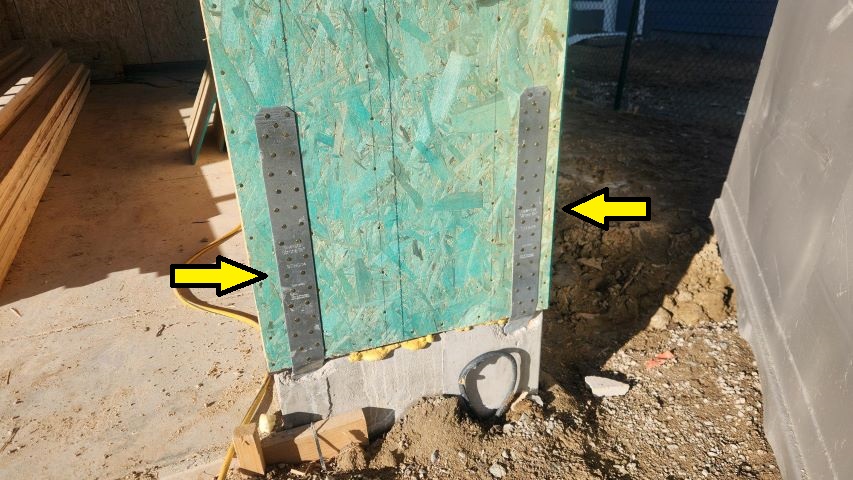

Wall hold downs are nailed
-

Interior wall plates on third floor
-

Interior wall plates on third floor
-

Walls on third floor
-

Master bedroom rake wall is stood up
-

Walkway built to house for a cleaner & safer job site
-

Master rake wall being stood up
-

Front walls on third floor
-

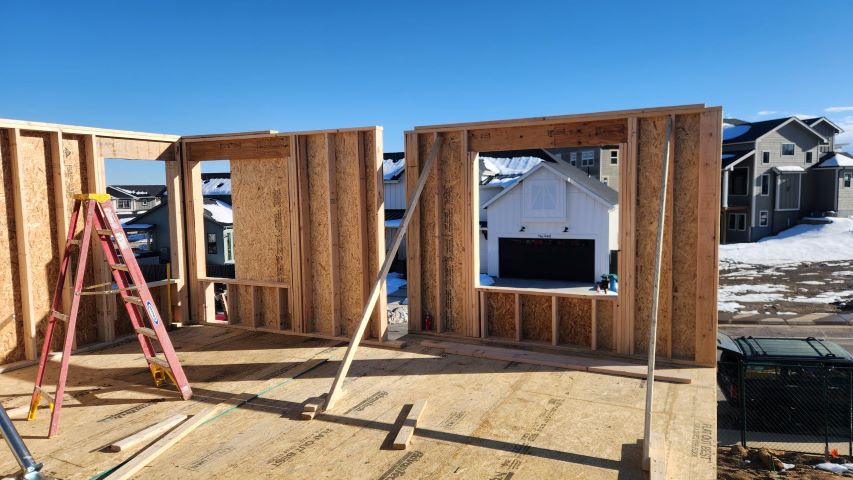

Long wall on third floor is stood up
-

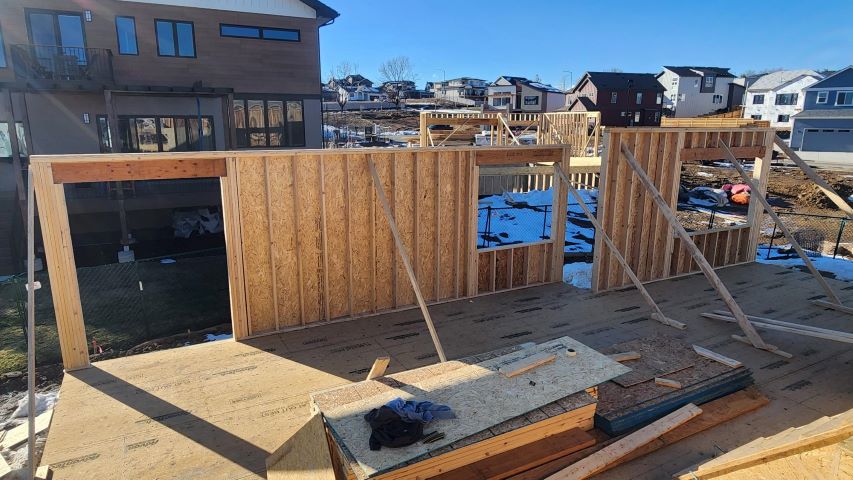

Mid-level floor walls are stood up
-

Third floor front walls
-

Large exterior walls on mid level are framed & sheathed on floor
-

After snow storm
-

Lots of snow in studio
-

Snow piles behind studio walls
-

Main floor buried in snow
-

Bob removing snow
-

After the big snow storm
-

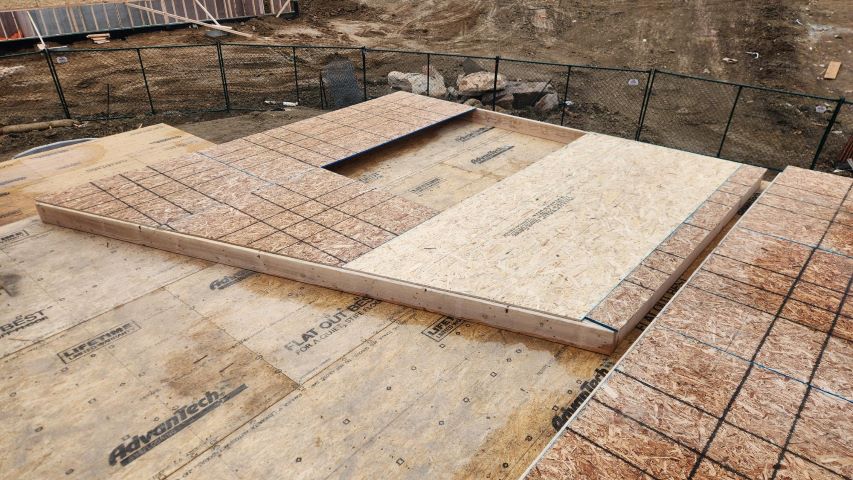

Master bedroom rake wall is framed
-

Big wall on third floor is framed and sheathed
-

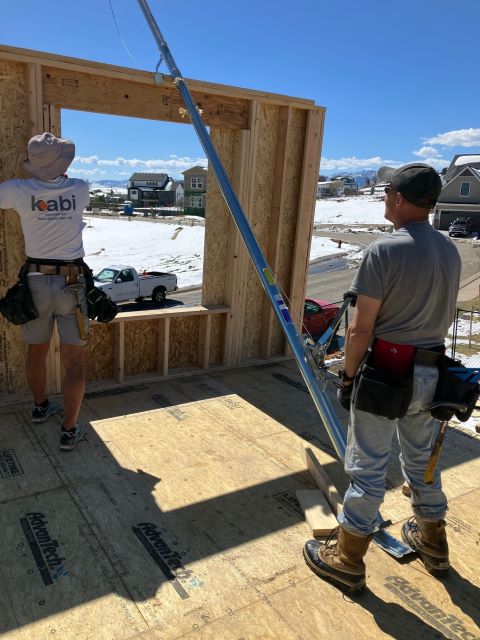

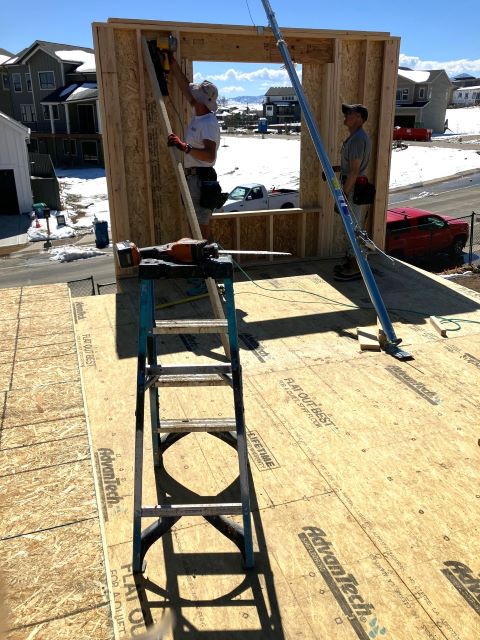

Standing front bedroom wall
-

Standing front bedroom wall
-

Standing front bedroom wall
-

Multi-layer trimmers & posts are built on table for accuracy
-

Bob framing wall on third floor
-

Material is protected from elements
-

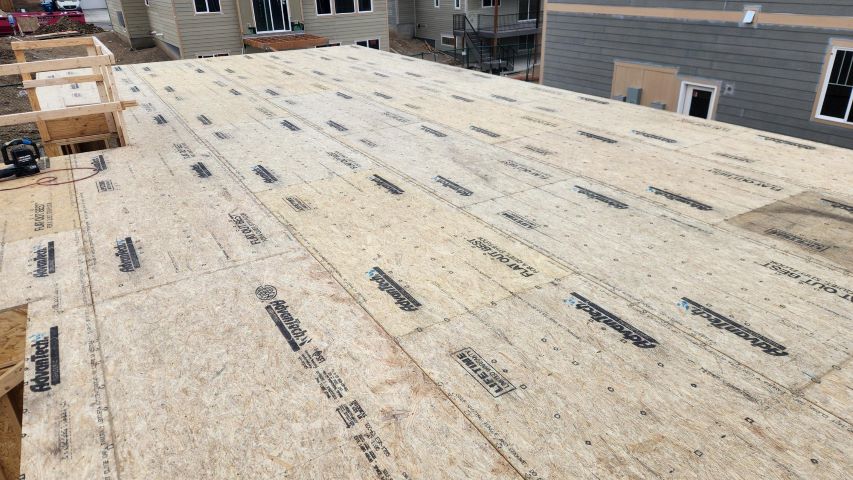

Third floor is sheathed
-

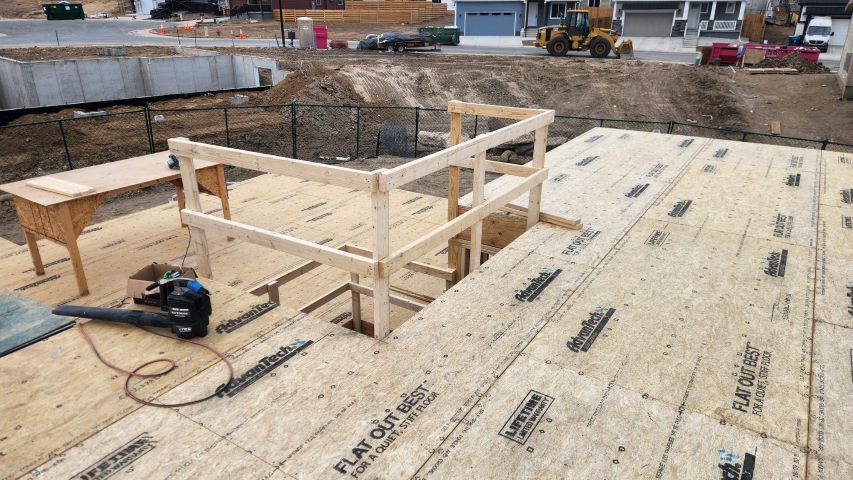

Safety railing around stair hole on third floor
-

Temp construction stairs
-

Safety railing around stair hole on second floor
-

Holes in blocks to insulate floor cantilever
-

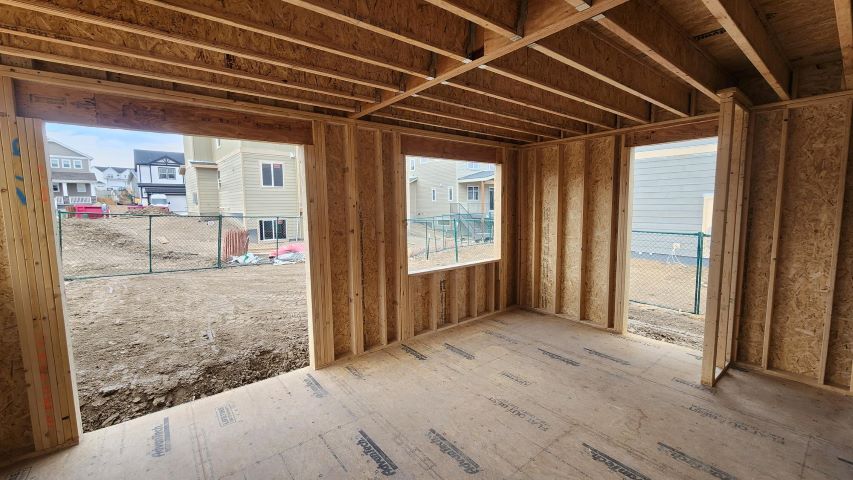

Studio area is cleaned and braces removed
-

Paul insuring a tight subfloor
-

Bob applying glue for third floor subfloor
-

Paul and Bob laying out subfloor
-

Grading the concrete areas
-

Upper floor LVL beams in place
-

Bob nailing joist hangers above studio
-

Crane placing garage steel beam
-

Crane set up with safety cones
-

Beam hangers are nailed
-

Beam hanger above studio
-

Garage steel beam is plated on ground
-

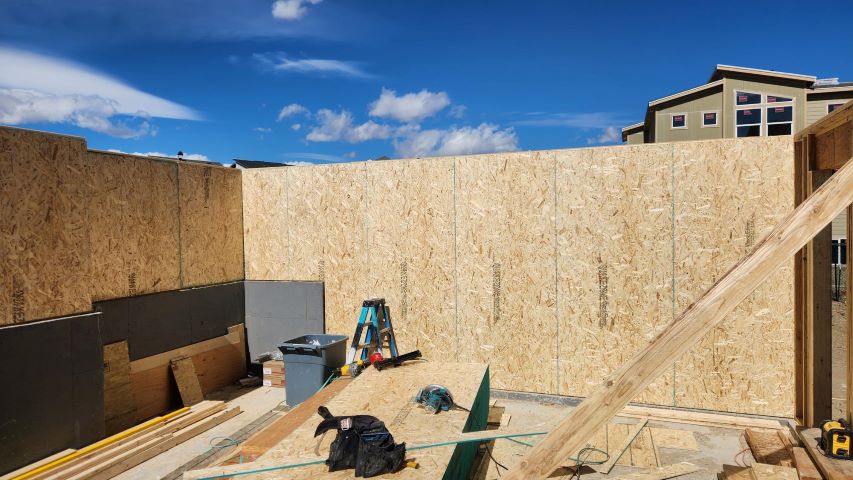

Interior garage walls are sheathed for easy insulation installation
-

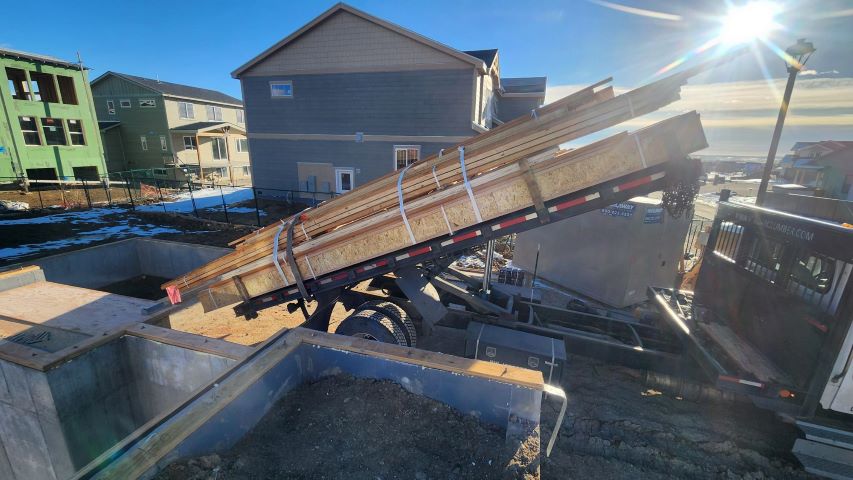

Upper floor material is delivered
-

Garage door is framed
-

Knee walls are braced
-

Pockets for garage steel beam
-

Studio interior walls are framed
-

Massive 4-ply LVL beam above studio
-

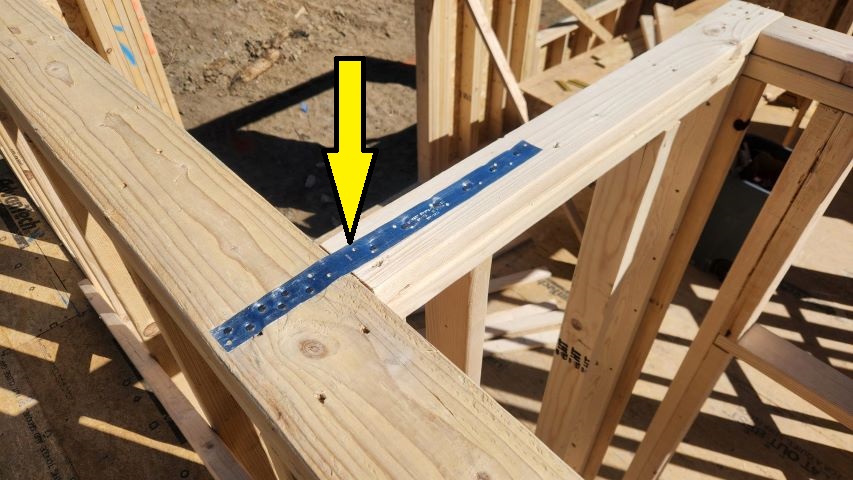

Interior walls are connected with strap to keep exterior wall integrity
-

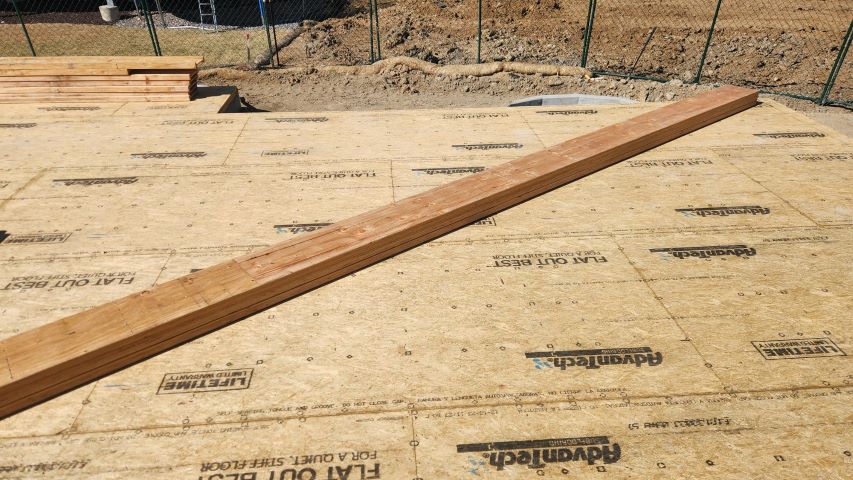

Long 3-ply LVL beam to be raised by crane
-

Walls are perfectly braced per string lines
-

Premium glue under steel beam plate
-

Lines for interior walls
-

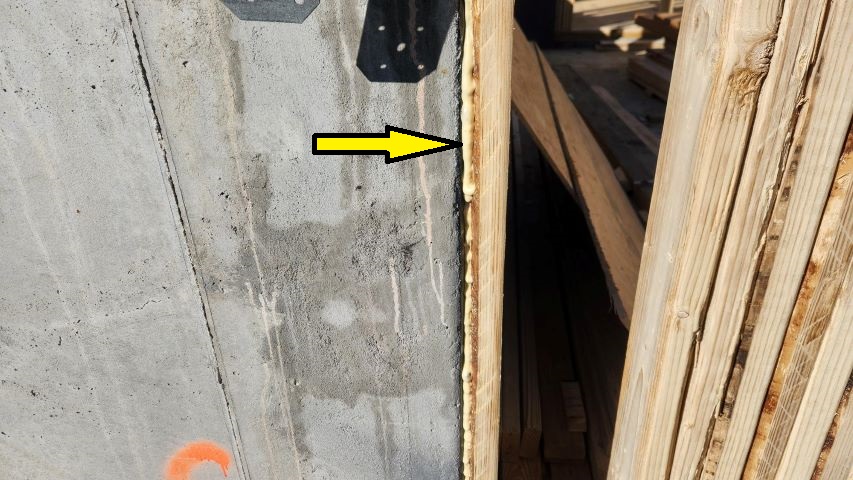

Vertical framing foamed to foundation wall
-

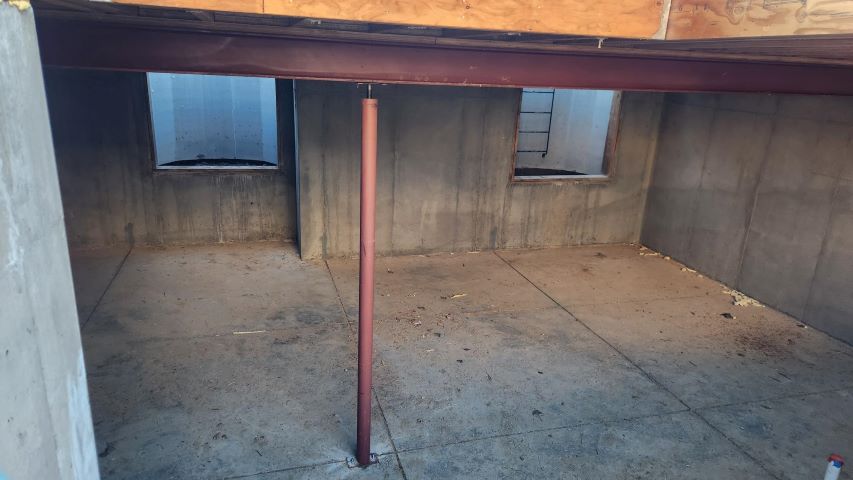

Only steel column in basement is installed
-

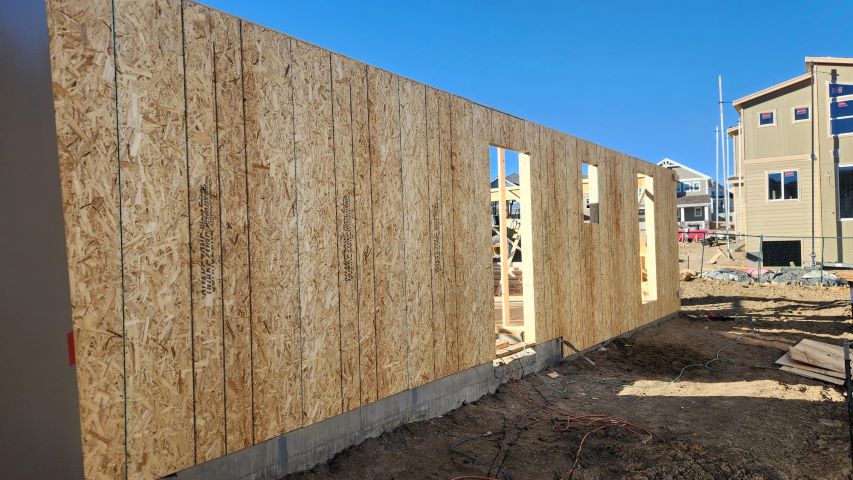

Studio & garage walls are sheathed
-

Framed and sheathed garage walls
-

Massive posts under garage door header
-

Massive garage door LVL triple header
-

Vycor protection between foundation wall and framing
-

Connection for interior and exterior walls open for insulation
-

Superior LVL headers open for insulation
-

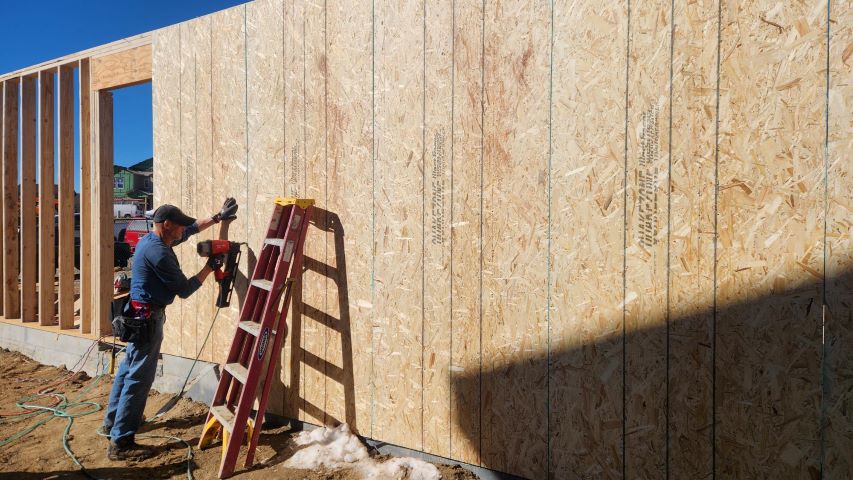

Bob nailing OSB on exterior walls
-

King studs & posts per structural engineer
-

Walls are braced before sheathing
-

Knee walls between studio, basement & main floor
-

Knee walls between garage & main floor
-

Framed pocket for steel beam
-

261Garage walls are framed
-

Exterior walls are stud on foam
-

Advantech flooring installation on main floor complete
-

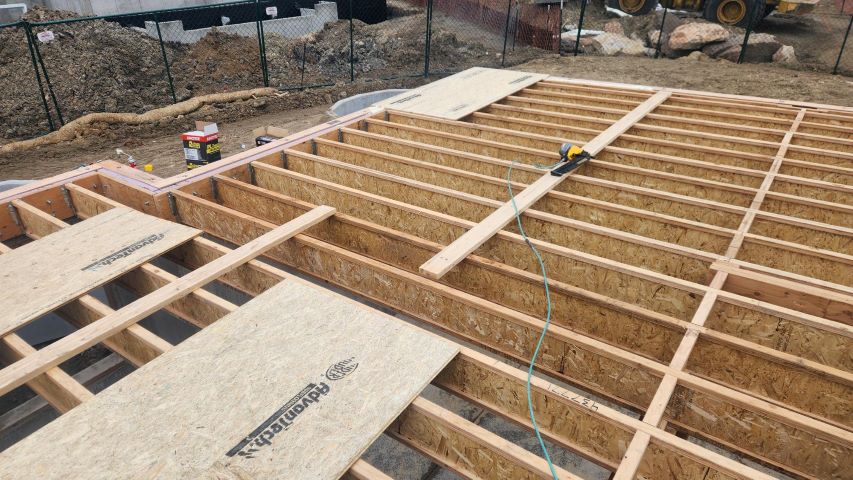

Advantech flooring being installed on main floor
-

Glue & foam around floor ledgers for superior air infiltration control
-

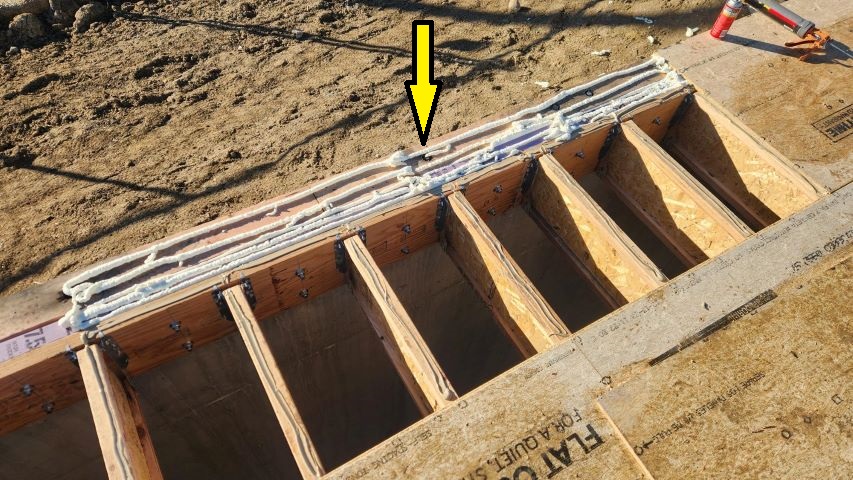

Foam applied before floor sheet is installed
-

Wall material delivered
-

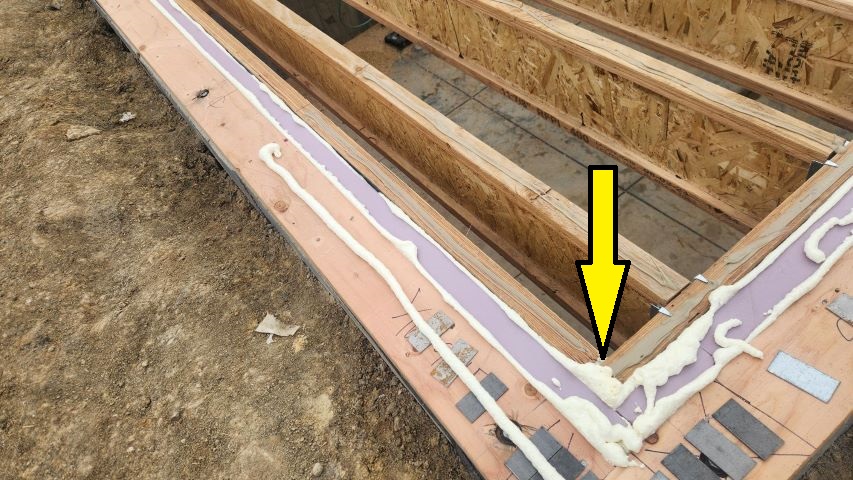

Spray foam over rigid foam block
-

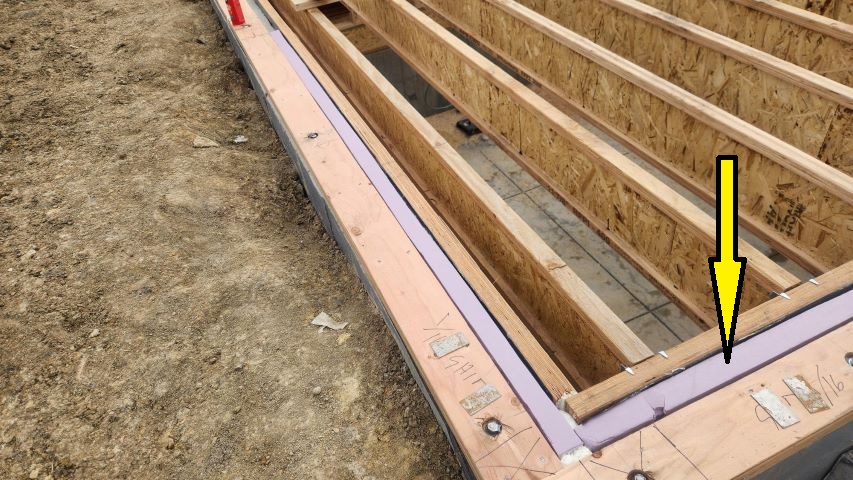

Rigid foam block behind LVL ledgers
-

Spray foam under rigid foam block
-

Studio floor sheathing is completed
-

Main floor stair hole framed
-

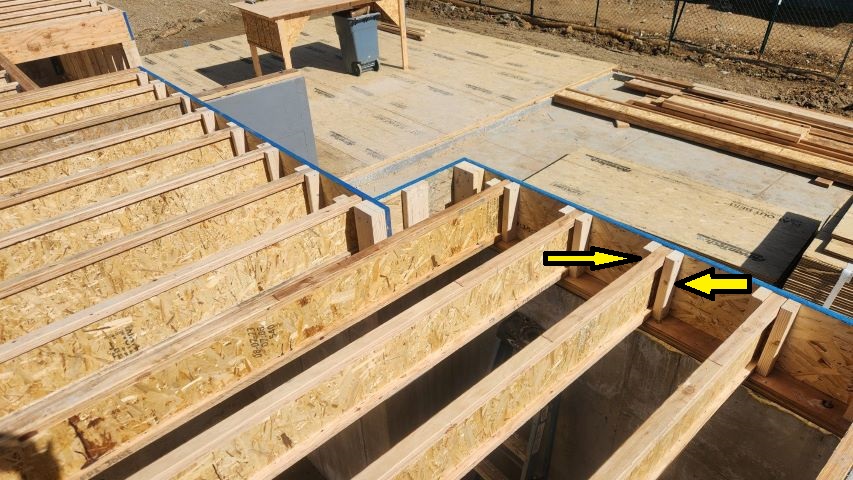

Main floor rim reinforced and squash blocks
-

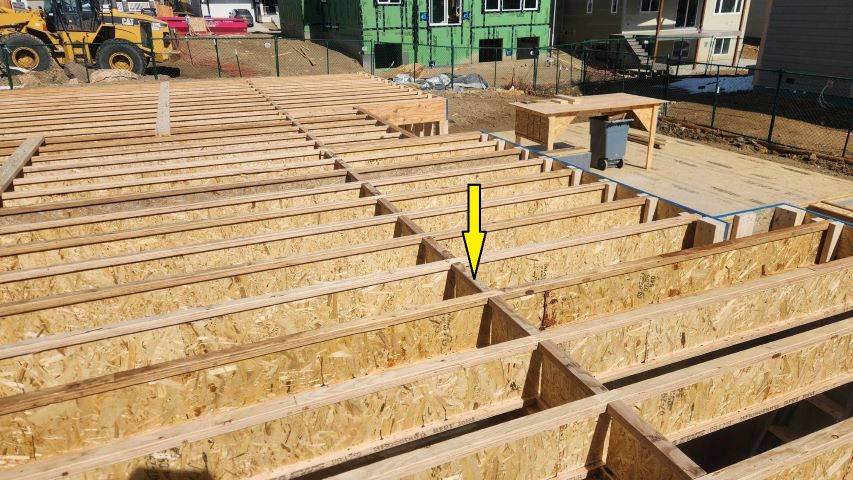

Main floor roll blocks on top of steel beam
-

Main floor joists are braced
-

Staging area is clean and organized
-

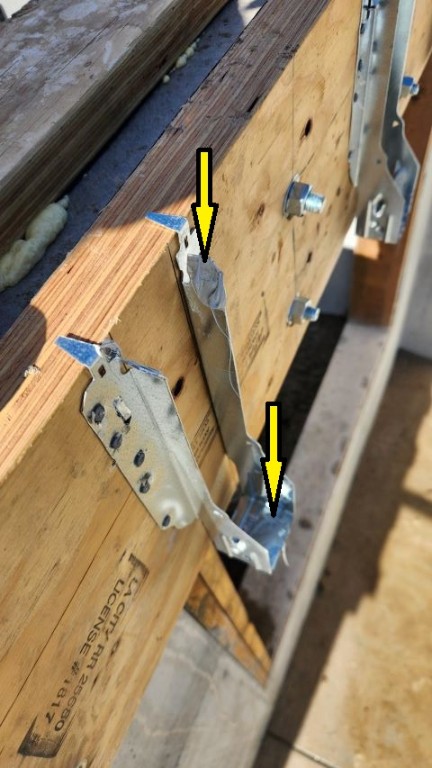

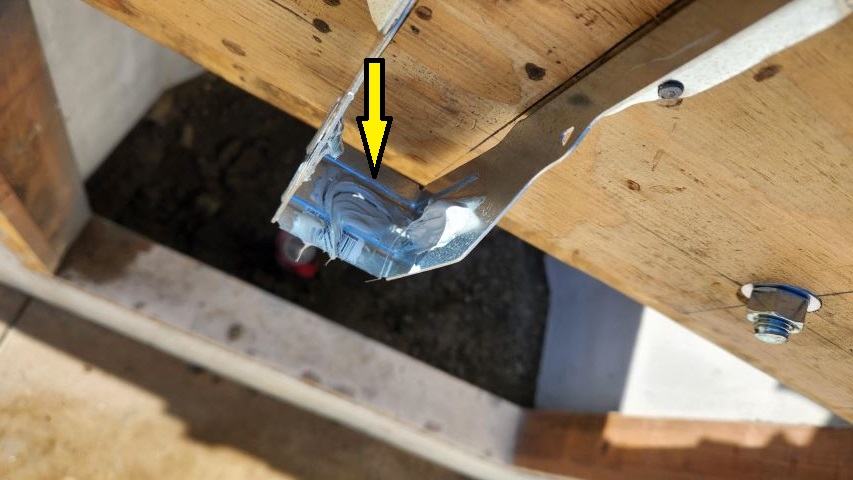

Hangers coated with sealant to prevent floor noise
-

Hangers coated with sealant to prevent floor noise
-

Studio knee wall protected from concrete with Vycor
-

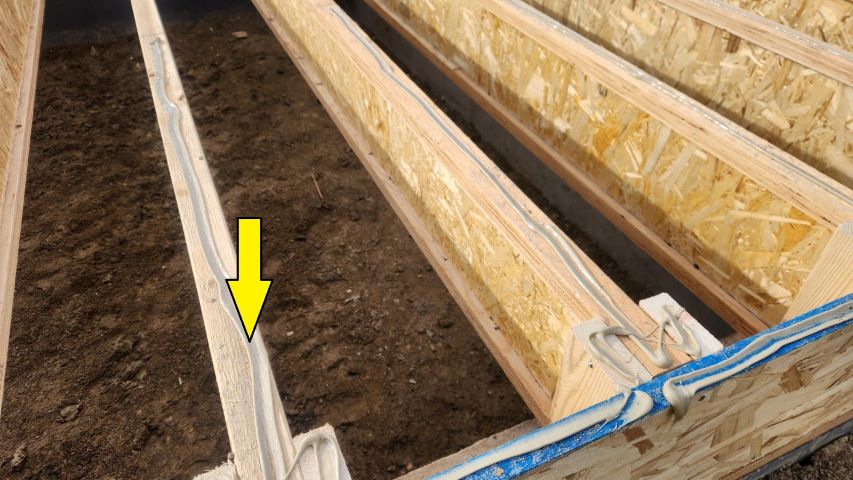

Ample amount of floor adhesive
-

We only use the best floor adhesive
-

Advantech, a superior plywood floor, is used
-

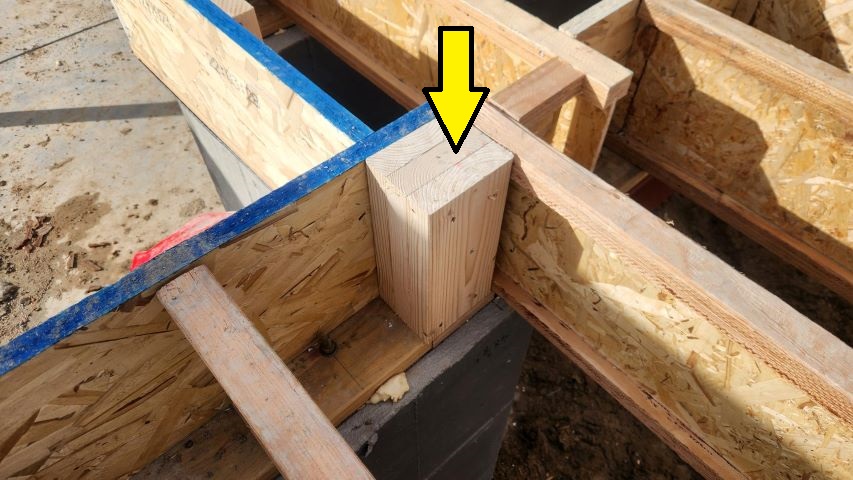

Strong blocks below heavy load points. We see this as very important
-

Roll blocks on top of steel beam
-

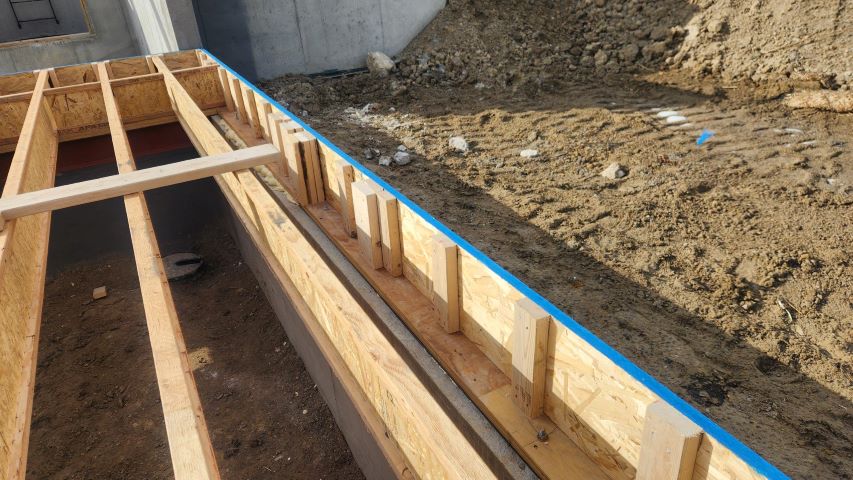

Parallel rim boards are reinforced with blocks
-

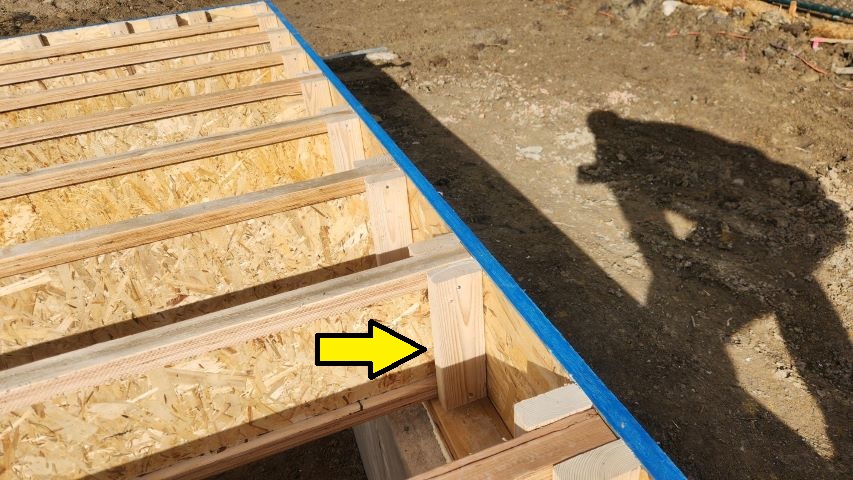

Floor rim is reinforced for roof loads
-

Crawlspace access is framed
-

Floor joists are braced before sheathing to keep them perfectly straight
-

Floor pack material in the future garage
-

Wall material delivered
-

Small steel beam under studio floor in place
-

Steel beam set in foundation pocket
-

Three bolt pattern of LVL ledgers parallel to joist
-

LVL ledgers bolted with five-eighths bolts
-

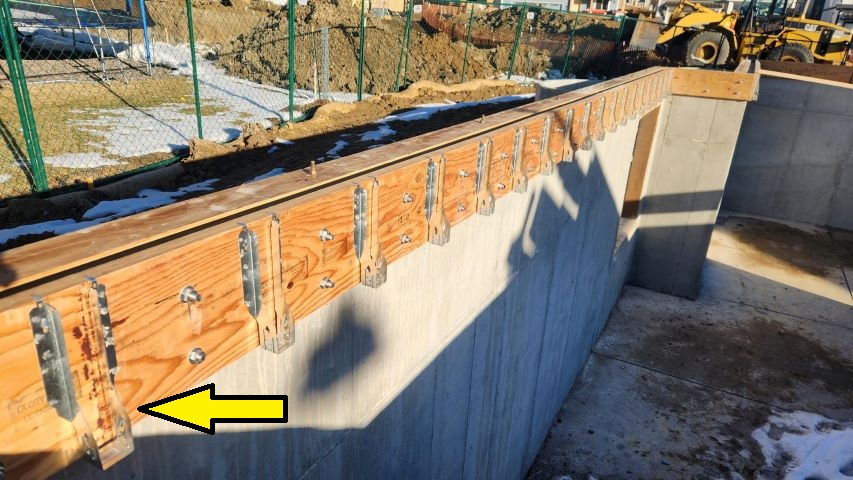

Floor joists hangers on LVL ledgers
-

Long steel beam is plated & braced in place
-

Floor material being delivered to future garage
-

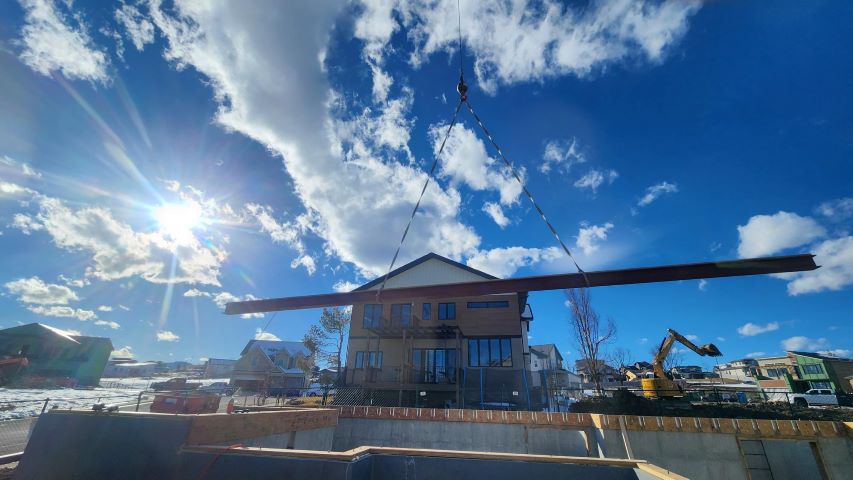

Long steel beam lifted by crane
-

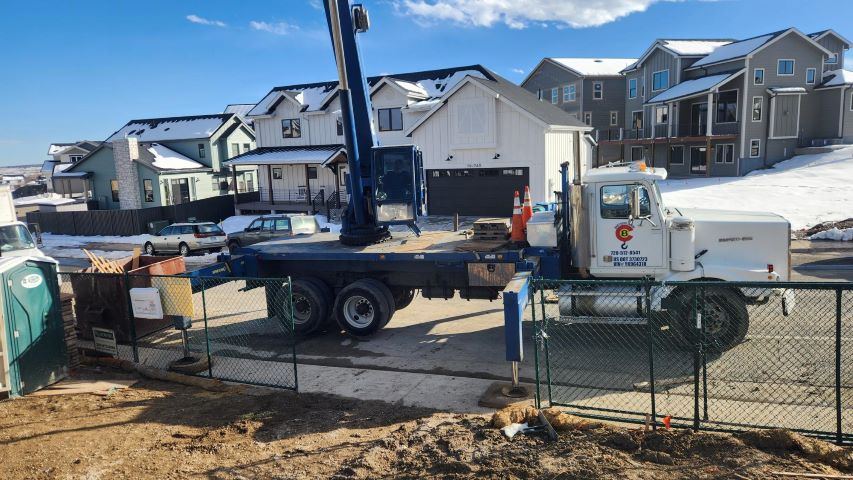

Crane to move steel beams
-

LVL treated plates installed in spray foam
-

LVL foundation ledgers protected with Vycor flashing
-

Sill plates installed using foam for superior air infiltration control
-

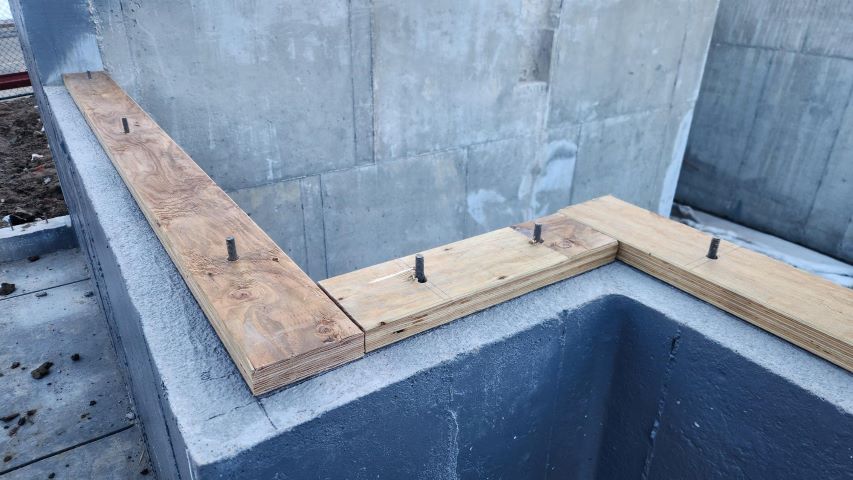

Superior LVL treated plates for a better framing system
-

Beautiful views from Louisville
-

Paul starting to plate foundation
-

Preparing to place special LVL plates
-

Locating the bolts to drill the plates
-

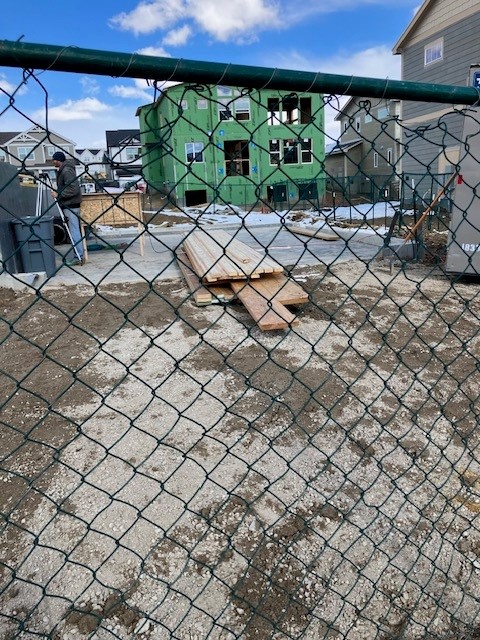

Plates & ledger lumber delivered after road base installation
-

Steel delivered
-

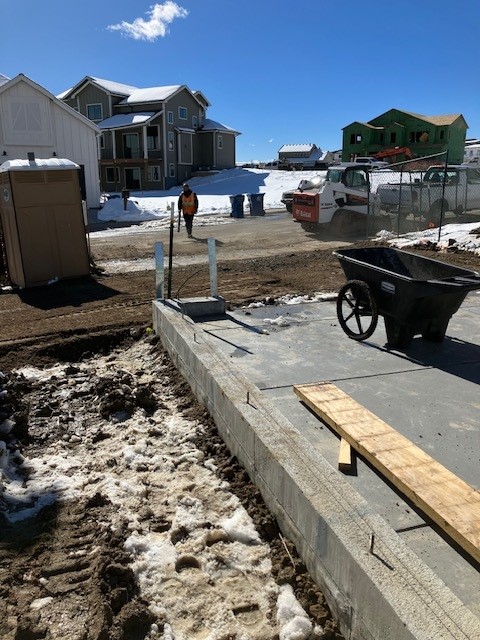

Chewy's man cleaning the street and sidewalks of the road base
-

Road base in place for staging area for mud-free deliveries
-

Road base in place for staging area for mud-free deliveries
-

Spreading road base
-

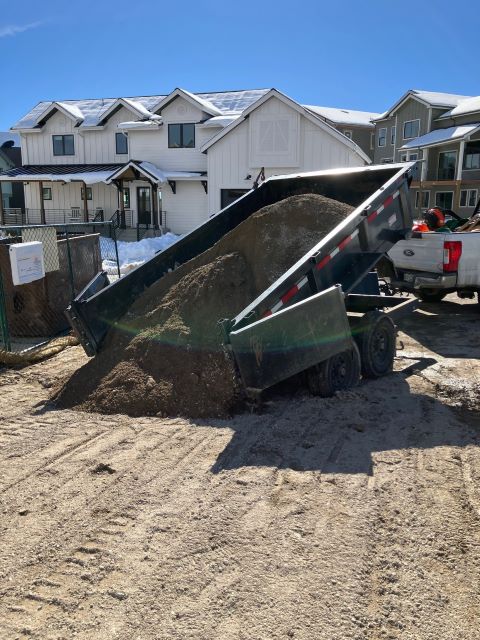

Road base for staging area
-

Staging area setup in garage
-

Parking area cleared
-

Paul shoveling snow off garage floor
-

Before snow cleared from parking area
-

Professional organization of SW equipment
-

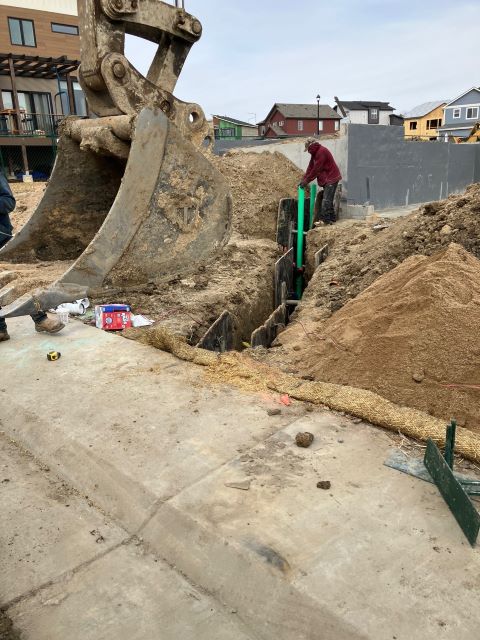

Installing new clean out risers
-

Shoring for new sewer line
-

New meter pit & yoke
-

New water line under gas line
-

Installing new meter yoke
-

Starting trench for water line
-

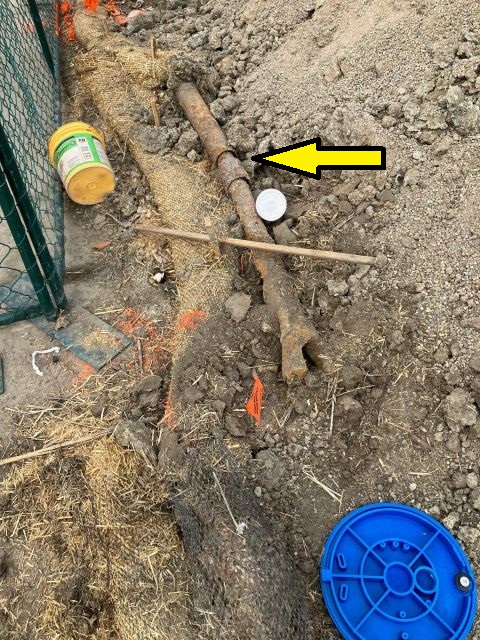

Old curb stop riser box
-

Cutting existing abandoned gas line
-

Gas line located before excavation
-

Exposing old curb stop box
-

Debris left from FEMA cleanup
-

Foundation checked with laser & marked
-

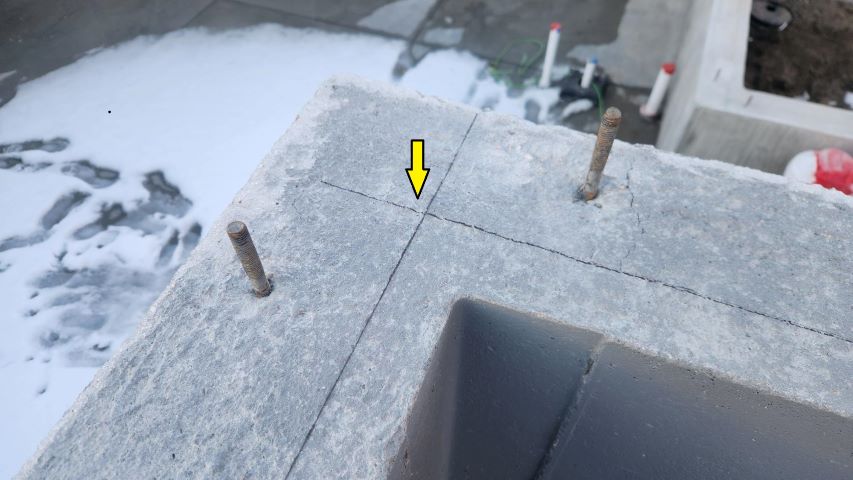

Lines snapped for sill plates
-

Lines snapped for sill plates
-

Very minor rough spot removed
-

Final pass on garage floor
-

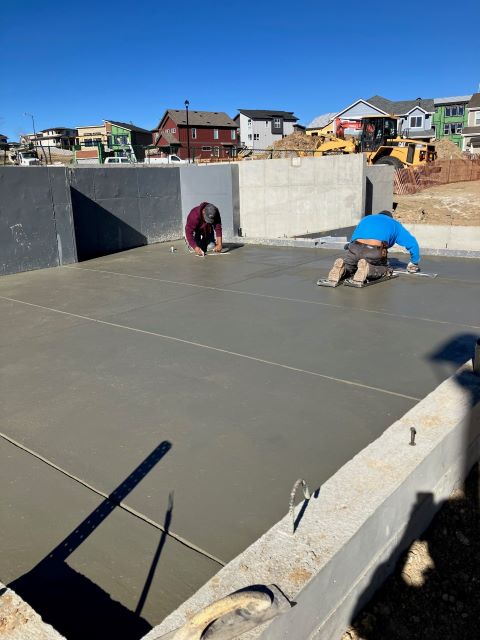

Concrete finishers for garage floor
-

Basement initial level and finish
-

First layer of concrete completed for garage floor
-

Ready for concrete
-

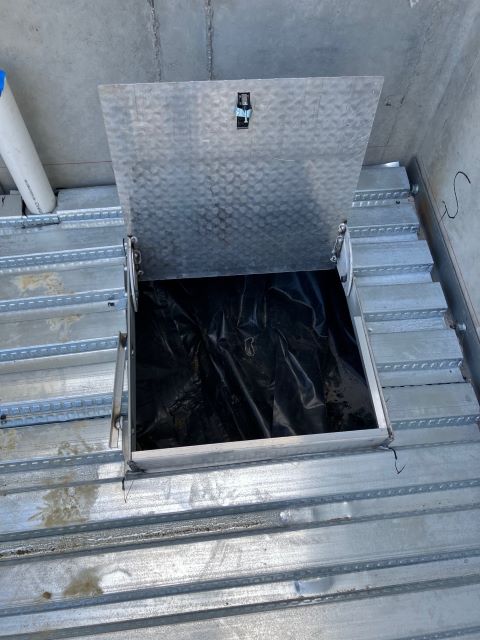

Access hatch
-

Membrane below structural floor mechanically fastened to the walls
-

Membrane below structural floor mechanically fastened to the walls
-

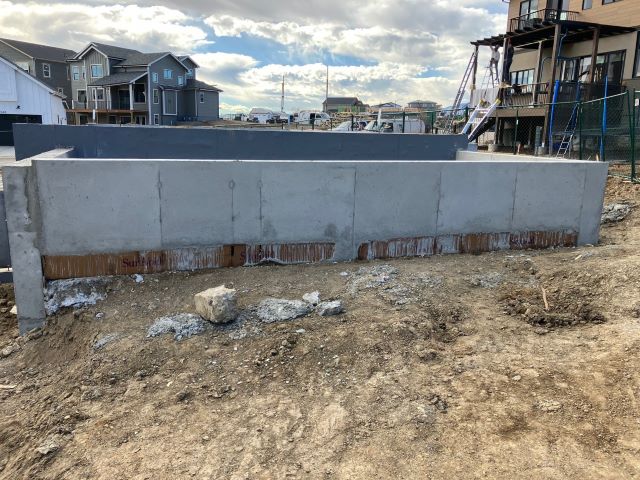

Rear patio walls complete & ready for backfill
-

Rear patio walls complete & ready for backfill
-

Corrugated steel in place - ready for concrete
-

Corrugated steel in place - ready for concrete
-

Basement ready for concrete
-

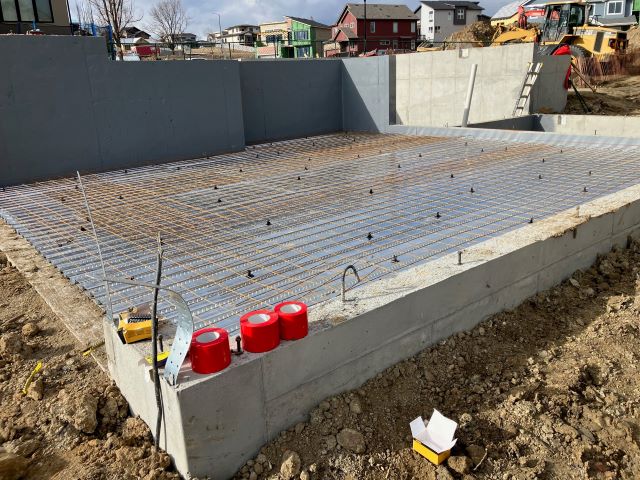

Steel mat in place for structural garage floor. Ready for concrete
-

Vapor barrier with sealed joints under garage structural floor
-

Cutting corrugated panels
-

Radon connection basement to crawlspace
-

Radon mat system
-

Crawlspace leveled ready for radon & vapor barrier
-

Cleaned street & sidewalk per city code
-

Cleaned street & sidewalk per city code
-

Welding & painting welded areas garage structural floor
-

Steel beams for garage floor in place
-

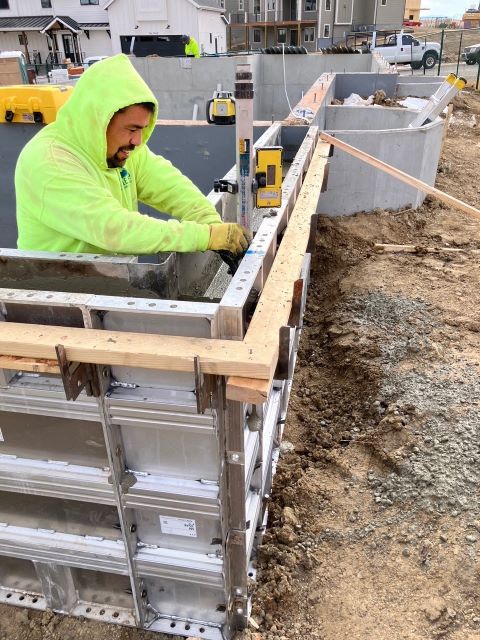

Laser level top of wall
-

Rough top of wall gauge
-

Leveling rear wall
-

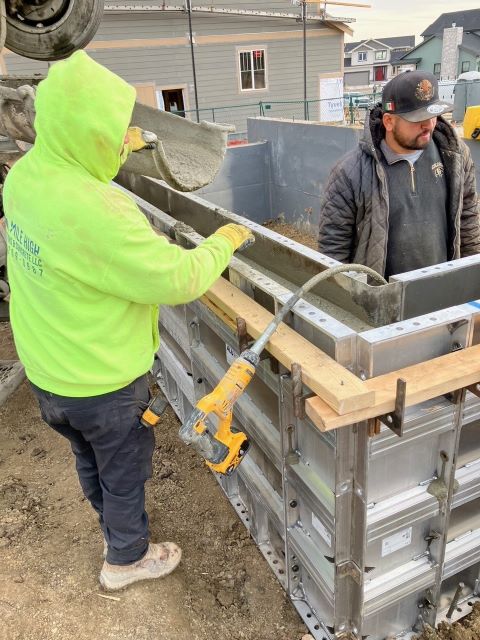

Using the vibrator to remove bubbles
-

Using the vibrator to remove bubbles
-

Moving concrete in the forms
-

Placing concrete for 2nd phase of rear porch walls
-

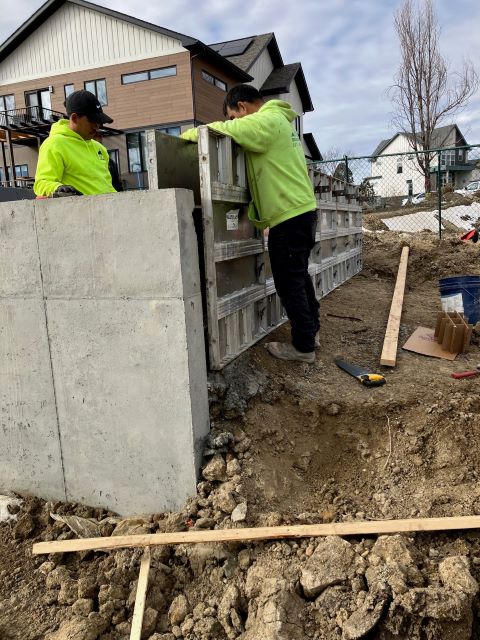

Installing 2nd phase of foundation forms
-

Grading backfill at entry
-

Grading backfill at entry
-

Backfill compaction
-

Backfill compaction
-

Drilling in anchor bolts
-

Installing window well
-

Lifting window well off the truck
-

Beautiful finished concrete walls at front & entry
-

Garage & front entry
-

Structural steel floor in basement
-

Structural floor steel in basement
-

Structural floor steel delivered
-

Basement main support beam
-

Beam supports being attached to the foundation wall
-

Beams & support members being welded
-

Checking for void collapse with rebar
-

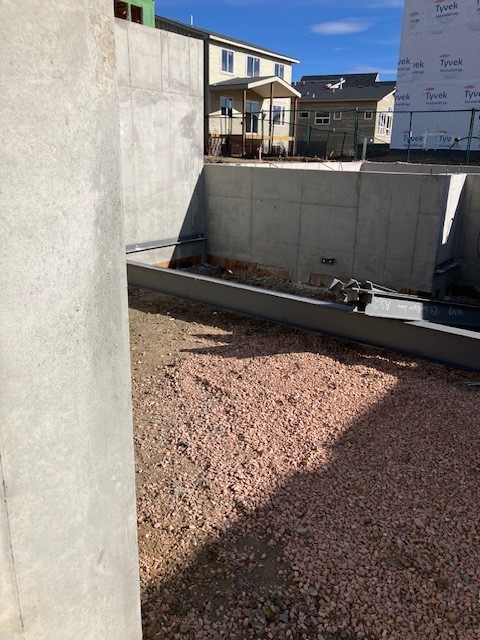

Spoils cleaned out
-

Spoils from drain left in basement
-

Perimeter drain in garage around basement
-

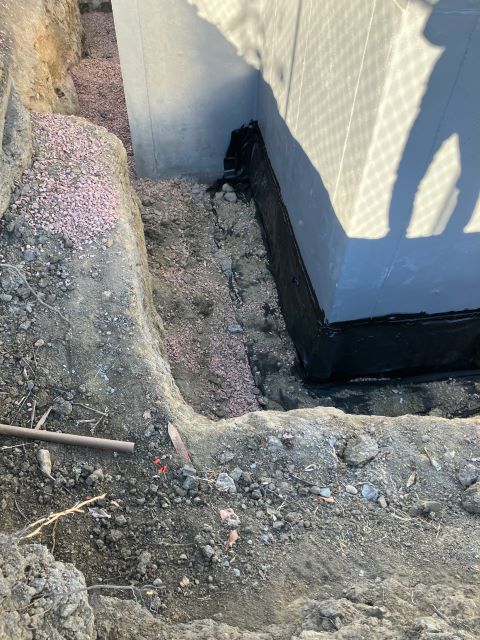

Drain at northwest corner
-

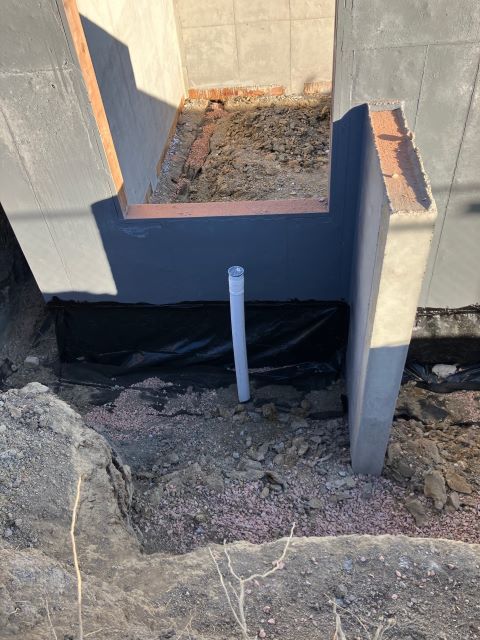

Drain & riser at basement window
-

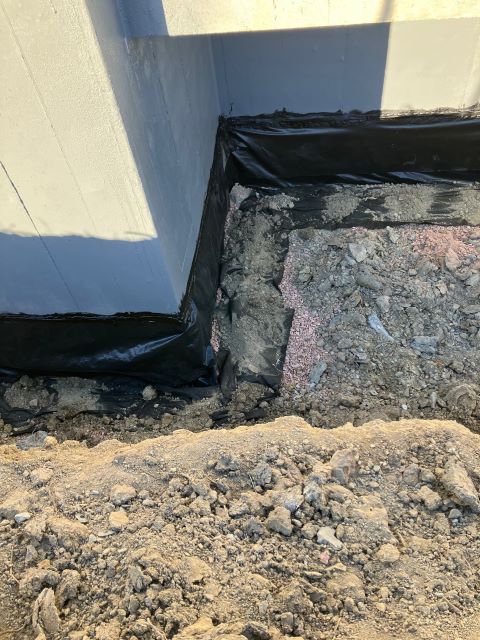

Drain and cover at front entry
-

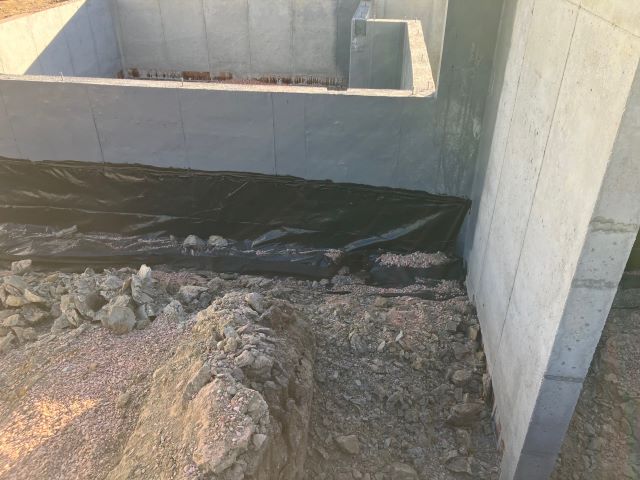

Drain and cover outside crawlspace
-

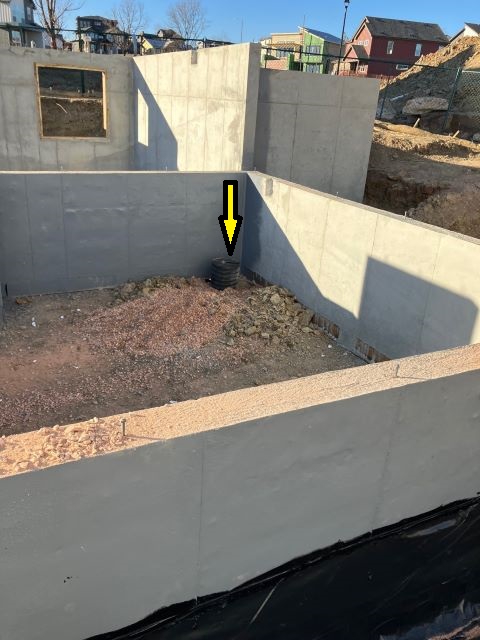

Sump pit in crawlspace
-

Corrugated steel over sewer pipe outlet
-

Insulation blankets over forms
-

Insulation blankets over forms
-

Concrete & anchor bolts placed
-

Concrete & anchor bolts placed
-

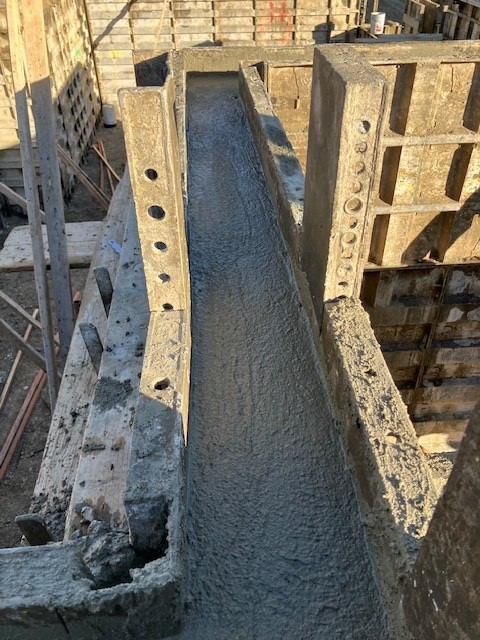

Concrete just placed into forms
-

Leveling & finishing top of foundation
-

Pumping in progress
-

Pump operator using remote control filling forms
-

Pump set up
-

Wall height - 3 feet & 2 inches per plan
-

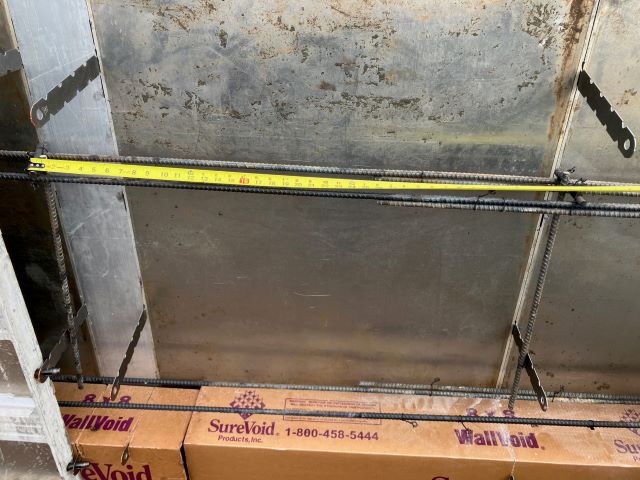

Vertical steel spacing
-

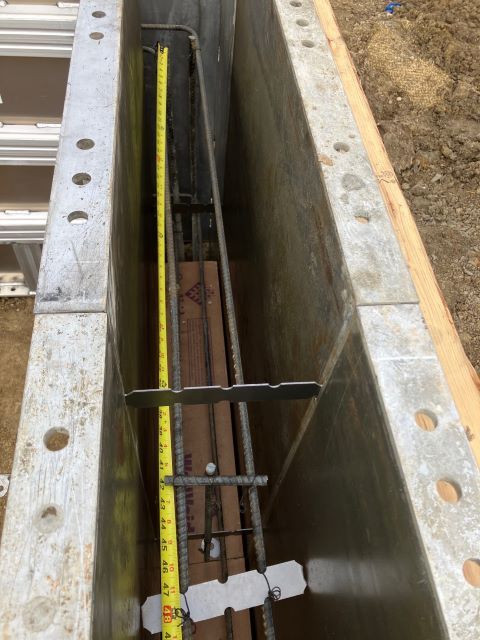

Vertical #4 at 4 ft OC or less
-

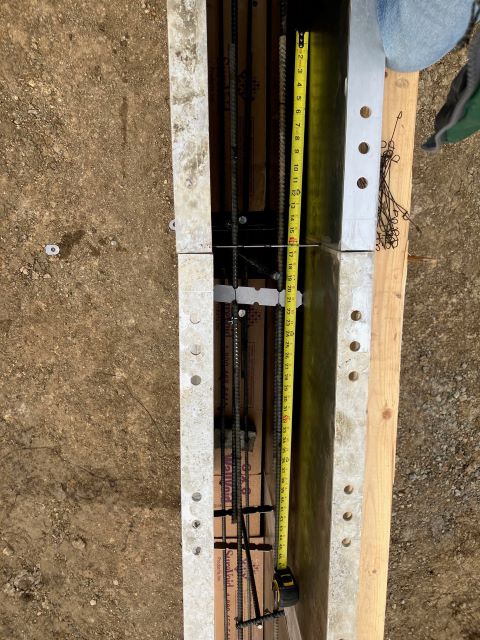

Steel splice well over the minimum 2 feet
-

NW corner wall steel
-

NE corner wall steel epoxied into existing concrete
-

House to porch intersection
-

Corner caisson & wall steel
-

Center wall caisson
-

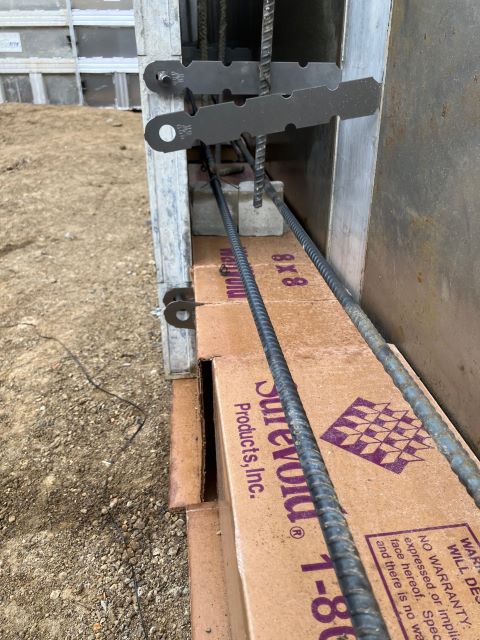

Bottom 2 - #4 bars above the void
-

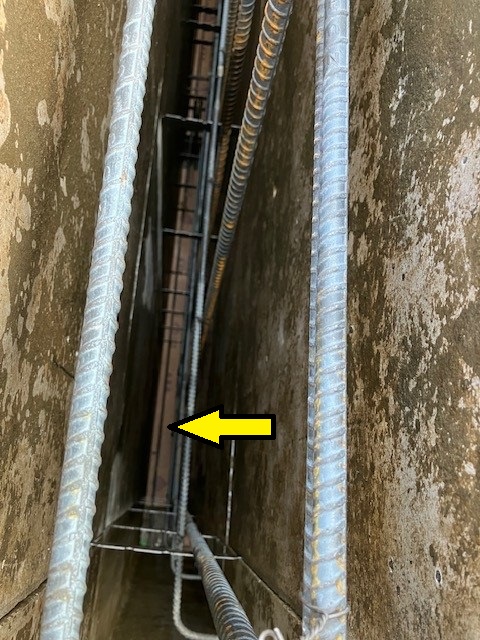

Void at the bottom of the wall
-

Void material being delivered
-

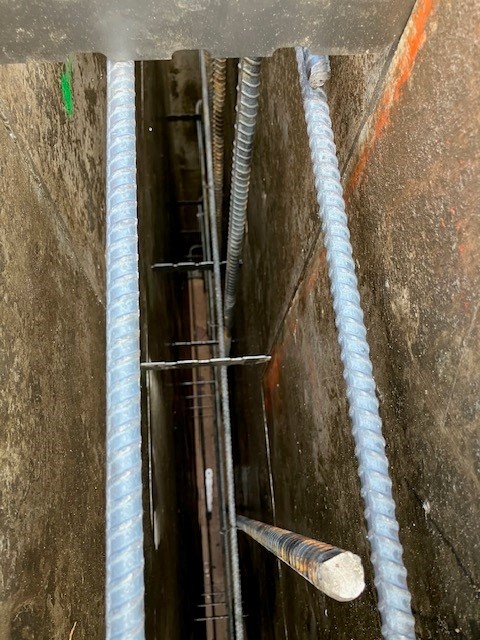

Wall reinforcing per engineer design
-

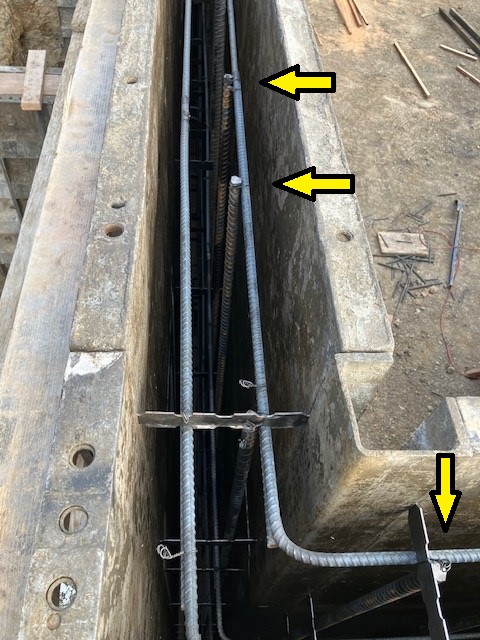

Vertical reinforcing bars
-

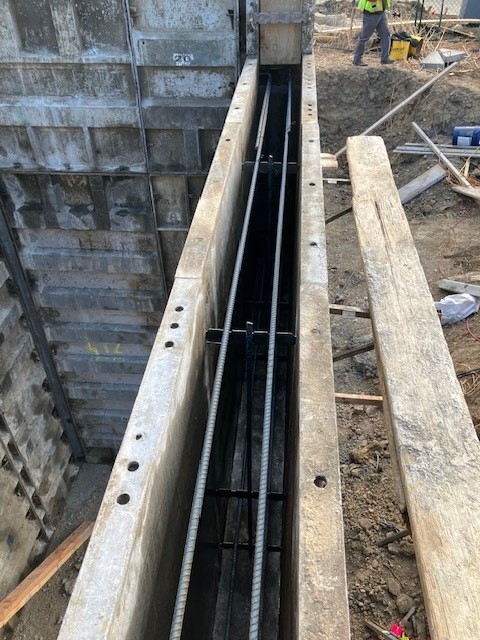

Reinforcing per engineered plans
-

Reinforcing per engineered plans
-

Reinforcing over wood window buck
-

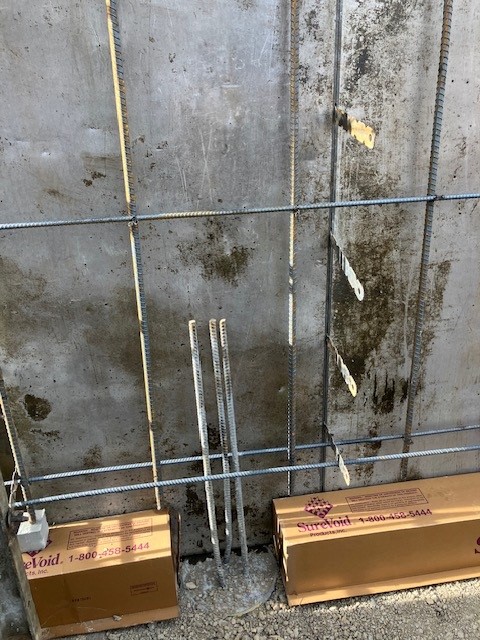

Reinforcing details
-

Reinforcing details
-

Reinforcing details
-

Reinforcing details
-

Reinforcing details
-

Forms set & ready to place concrete
-

Final pieces being placed in the forms
-

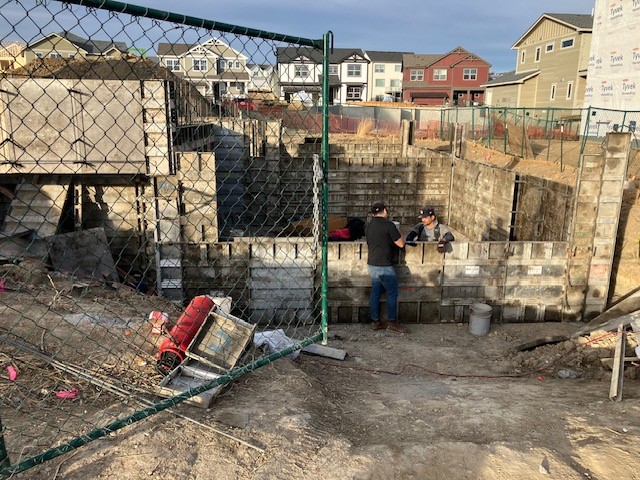

Reviewing wall heights
-

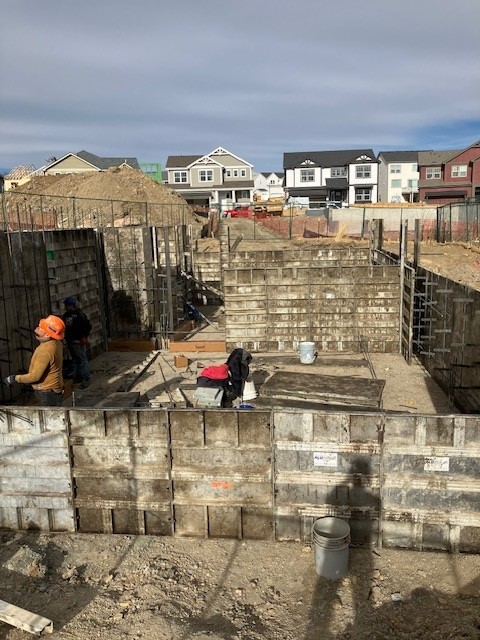

Exterior forms in place
-

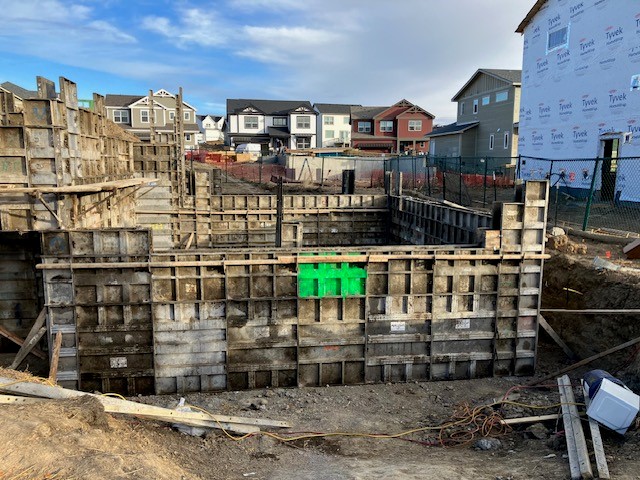

Garage forms
-

Foundation form placements in progress
-

Foundation form placements in progress
-

Form placements in progress
-

Forms being loaded into excavation
-

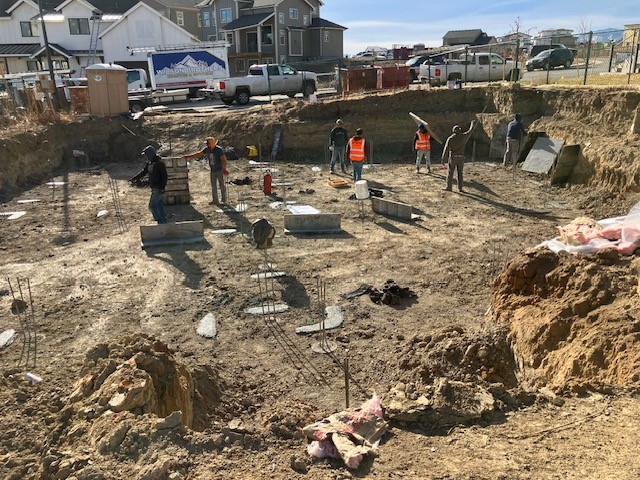

Intermediate support pads poured in place
-

Caissons & pads with steel
-

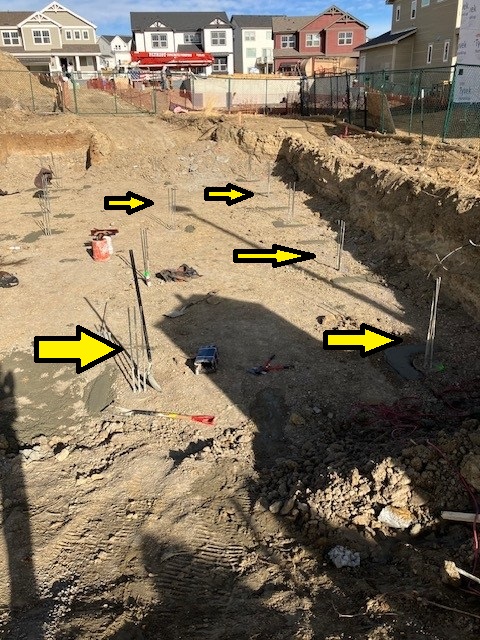

All caissons with steel poured in place
-

Corner caisson with support pads
-

Finished caisson top
-

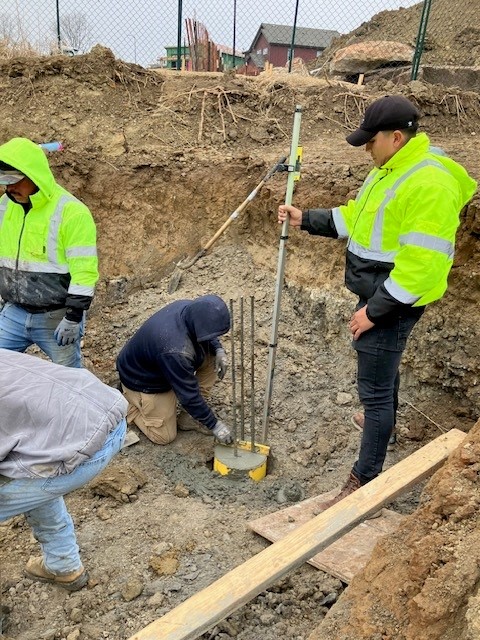

Sonotube in place & finishing at proper elevation
-

Caisson tops covered with insulation & blankets for protection from cold
-

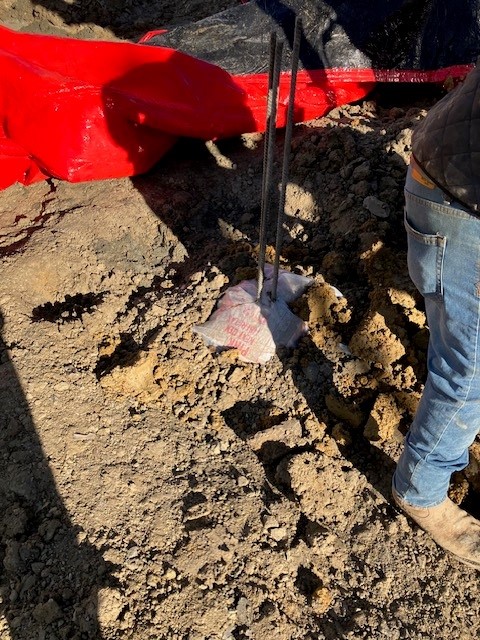

Caisson top before sonotube top set in place to prevent mushrooming
-

Placing concrete into drilled hole
-

Checking caisson elevation
-

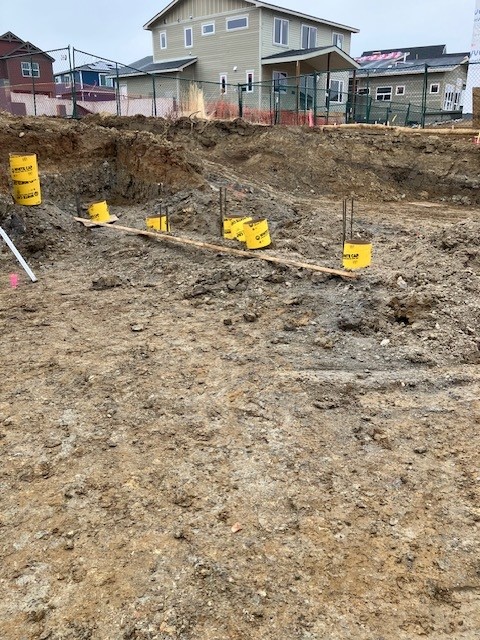

Drilled holes with steel in place
-

Cleaning spoils away from the hole
-

Caisson drilling in progress
-

Drilling caissons per soil engineer
-

Excavation complete & caisson locations pinned
-

Excavation complete & caisson locations pinned
-

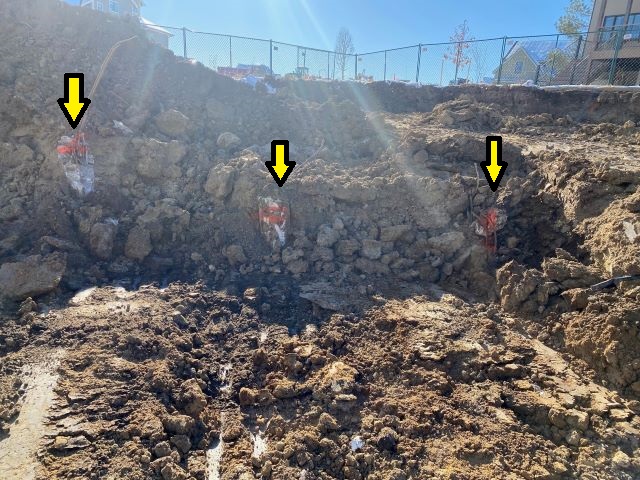

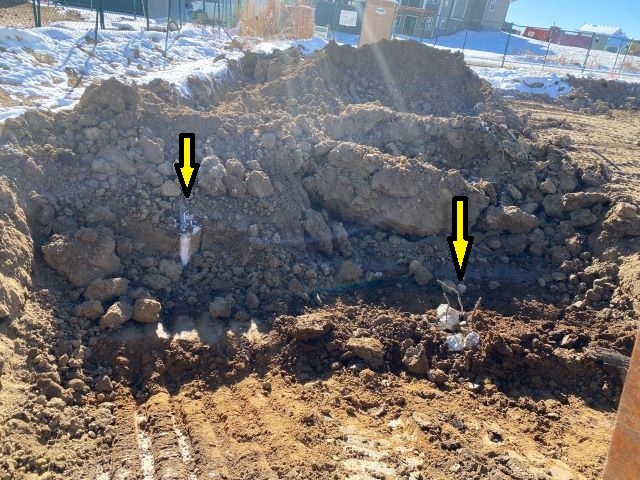

Caissons left in during demolition
-

Caissons left in during demolition
-

Caissons left in during demolition
-

Soil from excavation stored on adjacent lot
-

Excavation begins
-

Excavation begins
-

Ramp into excavation
-

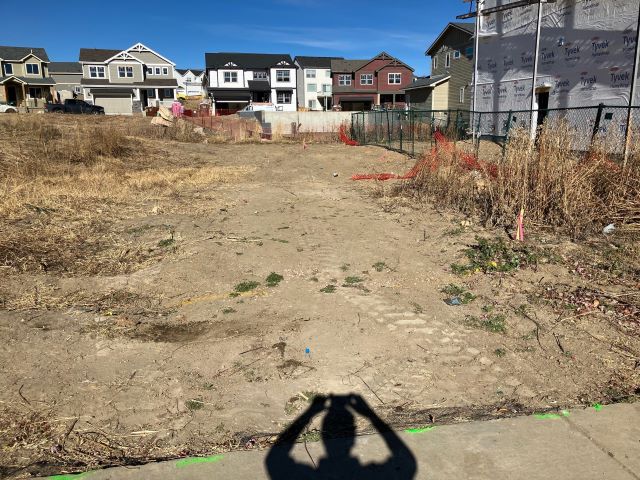

Lot staked
-

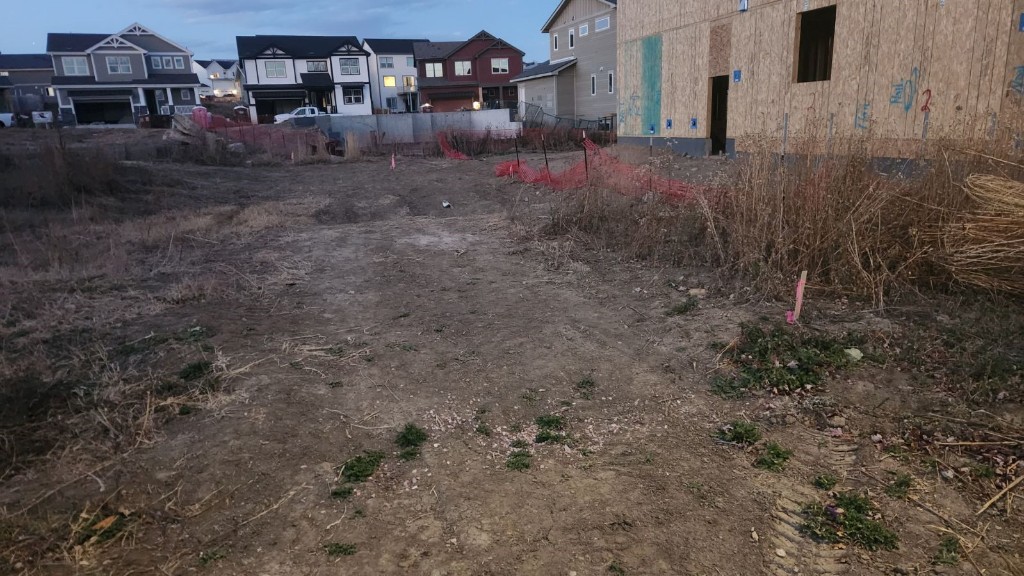

Lot clean by Paul & staking
-

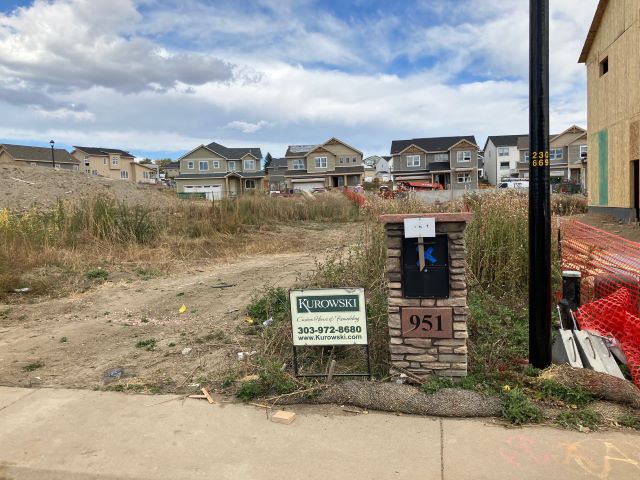

Lot before cleanup
-

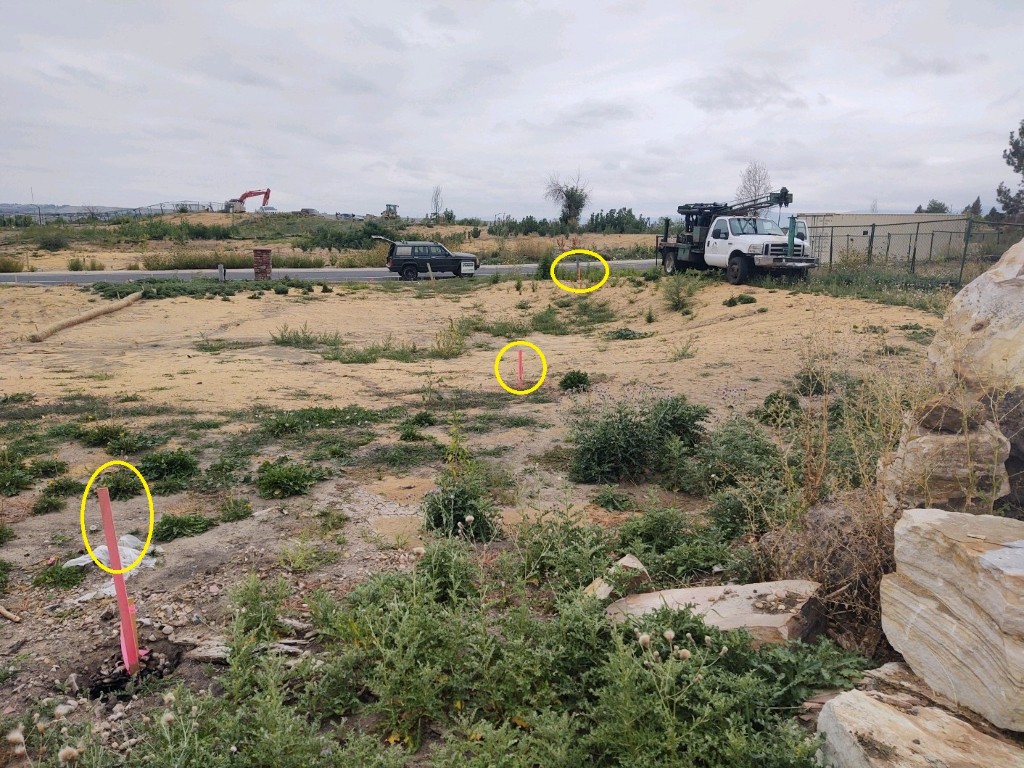

Lot staked for soils test
-

Lot staked for soils test
-
_thumb.jpg)
I broke ground! (Loud hurray & applause with gloves on)
-

Ground breaking
-

Maybe not!
-

Maybe!
-

But, let's see if it is for ground breaking of frozen ground
-

It's for digging around flowers & shrubs when the ground is not frozen
-

Oh, it even has instructions
-

Groundbreaking
-

Thank you all for braving the cold & snow
-

What a great group of friends
-

This is John, my builder
|
